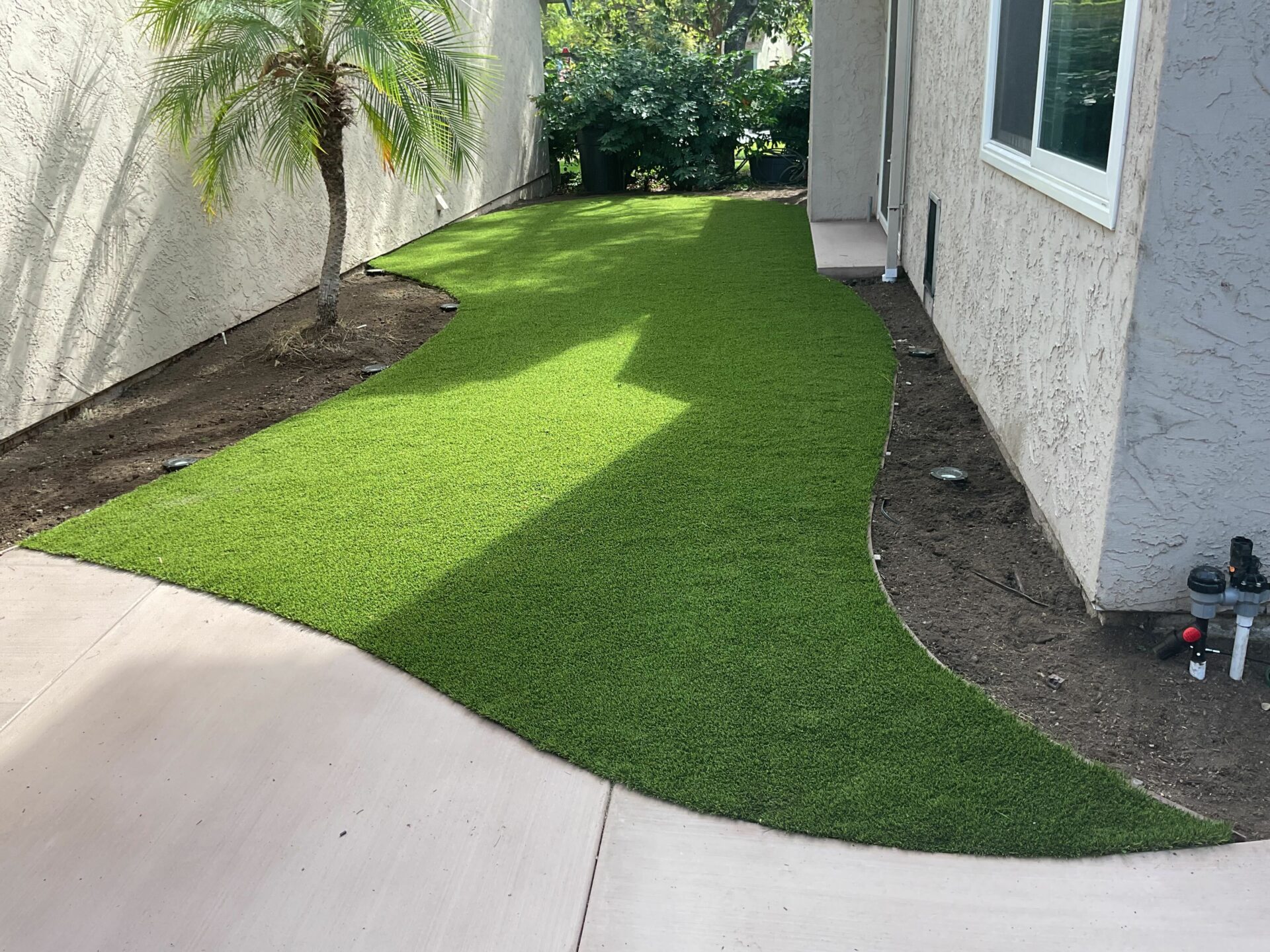

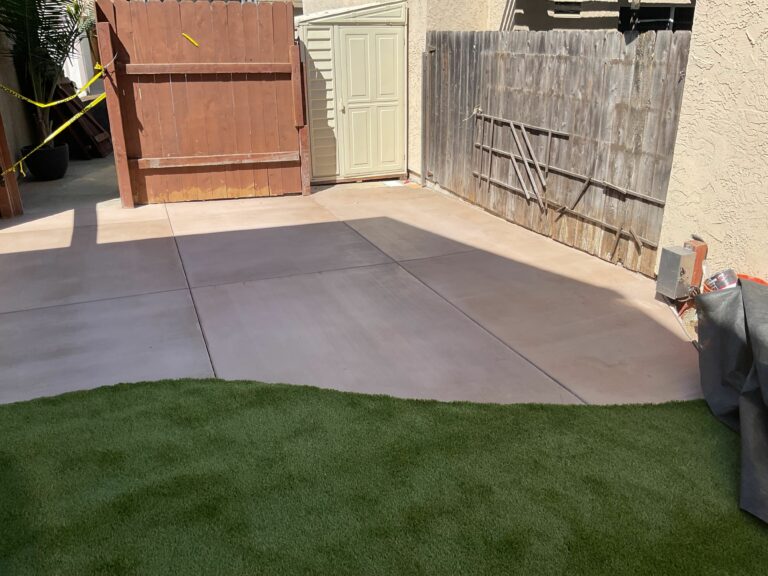

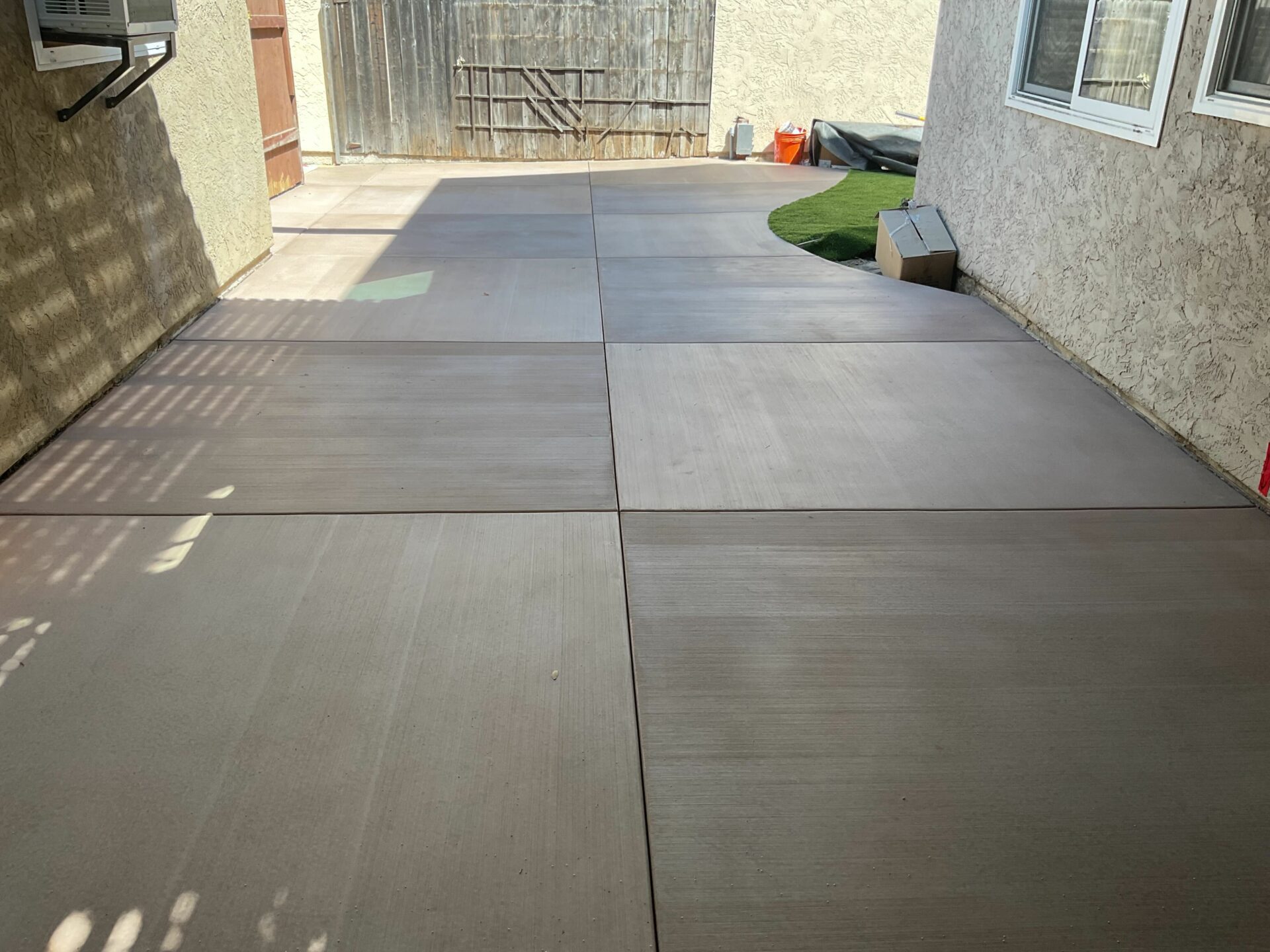

The rebuilt side yard with new control-joint concrete panels and a turf strip tucked against the foundation.

Tierrasanta Backyard, Rebuilt in Concrete and Turf

This finished project was a $23k-$31k build.

Project Snapshot

Location Tierrasanta, San Diego (92124)
Style Modern
Timeline 16 working days (August 28 to September 19, 2025)
Price Range $23k-$31k

Approximately 509 sf of stained, saw-cut, broom-finished poured concrete patio; Imperial Coronado Platinum artificial turf, 290 sf; SGW Envirofill, 9 bags; SGW weed cloth; Imperial Nails; 80 mow-strip/paver-on-edge units at the turf perimeter; topsoil for planting areas.

125 lf of 3-inch SDR35 drain line with straight couplers and elbows supported the yard drainage scope; subgrade and aggregate base graded to fall toward drain inlets and away from the house.

11 Pro-Trade IG1 in-ground lights, Pro-Trade 150W stainless steel transformer, 12/2 low-voltage wire, and smart socket timer.

August 28 to September 19, 2025, 16 working days on site.

Project Story

Overview

On a compact Tierrasanta hillside lot, the worn concrete and bare side yard were replaced over 16 working days with a broom-finished, saw-cut concrete patio meeting 290 sf of artificial turf, with integrated drainage and 11 in-ground lights wired to a timer.

The Challenge

  • The yard needed a documented drainage path coordinated with the new hardscape, turf, and finish grades.

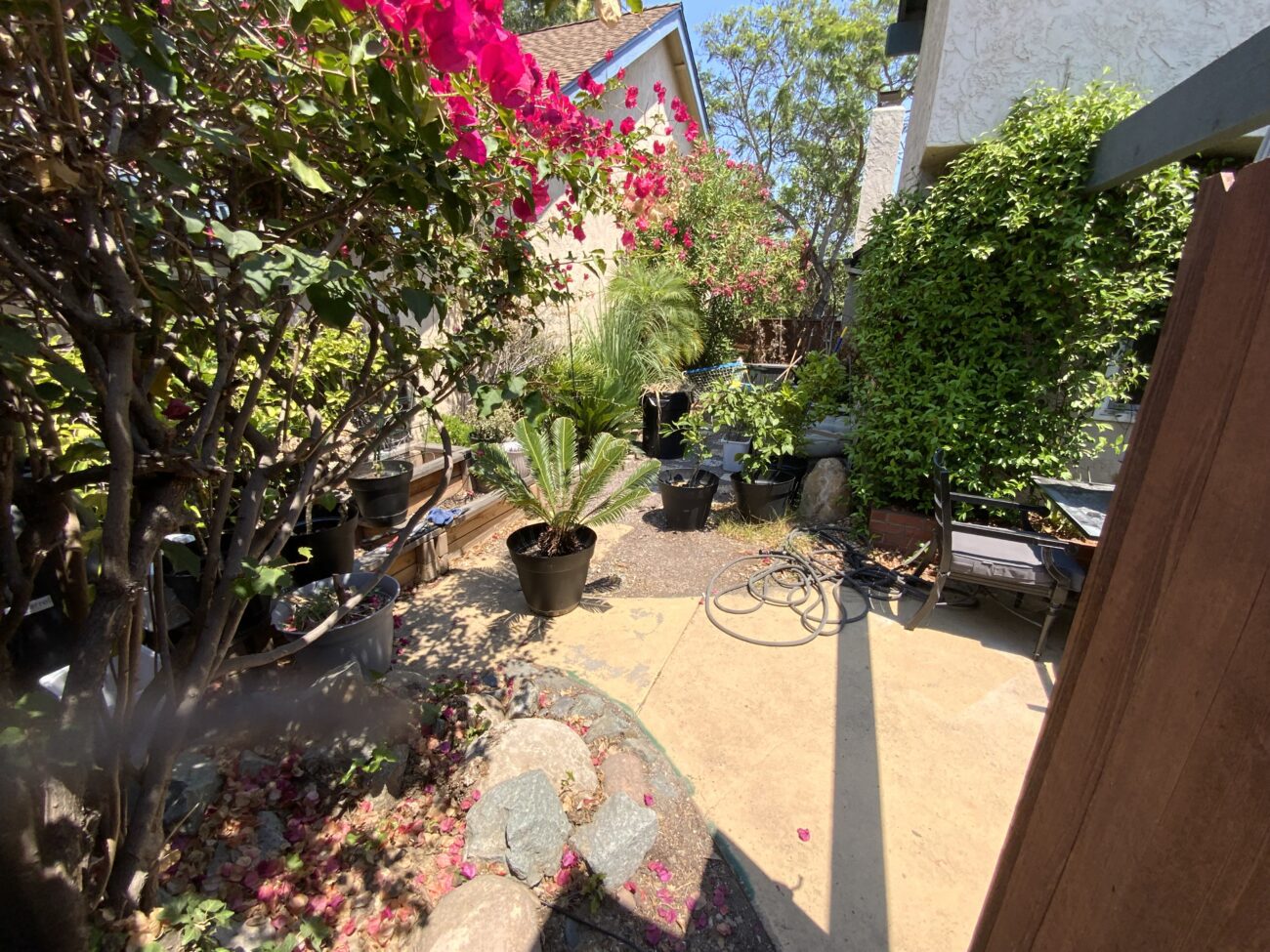

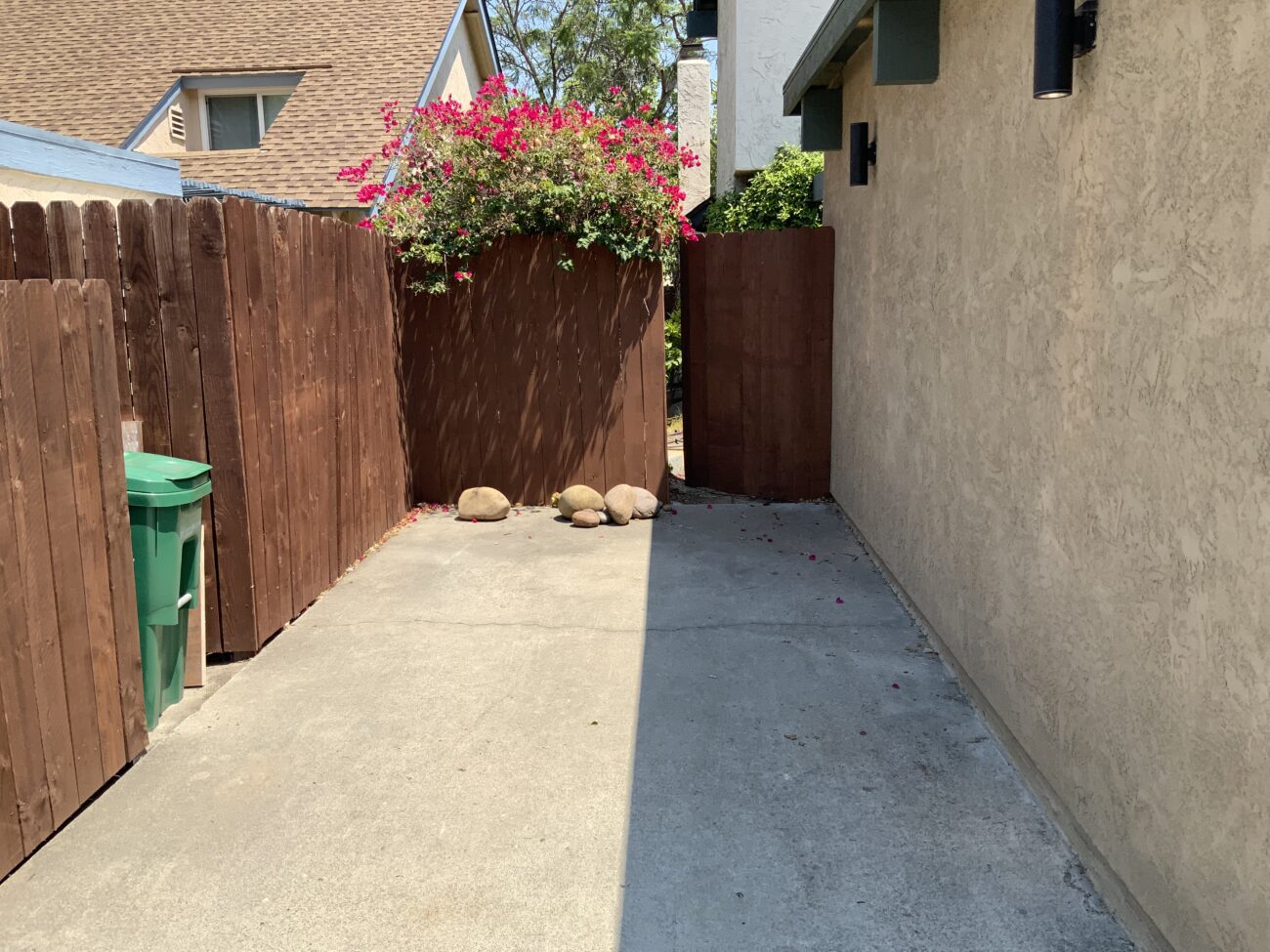

  • The backyard and side yard sat as bare soil and overgrown groundcover, leaving the household with no usable outdoor surface.
  • After dark, there was no exterior lighting on the patio, so the space went unused most evenings.

What Changed

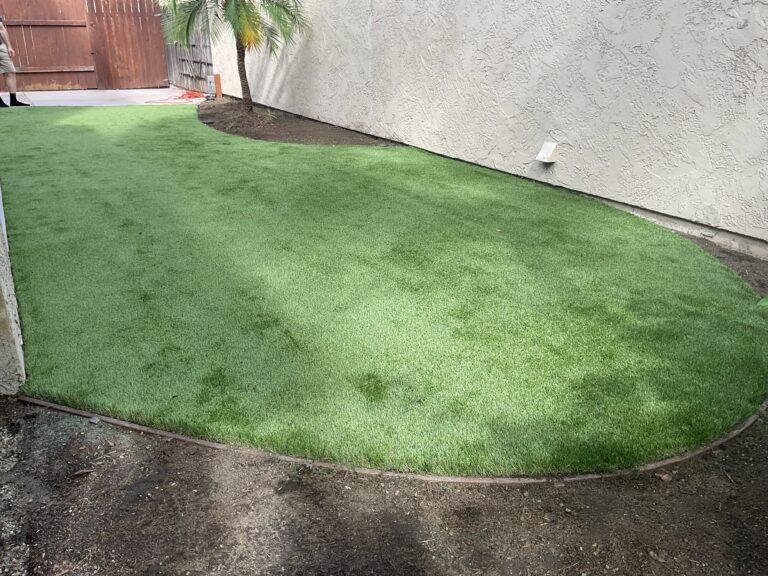

The finished space includes a broom-finished, saw-cut, stained concrete patio with a control-joint grid, 290 sf of Imperial Coronado Platinum turf at the patio's adjacent edge, the integrated SDR35 drainage runs, mow-strip detail at the turf perimeter, and 11 in-ground lights on a timer.

How INSTALL-IT-DIRECT Helped

The homeowner needed a more usable patio surface, a clean turf area, working drainage, and lighting. The work covered demo, regrading, the new poured concrete surface, the turf field, drainage, and the lighting, all coordinated so the slab pour, turf install, and final electrical happened in the right order on a compact, grade-changing lot.

Over 1,000 five-star reviews and 1,500+ San Diego homeowners served.

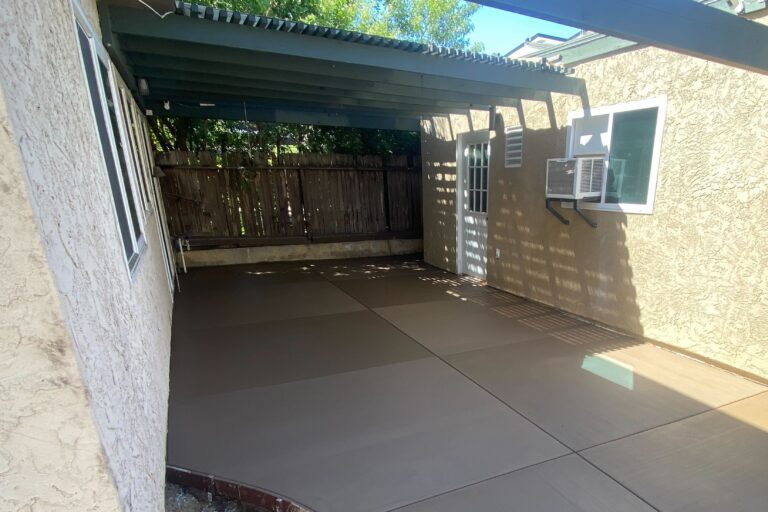

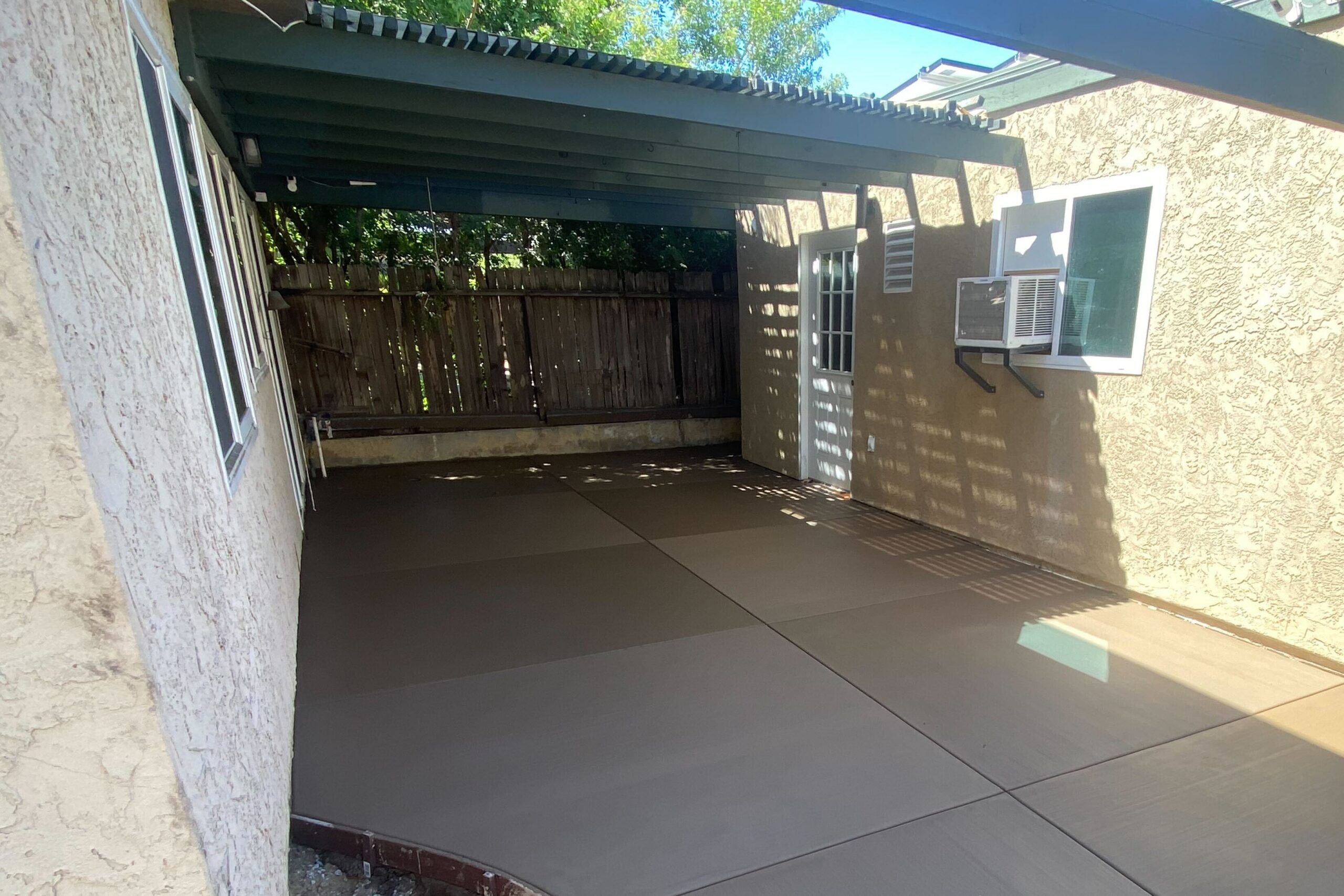

Cropped view of colored concrete patio with saw-cut control joints under the existing pergola in Tierrasanta.
Under the existing pergola, the concrete carries the same control-joint pattern as the open patio.

Design & Build

The Plan

  • Approximately 509 sf of stained, saw-cut, broom-finished poured concrete patio in a single bay, with control joints set on a grid for a deliberate, finished look.

  • 290 sf Imperial Coronado Platinum artificial turf with SGW Envirofill and weed cloth, held tight against the foundation so the side yard becomes a continuous planted edge, not a leftover corridor.

  • 125 lf of 3-inch SDR35 drain line with couplers and elbows, run with the layout so every hardscape area has a defined path for water to leave the pad.

  • 11 Pro-Trade IG1 in-ground lights wired to a Pro-Trade 150W transformer with a smart socket timer, evening use was the whole point.

  • Mow-strip / paver-on-edge detail at the turf perimeter to hold the turf-to-planted-edge transition clean.

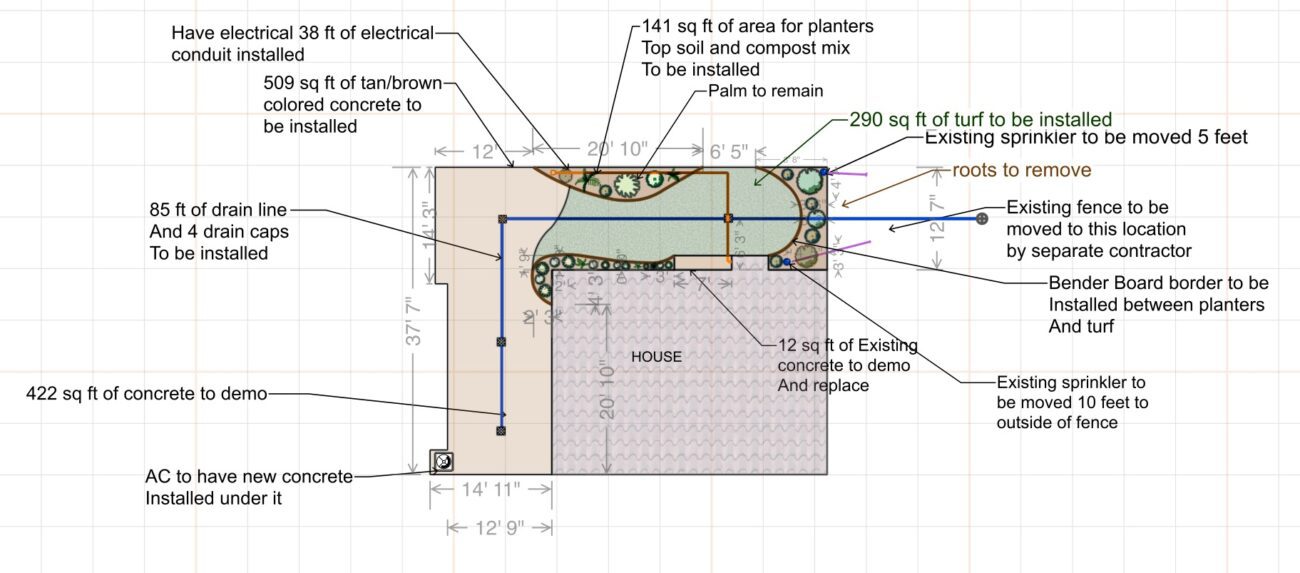

See the 2D plan drawing
Project plan

The Build

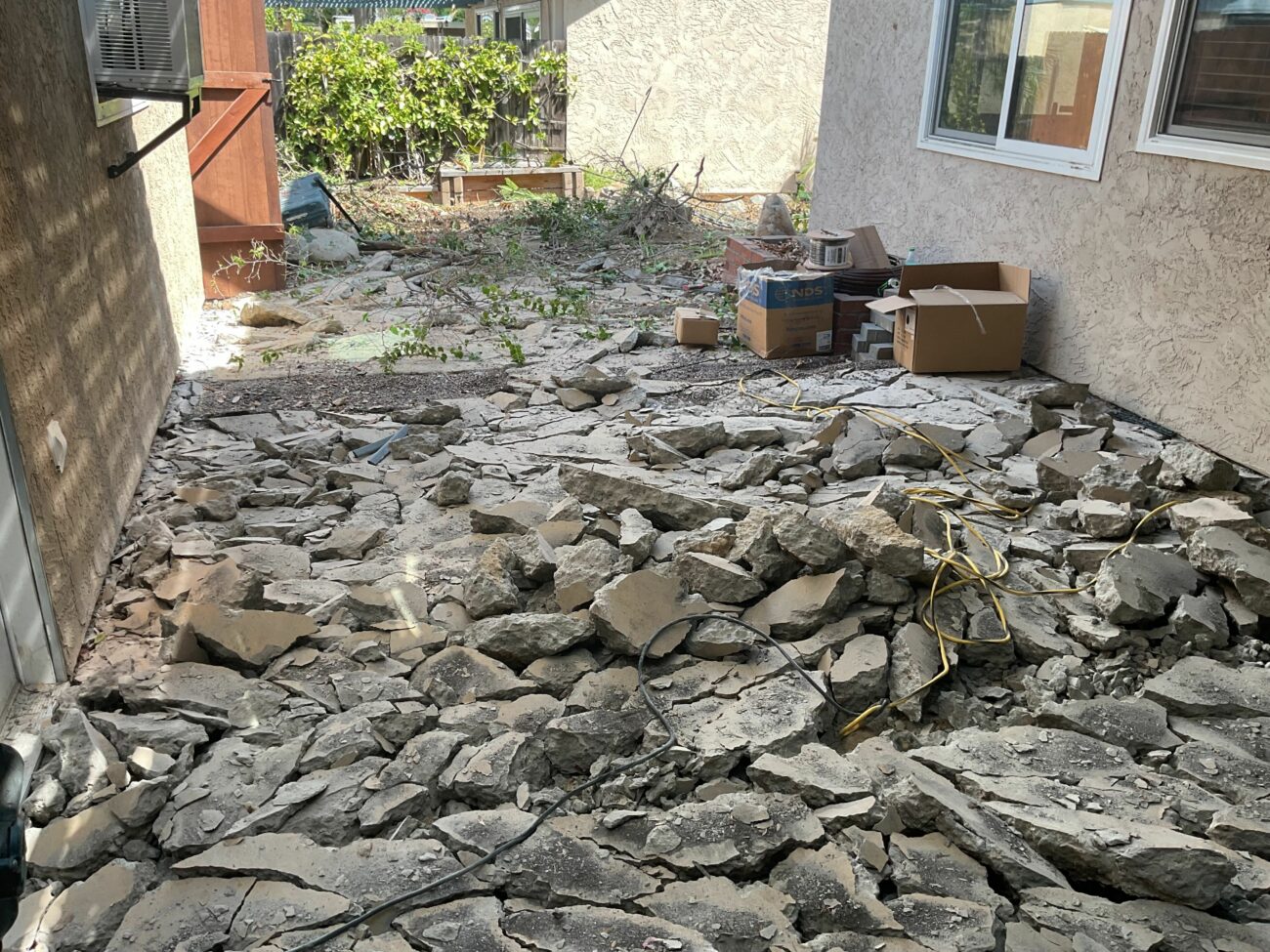

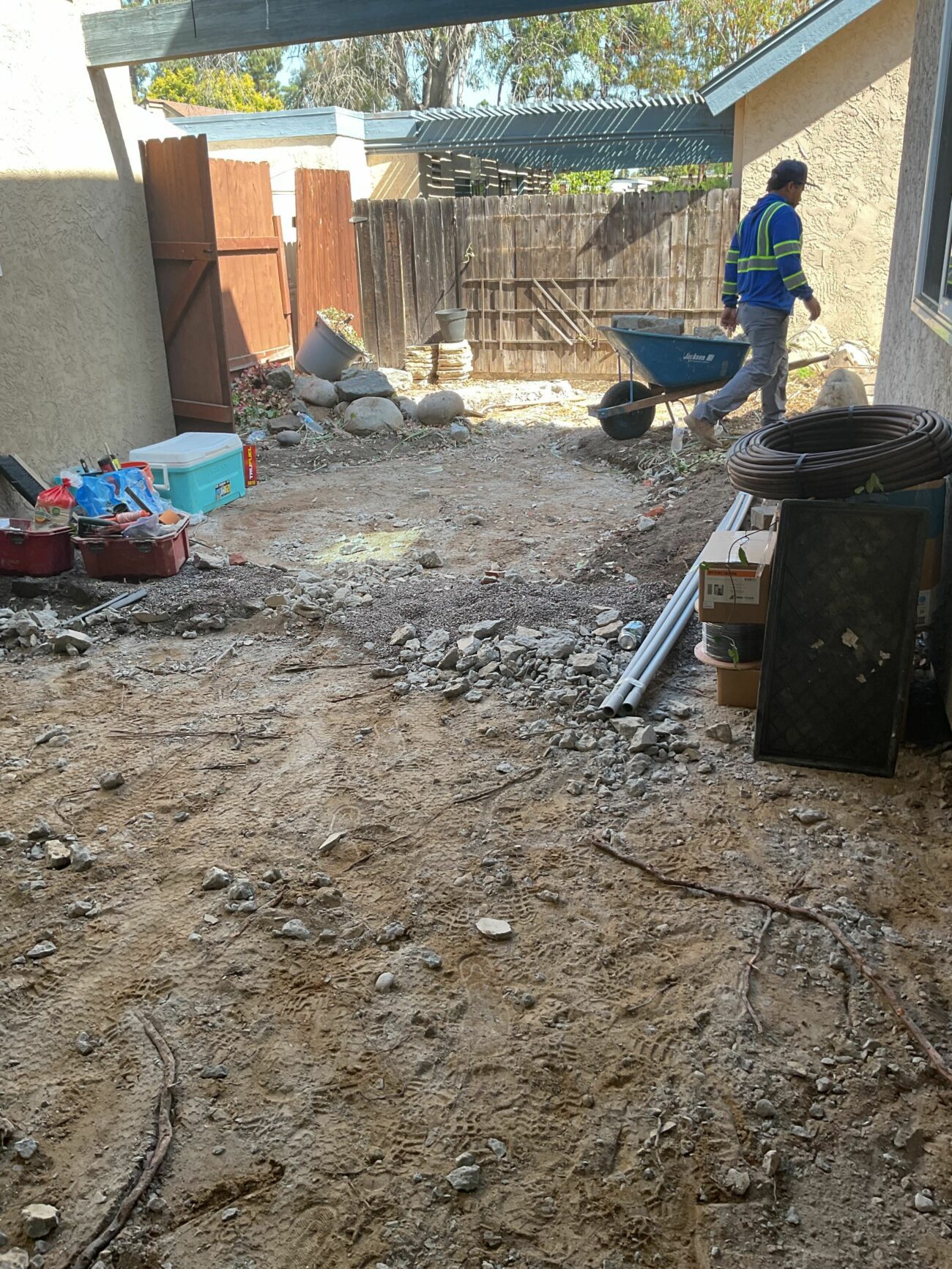

Demo and Base Prep

Existing surfaces and overgrown groundcover were removed, the patio footprint was graded, and base prep was completed for the concrete pour and the turf zone.

Drainage

125 lf of 3-inch SDR35 drain line was installed with couplers and elbows, tied in during base prep before the slab pour so subgrade and aggregate fall toward the drain inlets and away from the house.

Concrete Pour and Turf

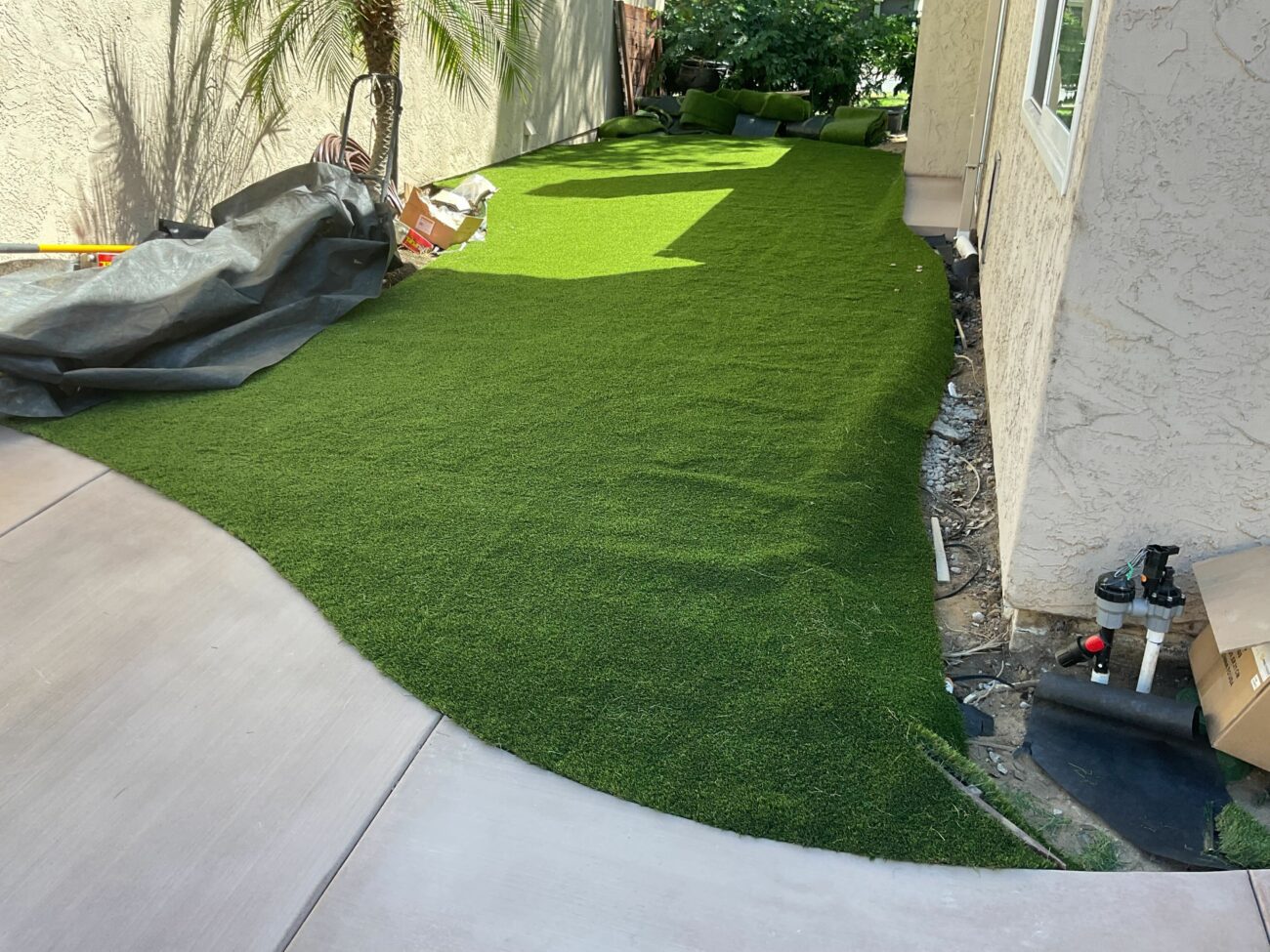

The patio surface was poured as broom-finished, saw-cut, stained concrete; the 290 sf of Imperial Coronado Platinum turf was installed with infill and weed cloth adjacent to the new slab so the two surfaces meet at a clean edge.

Lighting and Irrigation

Eleven Pro-Trade IG1 in-ground lights were connected to a transformer and timer. Irrigation scope included a drip valve and two relocated sprinkler heads.

Frequently Asked Questions

Does artificial turf require HOA approval in San Diego?

HOA and permit requirements vary by property and should be verified with your local HOA and the City of San Diego before construction. Tierrasanta is a hillside community with grade and drainage rules that often shape what hardscape and turf changes are permitted.

How long did this Tierrasanta concrete and turf project take?

August 28 to September 19, 2025, 16 working days on site. The schedule covered demo and base prep, drainage, the concrete pour and stain, the turf install, and the lighting and irrigation final.

What was included in the hardscape and turf scope?

The scope included approximately 509 sf of stained, broom-finished, saw-cut concrete patio, 290 sf of Imperial Coronado Platinum turf, 125 lf of SDR35 drainage, mow-strip and paver-on-edge detail at the turf perimeter, irrigation work, and 11 in-ground lights on a transformer and timer.
