Finished residential backyard patio featuring large scored concrete paver panels with darker border joints, adjacent to...

Backyard Reimagined in Stone Canyon, San Marcos

Overview

A San Marcos homeowner in the gated Stone Canyon community replaced a patchy, overgrown backyard with 2,372 square feet of artificial turf, a built-in outdoor kitchen island, and a stuccoed fireplace. The project also included a new 40-linear-foot gas line, drainage, stepping stones, and fresh planting beds to complete the space.

Quick Facts

City San Marcos

Neighborhood San Marcos

Constraints/Challenges An existing gas line for the outdoor fireplace had no visible surface access point, requiring underground location work before trenching. Gas line trenching through rocky native soil uncovered multiple broken irrigation lines, including a main line, adding repair scope mid-install. The backyard is situated on a sloped lot within a gated HOA community, which required design submission review.

Goals The homeowner wanted to replace an underused, overgrown backyard with a low-maintenance turf lawn anchored by a functional outdoor kitchen and fireplace, creating a space suited for everyday family use and entertaining.

Scope 2,372 sf artificial turf, 313-piece paver mow strip border, 41 stepping stones set in concrete, 122 sf concrete flatwork, stuccoed outdoor kitchen island with grill and double side burner, stuccoed outdoor fireplace, 40 lf gas line, 20 lf SDR35 drain line, 1,421 sf mulch/bark planting beds, drip irrigation, 20 five-gallon plants

Style Modern

Timeline About 5 build weeks

Price Range $57k–$70k

The Challenge

  • The backyard was covered in patchy natural grass, overgrown shrubs, and bare soil, making it difficult to use for outdoor activities or entertaining.
  • An aging concrete patio and disconnected existing fireplace sat largely unused because the surrounding landscape offered no comfortable or functional gathering space.
  • Without a working outdoor kitchen or reliable gas connection, summer evenings outdoors meant hauling equipment in and out rather than relaxing in the yard.

How Install It Direct Helped

The homeowner had a large backyard in a sought-after gated community that offered almost no usable outdoor living space — overgrown, patchy, and lacking any functional cooking or gathering area. Install It Direct designed a full backyard overhaul anchored by 2,372 square feet of Pro-Trade Rye synthetic turf, a stuccoed outdoor kitchen island fitted with a 40-inch propane grill and double side burner, and a refinished outdoor fireplace tied into a new 40-linear-foot gas line. When underground obstacles were discovered during gas line trenching, including broken irrigation lines and dense rock, the crew repaired the irrigation system on the spot and kept the project moving. Today the backyard is the family's primary outdoor room — fire lit, food on the grill, and a lawn that stays green without any watering.

Market Context

Backyard transformations in San Marcos gated communities that combine large-area synthetic turf with a built-in outdoor kitchen and gas fireplace typically range from the mid-$50s to low-$70s, with cost driven primarily by turf square footage, gas line complexity, and kitchen appliance selections.

Neighborhood Context

Stone Canyon is a gated community within Discovery Hills in western San Marcos (92078), characterized by sloped lots, HOA architectural oversight, and views toward the surrounding hills — a setting where low-maintenance outdoor living spaces command consistent demand.

The Plan

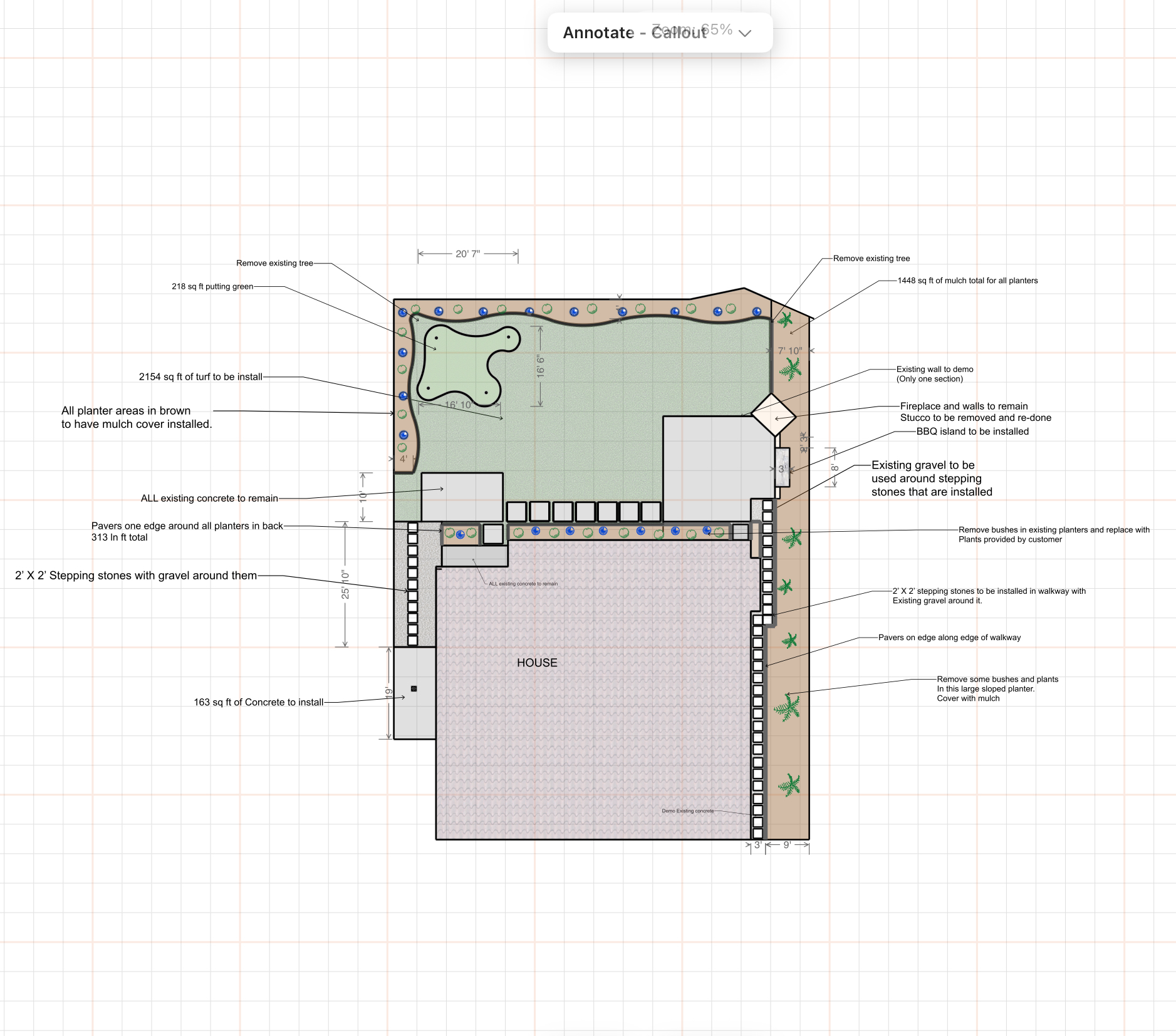

Project plan
  • Layout placed the outdoor kitchen island and fireplace at the focal end of the yard, with 2,372 sf of Pro-Trade Rye synthetic turf filling the main lawn area and stepping stones creating a walking path across it.

  • A 313-piece paver mow strip border, set in concrete, defines the turf perimeter and separates the lawn from surrounding planting beds filled with 1,421 sf of shredded fir mulch and 20 five-gallon plants.

  • A 40-linear-foot gas line was trenched from the existing supply to serve both the built-in grill and the outdoor fireplace; broken irrigation lines discovered during trenching were repaired before backfill.

  • Drainage was addressed with 20 linear feet of 3-inch SDR35 pipe, PVC fittings, and drain caps routed to direct surface water away from the house foundation in compliance with CRC R401.3 slope requirements.

  • The outdoor kitchen island was assembled from Eldorado Outdoor modular cabinets (a 60-inch and a 36-inch unit) faced with stucco and fitted with four appliance cutouts; the existing outdoor fireplace received a full stucco refinish to match.

  • A drip irrigation zone was added for the new planting beds, including up to 40 feet of Schedule 40 3/4-inch PVC, drip line, pressure regulator, and up to 15 emitters connected to the existing water source.

The Build

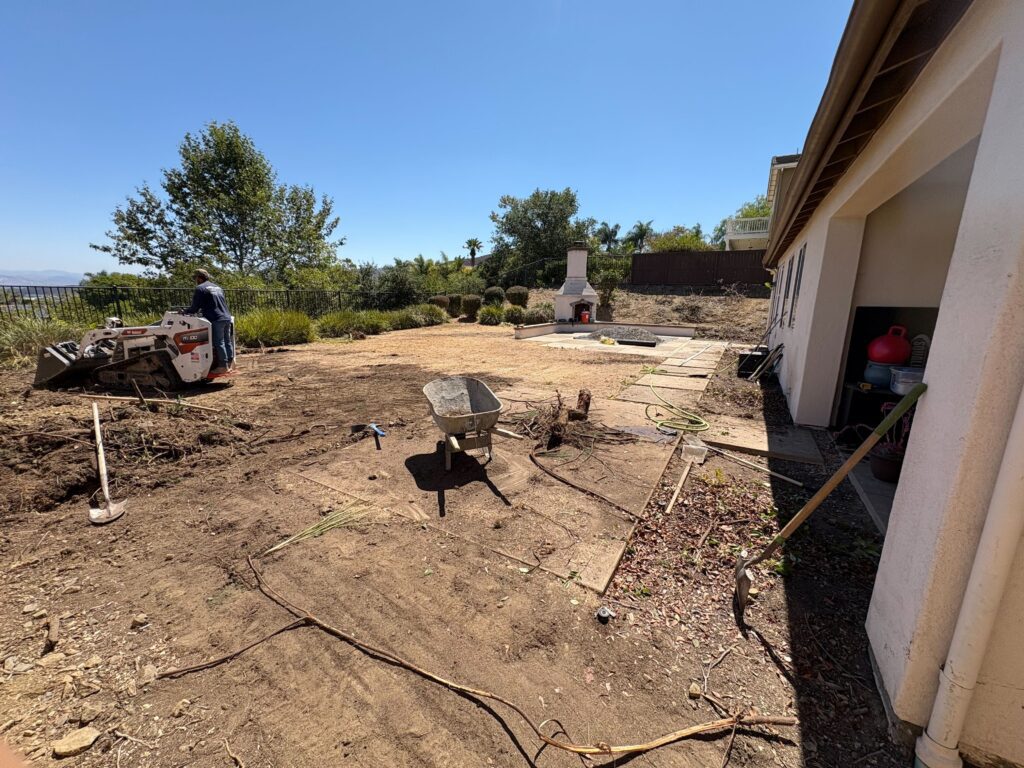

Demolition began with removal of existing shrubs, ornamental grasses, and planting debris, hauled away in two large loads. Approximately 297 sf of soil was excavated to turf-prep depth, 45 sf of existing wall and footing were demolished, and 9 sf of non-paving concrete was removed. General labor addressed site access and debris staging.

A 40-linear-foot gas line trench was excavated to reach the existing supply point for the fireplace and the new kitchen island location. The trench encountered dense rock and multiple broken irrigation lines, including a main line, which were repaired before the gas line was set and the trench backfilled.

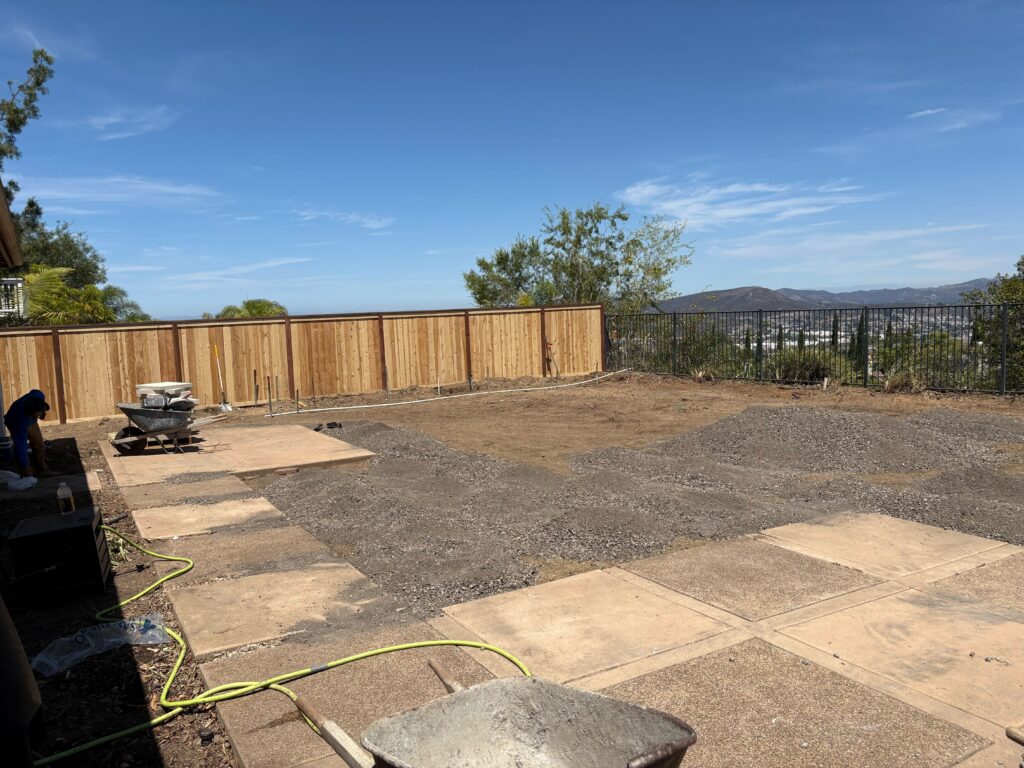

Subgrade was compacted with a ride-on compactor. Approximately 122 sf of concrete flatwork was poured for pads and transitions; forms remained in place through an additional cure day required after rain before BBQ island construction could begin on the adjacent surface.

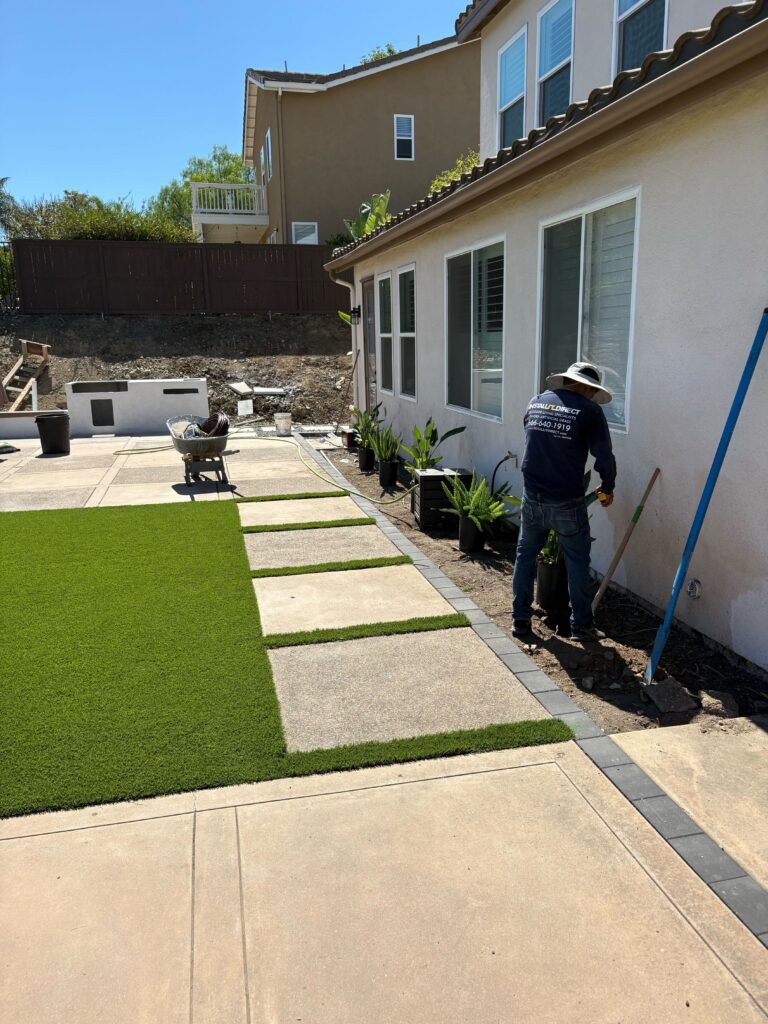

A 313-piece paver mow strip was set in concrete around the turf perimeter. Forty-one stepping stones were set in concrete across the lawn area. The 20-linear-foot SDR35 drain line, elbows, couplers, and drain caps were installed and connected.

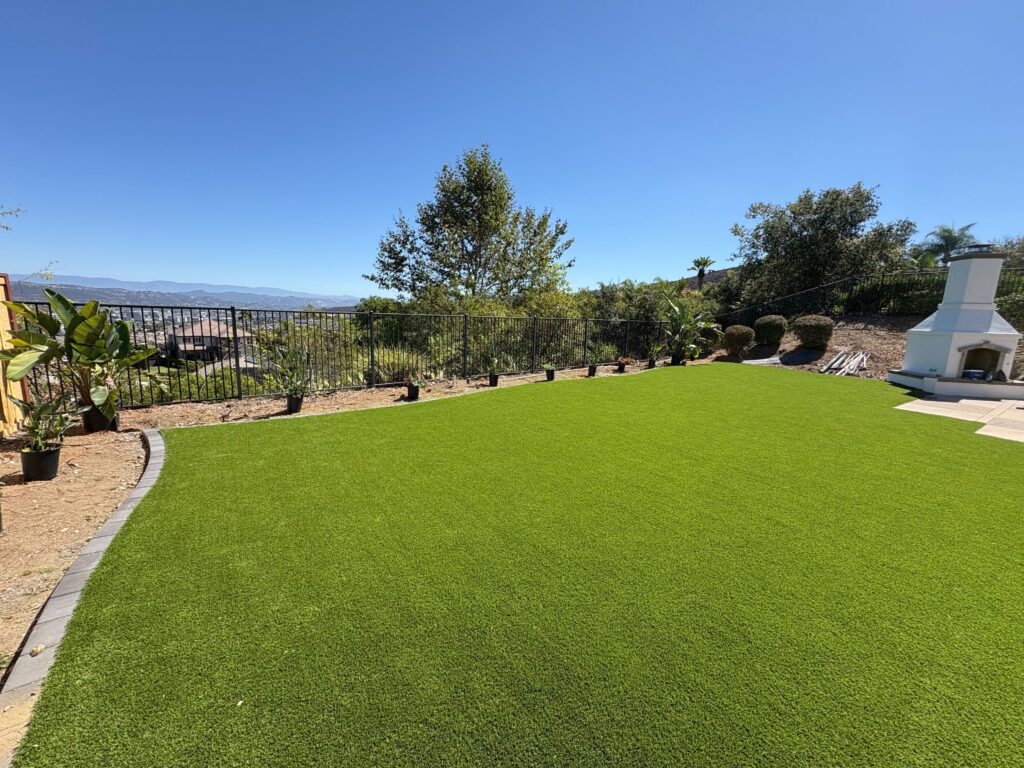

Weed barrier was laid across the prepared subgrade before Pro-Trade Rye synthetic turf rolls were cut and fitted to the 2,372 sf lawn area. Turf was secured with 5-inch 40D nails and infilled with 71 bags of SGW Envirofill green silica infill.

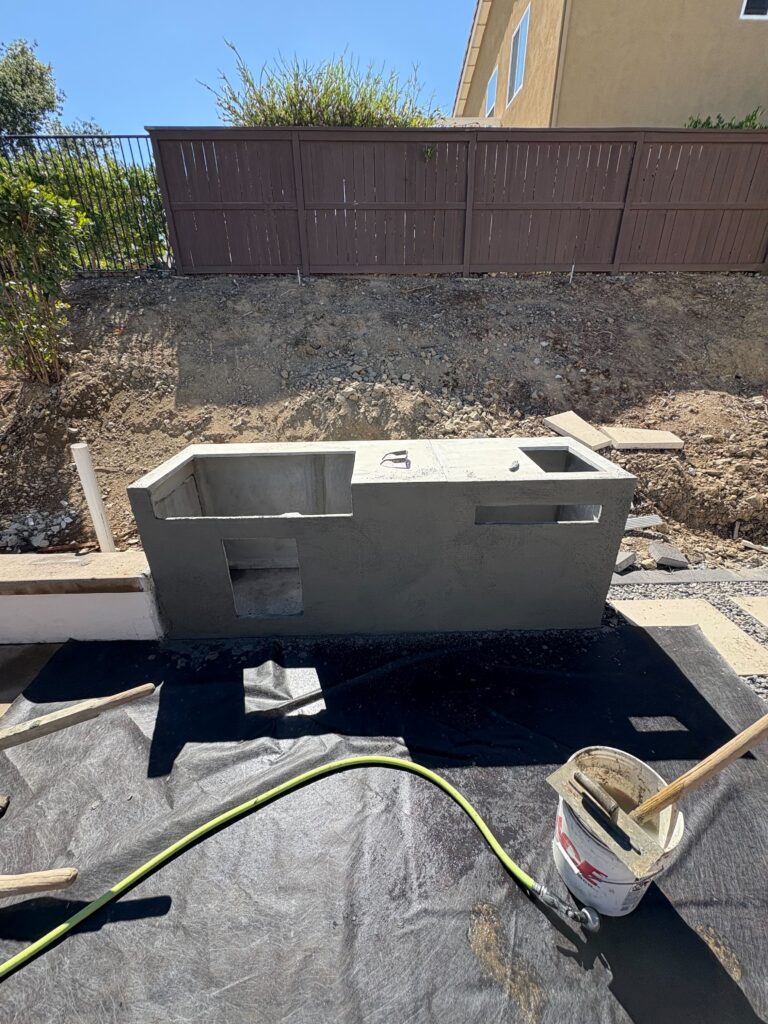

Eldorado Outdoor modular cabinet frames were assembled and stuccoed; four appliance cutouts were made and the Sizzler PRO 40-inch propane grill, double side burner, vented access door, and related hardware were installed. The outdoor fireplace received a full stucco finish to match the island. Planting beds received topsoil-compost mix, 20 five-gallon plants, 1,421 sf of shredded fir mulch, and the drip irrigation system was connected.

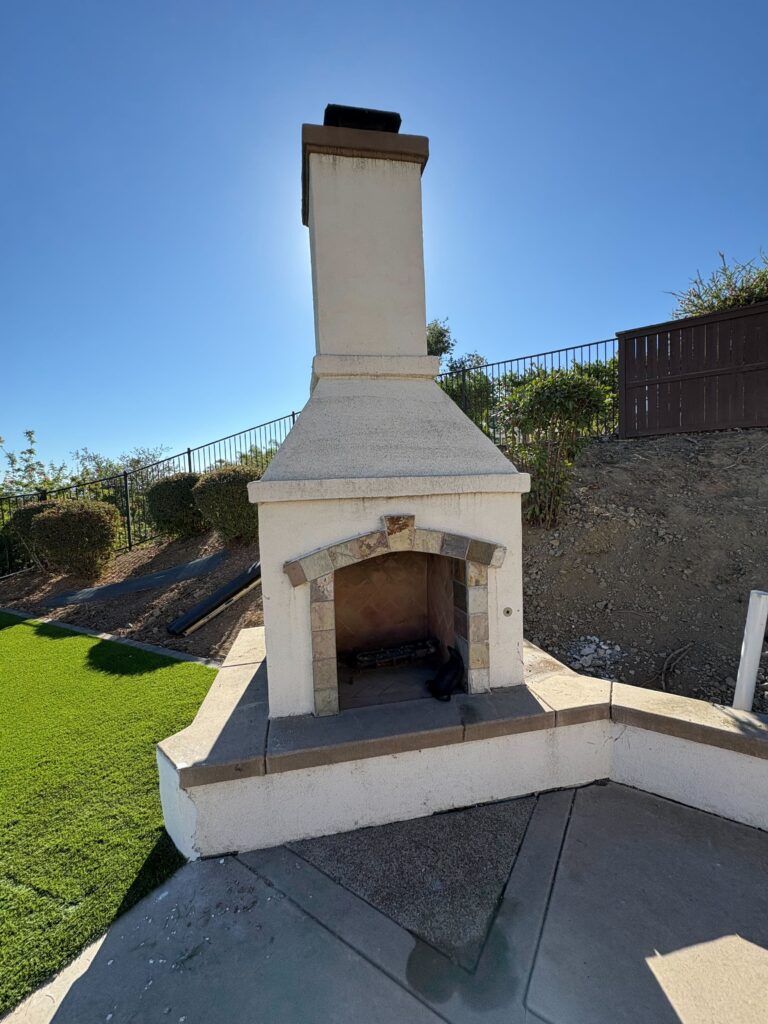

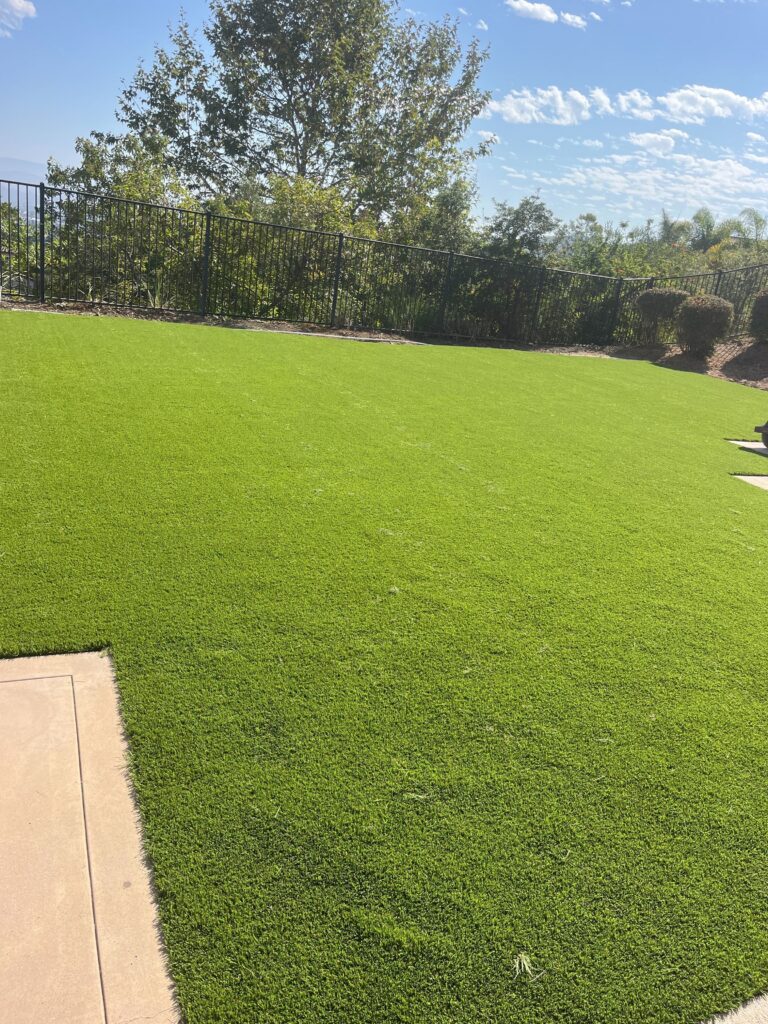

The Result

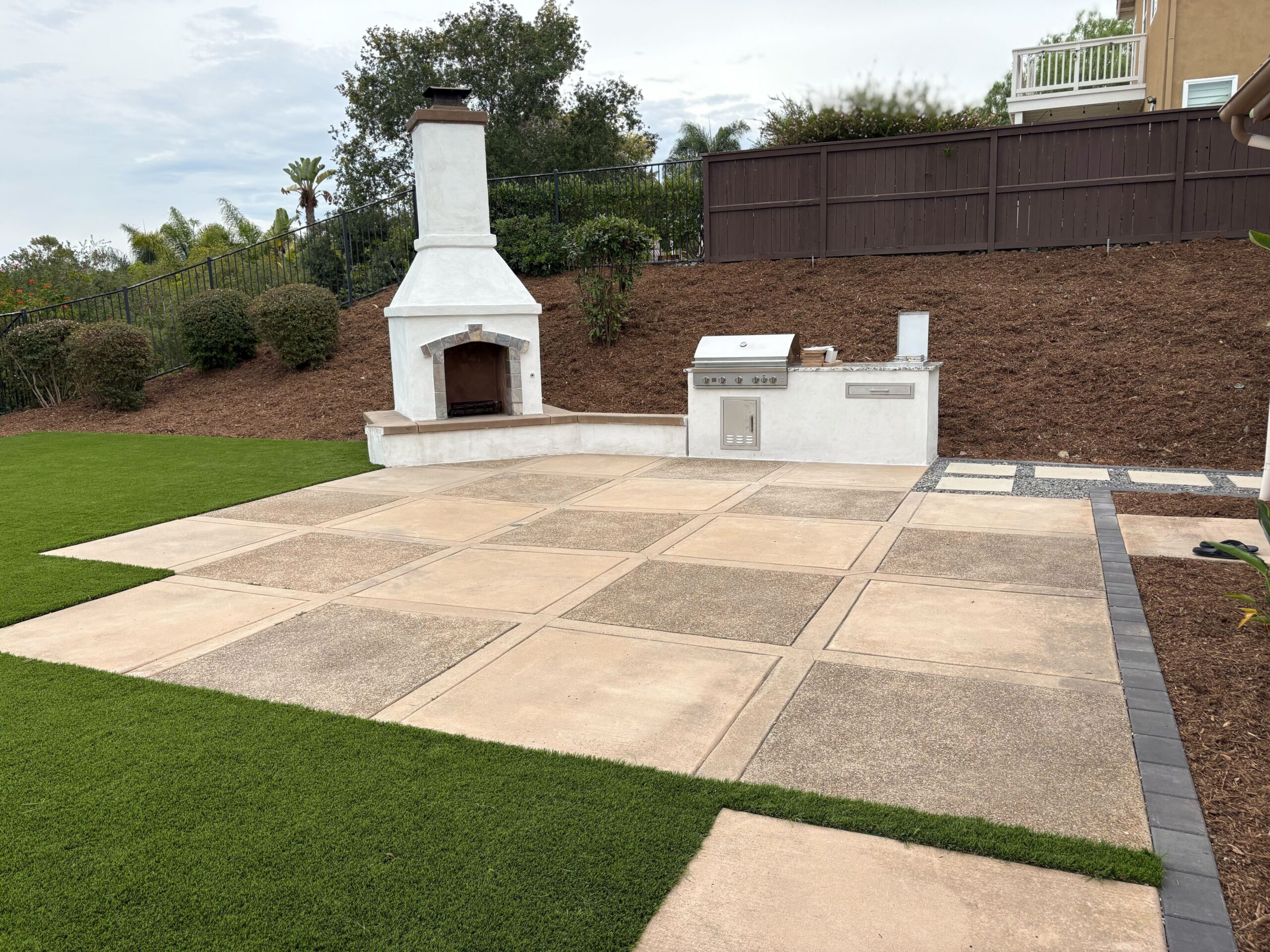

A patchy, overgrown backyard became a fully functional outdoor living space anchored by 2,372 sf of Pro-Trade Rye artificial turf edged by a 313-piece concrete-set paver mow strip, 41 stepping stones, and surrounding planting beds. The built-in outdoor kitchen island and stuccoed fireplace, both connected to a new 40-linear-foot gas line, turned an unused concrete pad into a year-round cooking and gathering destination.

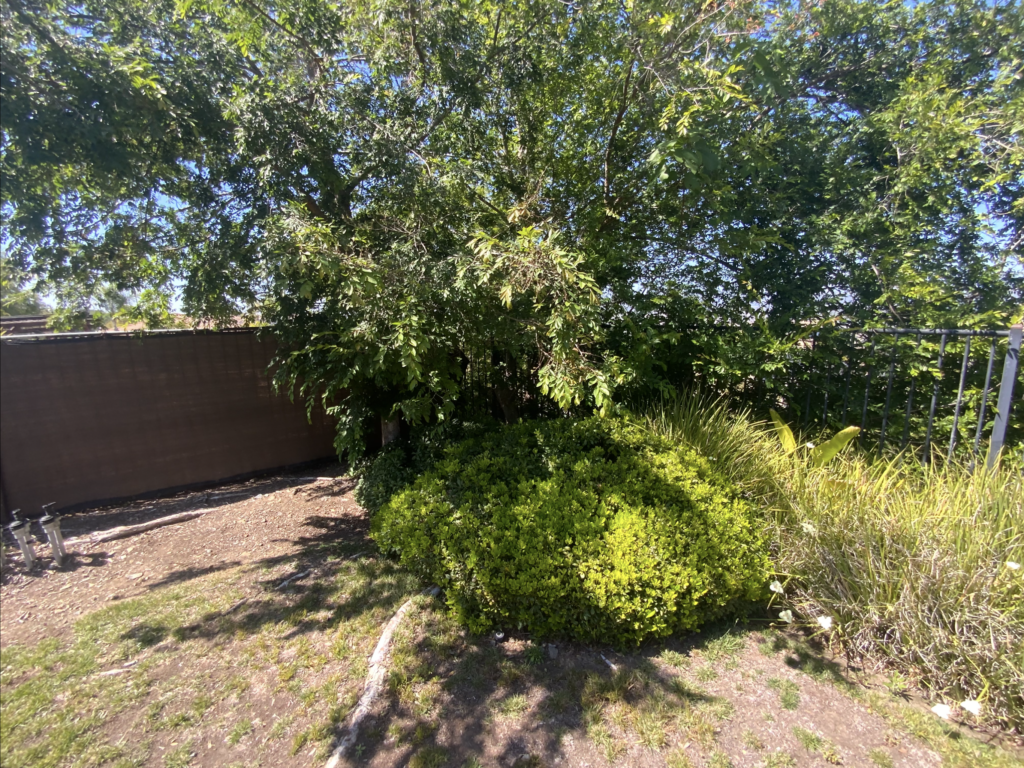

Existing residential backyard with overgrown shrubs and shade trees, patchy natural turf and exposed bare soil in the...
BEFORE

Existing residential backyard with overgrown shrubs and shade trees, patchy natural turf and exposed bare soil in the planting area. Photo appears to document the site condition prior to any demolition or grading work for a landscape or paver project.

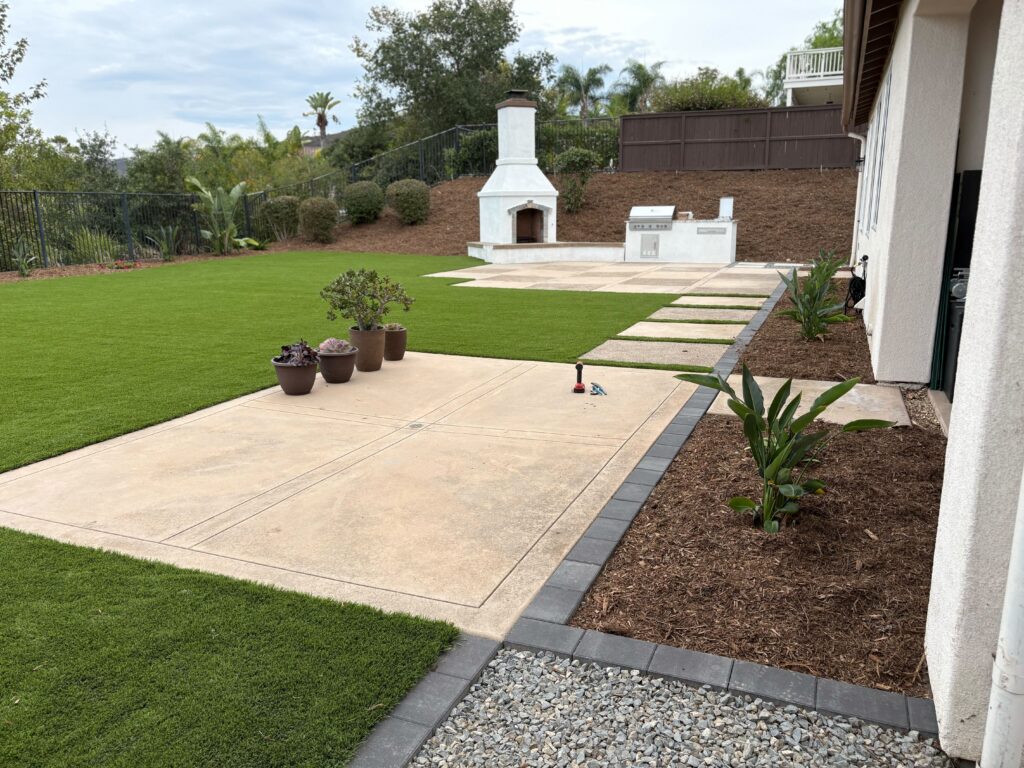

Finished backyard landscape showing an artificial turf lawn with large concrete stepping pavers leading to a built-in...
AFTER

Finished backyard landscape showing an artificial turf lawn with large concrete stepping pavers leading to a built-in outdoor fireplace and outdoor kitchen. A concrete pad and paver edge define a patio area with fresh mulch beds and new plantings along the house.

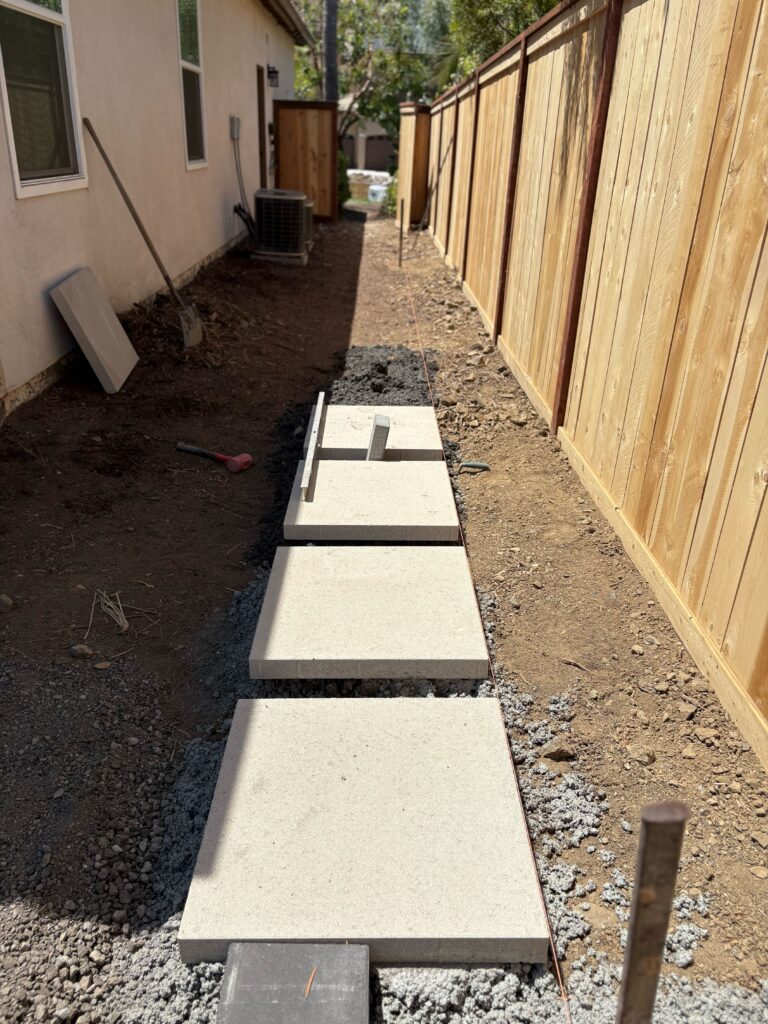

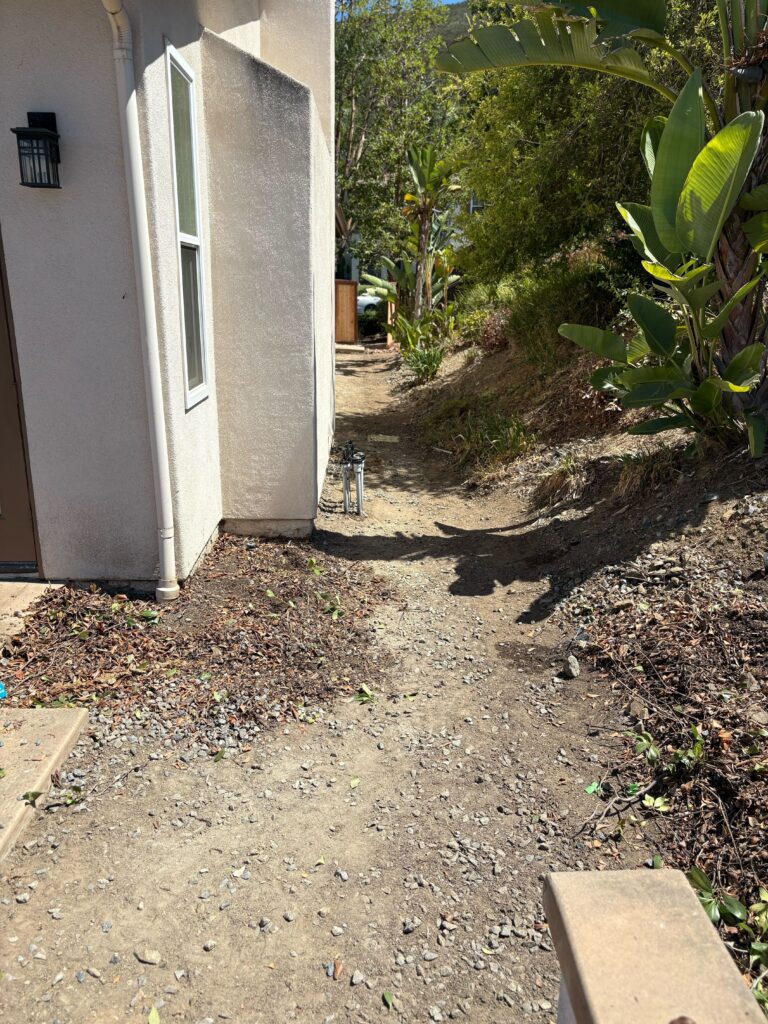

Narrow residential side yard with a compacted dirt access path running alongside a stucco exterior wall and down a...
BEFORE

Narrow residential side yard with a compacted dirt access path running alongside a stucco exterior wall and down a moderate slope. Existing vegetation and exposed soil suggest the area is a pre-construction condition likely staged for a future walkway or paver installation.

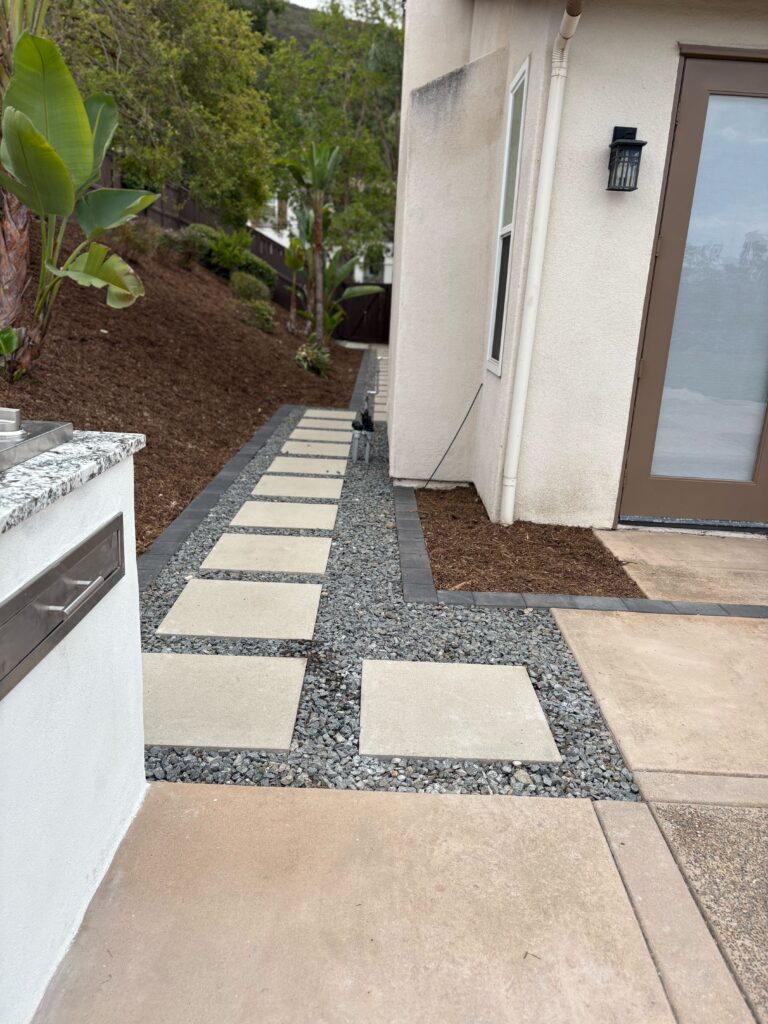

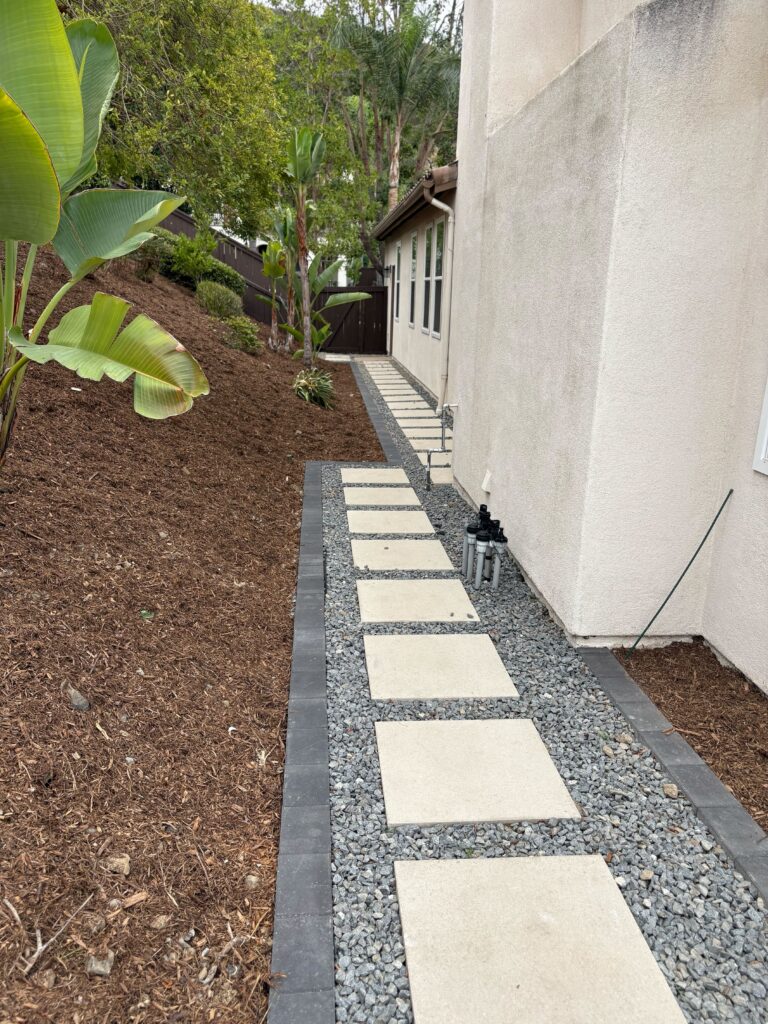

Finished side-yard installation showing rectangular concrete stepping pads set in compacted decorative gravel with a dark...
AFTER

Finished side-yard installation showing rectangular concrete stepping pads set in compacted decorative gravel with a dark interlocking paver soldier-course border adjacent to artificial turf and a mulched planting bed. A brown wood privacy fence and house downspout are visible, indicating a completed, clean installation in a residential backyard.

Artificial turf: Pro-Trade Rye Professional Synthetic Turf, 81 oz. face weight / 107 oz. total weight, 2.0-inch pile, blended beige/emerald/field green/lime blades with green/brown thatching — 2,372 sf installed
Turf infill: SGW Envirofill Green 16/30 — 71 bags
Weed barrier: Imperial Weed Barrier (6×300 ft) — 2 rolls; SGW Weed Cloth (6×250 ft) — 2 rolls
Turf fasteners: Imperial Nails 5-inch 40D — 5 boxes (50 lb each)
Mow strip: standard pavers set in concrete — 313 pieces
Stepping stones: set in concrete — 41 each
Concrete flatwork: 122 sf
Outdoor kitchen cabinets: Eldorado Outdoor Modular Cabinet, 60-inch straight (30Dx36Tx60W) — 1 unit; Eldorado Outdoor Modular Cabinet, 36-inch straight (30Dx36Tx36W) — 1 unit
Appliances: Sizzler PRO Series 40-inch liquid propane grill — 1; Double Side Burner liquid propane — 1; 18×22-inch vented access door with left side handle — 1; appliance cutouts — 4
Island hardware: Kindred Outdoor Fastener Set — 1; BBQ vents — 2
Stucco: applied to CMU block wall faces — ~246 sf; applied to cinderblock island — ~51 sf
Mulch: shredded fir (non-dyed), 2-inch thick — 1,421 sf
Plants: 20 five-gallon plants (species not documented)
Grey gravel: 1.5 units (used in transition areas)
Base prep: compacted subgrade prepared to ICPI/ASTM D 698 standard Proctor density specifications

Drainage system: 20 linear feet of 3-inch SDR35 drain pipe, 45-degree and 90-degree PVC elbows, straight PVC couplers, and three drain caps installed to route surface water away from the foundation. Sloped grading follows CRC R401.3, which requires surface drainage to fall a minimum of 6 inches within the first 10 feet away from the foundation, or a minimum 2 percent slope for impervious surfaces within 10 feet of the structure where physical constraints apply. Gas line trenching also revealed and required repair of multiple broken irrigation lines, including a main line, which were addressed before backfill.

The project is located within Stone Canyon, a gated HOA community in San Marcos. HOA design submission was required prior to construction per project channel records. An HOA compliance question about the driveway apron arose during the project and was determined to be outside IID’s scope; the homeowner was referred to a licensed inspector for that item. Under California Civil Code Section 4735, HOA rules cannot prohibit installation of artificial turf, though the HOA may impose reasonable quality and appearance standards. A gas line serving the outdoor kitchen and fireplace required coordination to locate the existing supply point before trenching; the narrative does not confirm whether a separate CPC gas line permit was pulled, and this should be verified in the permit file.

Pre-construction coordination and HOA design submission spanned several weeks before demo began. Active demolition and installation ran approximately 5 build weeks from demo start through final closeout. The original completion target was extended by roughly 3 weeks due to pre-construction scheduling delays, underground obstacles during gas line trenching, and an additional concrete cure day required after rain. Final walkthrough and project closeout occurred approximately 4 weeks after the original target completion date.
