The new stuccoed BBQ island with a Sizzler PRO grill and side burner beside the re-stuccoed outdoor fireplace, Stone Canyon, San Marcos 92078

The Outdoor Kitchen in Stone Canyon

This finished project was a $60k to $65k build.

Project Snapshot

Location Stone Canyon, San Marcos (92078)
Style Modern
Timeline About 5 weeks · Aug 18 to Sep 19, 2025
Price Range $60k to $65k

Turf: Pro-Trade Rye, 81 oz face weight, 2-inch pile, 2,372 sf; SGW Envirofill green infill; weed barrier; 5-inch nails; bender board
BBQ island: Eldorado Outdoor modular cabinets, one 60-inch and one 36-inch; Sizzler PRO Series 40-inch grill; one side burner; 26-inch utensil drawer; 18 by 22-inch vented access door; 3 vents; 4 appliance cutouts; finished in stucco
Fireplace: the existing fireplace stripped and re-stuccoed
Hardscape: 41 two-foot stepping stones set in concrete; 122 sf of concrete pads; paver mow strip set in concrete, 283 LF
Gas: 38 feet of 1-inch gas line with tracer tape in an 18-inch trench; 2 connections
Drainage: 20 LF of 3-inch SDR35 drain line, 3 drain caps
Planting: 21 plants the homeowners supplied (19 five-gallon, 2 fifteen-gallon); shredded fir mulch, 2 inches deep; topsoil and compost; a drip valve; grey gravel

The Stone Canyon HOA asked to approve the turf before work began. IID redrew the design with the drainage and every material called out, and the homeowners submitted it.

August 18 to September 19, 2025: 24 working days on the calendar, including a day off while the homeowners were away and a day waiting on the concrete truck.

Project Story

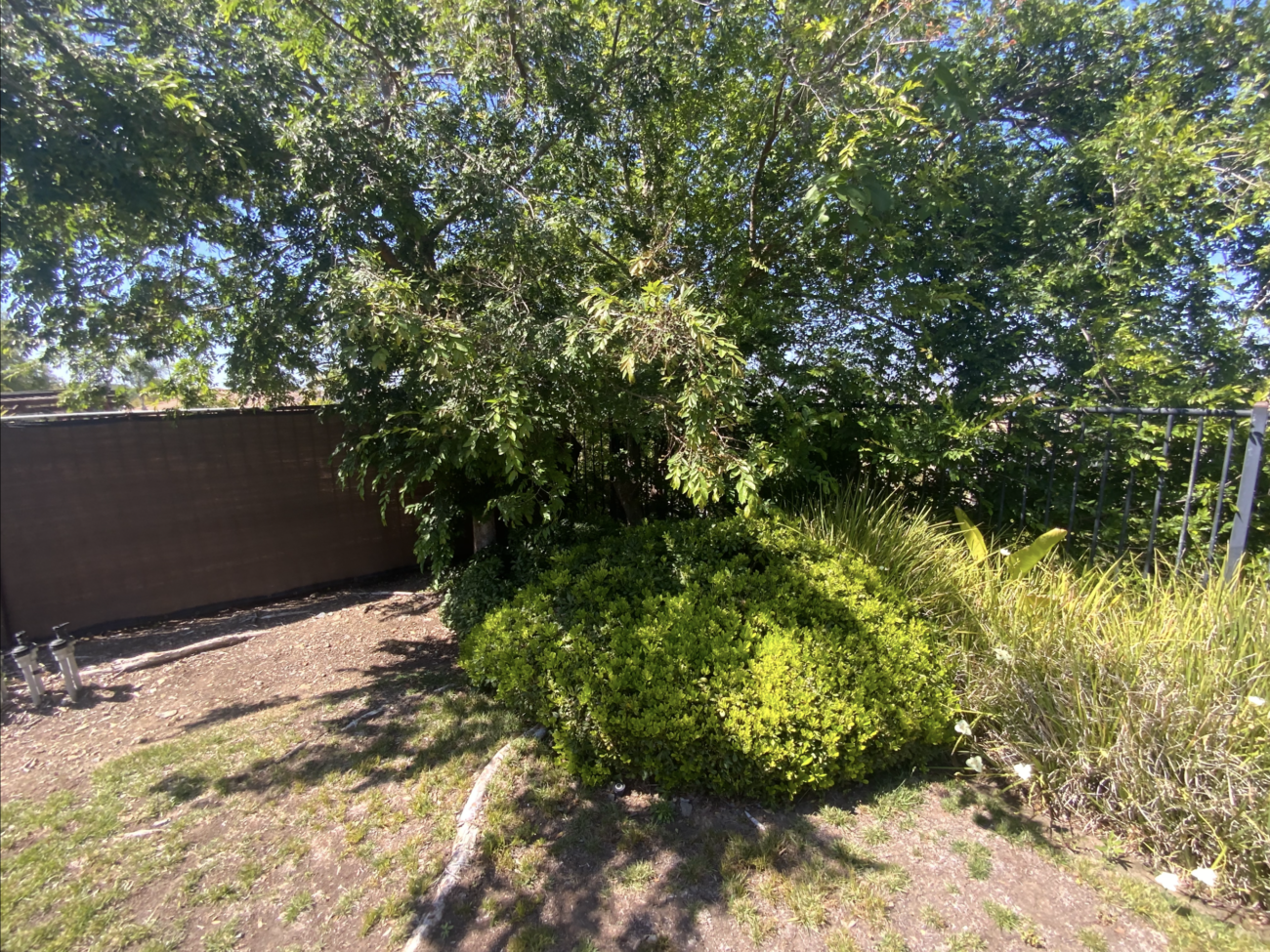

Overview

IID cleared this Stone Canyon backyard and laid 2,372 sf of turf, built a stuccoed BBQ island with a Sizzler PRO 40-inch grill beside the outdoor fireplace and re-stuccoed the fireplace, ran a new gas line through rocky ground, and set 41 stepping stones down both side yards. Signed at $63.2K, it finished at $62.0K after four change orders, 24 working days from start to finish.

The Challenge

  • The fireplace's gas line had no visible connection point, so the crew had to dig to find the buried pipe before trenching.
  • The HOA asked to approve the turf three days before the start date; IID redrew the design with the drainage and every material called out for the submittal.
  • The 18-inch gas trench ran through heavy rock and broke several irrigation lines, including a main, which the crew repaired.

What Changed

The backyard now has 2,372 sf of turf to the view fence, a stuccoed BBQ island with a Sizzler PRO 40-inch grill and side burner beside the re-stuccoed fireplace, two-foot stepping stones down both side yards, and new beds on drip, finished in 24 working days.

How INSTALL-IT-DIRECT Helped

A Stone Canyon backyard with an outdoor fireplace, an existing concrete patio, a planted slope and gravel side yards. IID cleared the old bushes, laid 2,372 sf of Pro-Trade Rye turf edged in a paver mow strip, built a stuccoed BBQ island with a Sizzler PRO 40-inch grill beside the fireplace, re-stuccoed the fireplace, and set two-foot stepping stones down both side yards.

Over 1,000 five-star reviews and 1,500+ San Diego homeowners served.

The side lawn and patio, with the fireplace and the new BBQ island at the far end
The side lawn and patio, with the fireplace and the new BBQ island at the far end.

Design & Build

The Plan

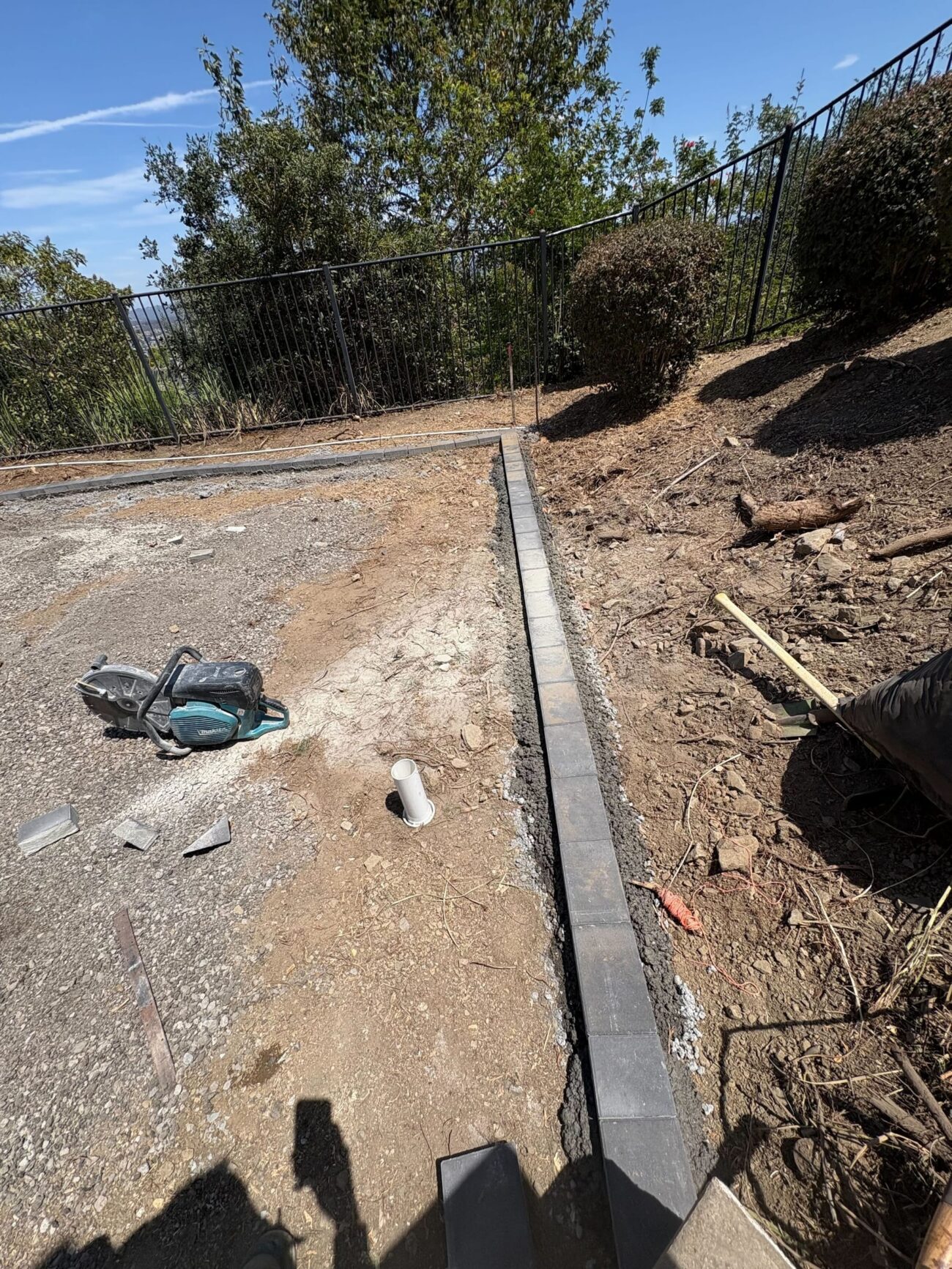

  • Clear the old bushes and lay 2,372 sf of Pro-Trade Rye turf, edged with a paver mow strip set in concrete (283 LF as built).

  • Set a BBQ island of Eldorado 60-inch and 36-inch modular cabinets on a new concrete pad beside the fireplace, with a Sizzler PRO 40-inch grill, a side burner, a 26-inch drawer and a vented access door, finished in stucco.

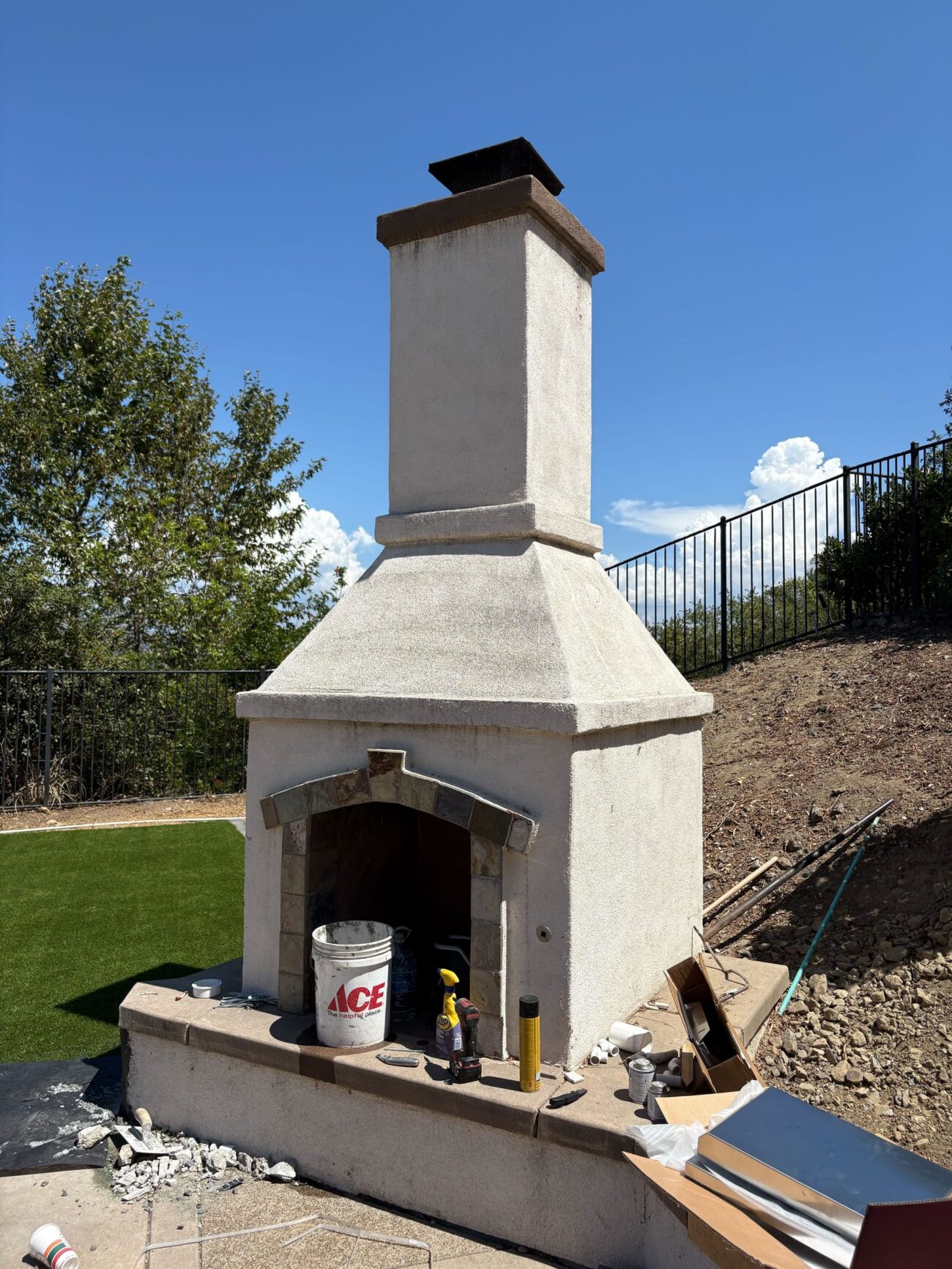

  • Strip and re-stucco the whole existing fireplace.

  • Find the buried gas line and run 38 feet of new 1-inch line, 18 inches deep, with tracer tape.

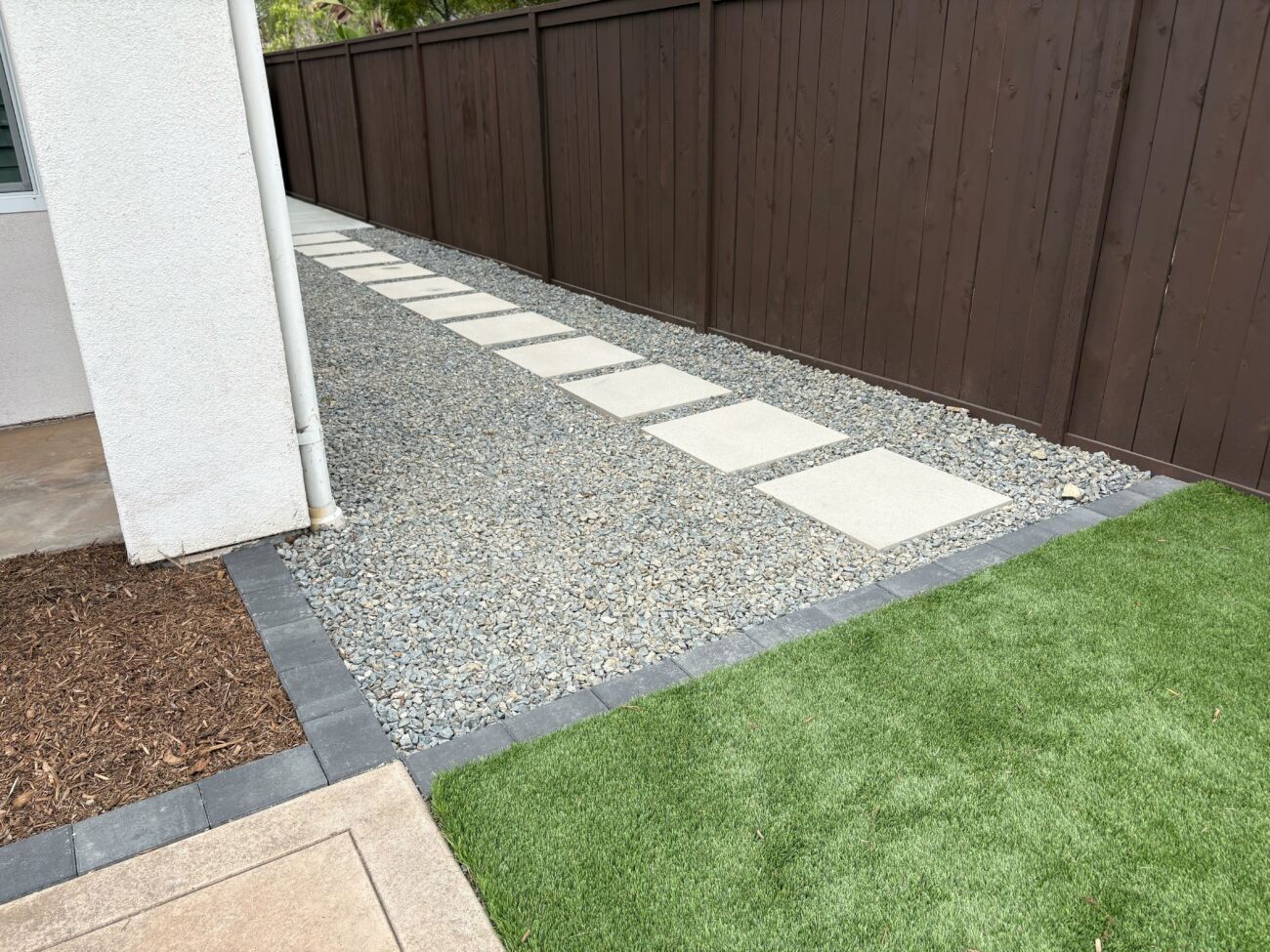

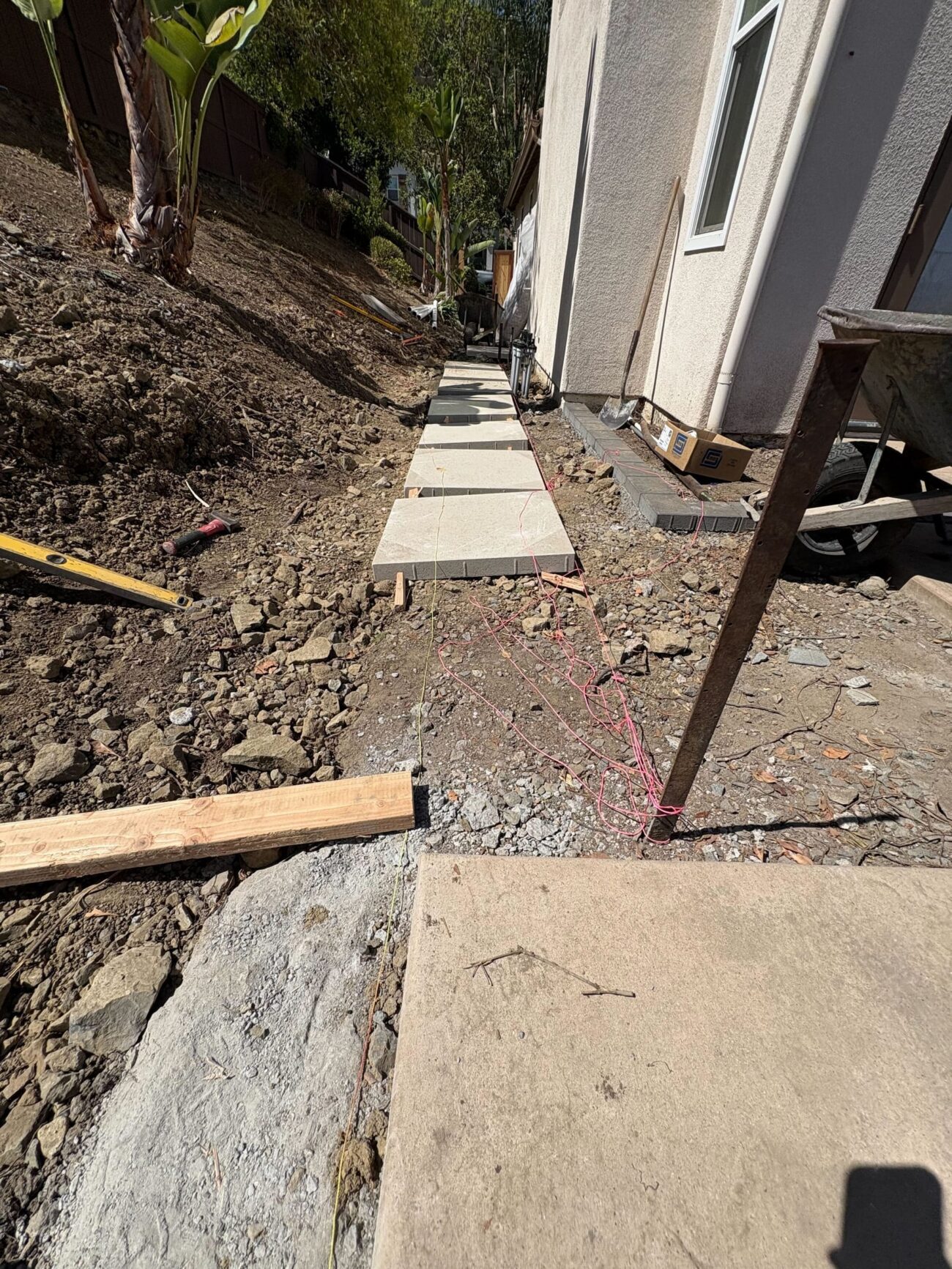

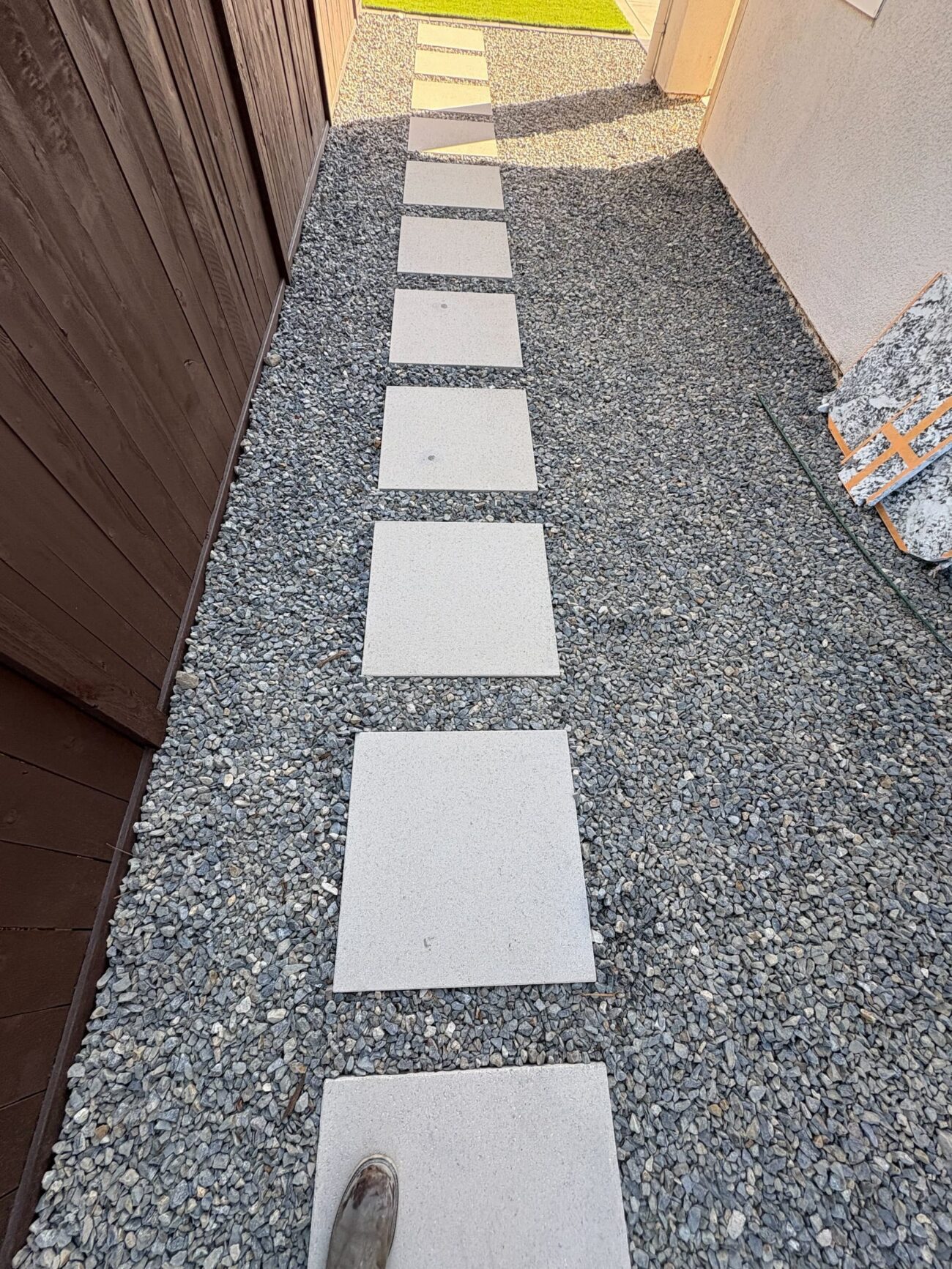

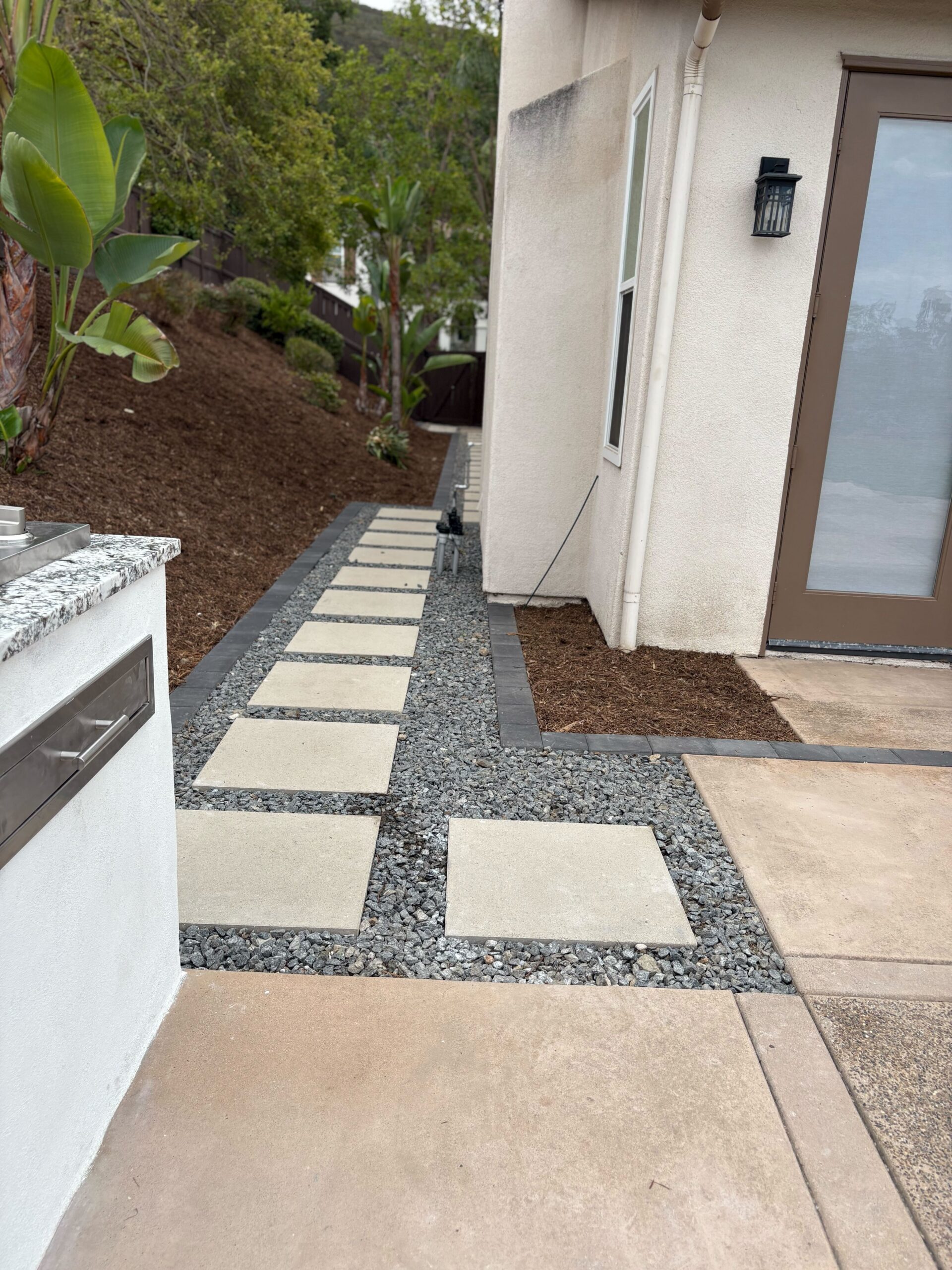

  • Set 41 two-foot stepping stones in concrete, in gravel, down both side yards.

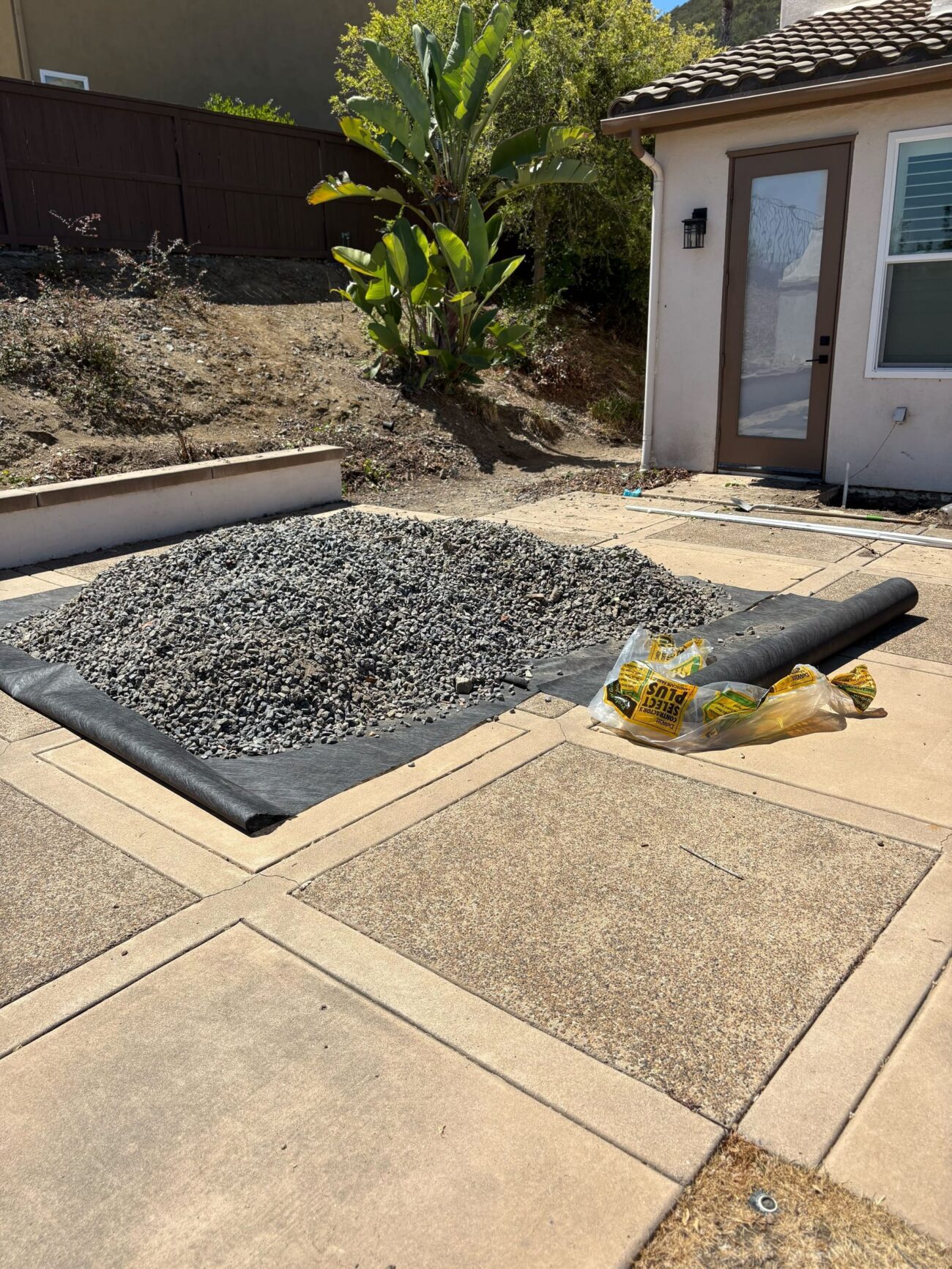

  • Run 20 LF of 3-inch drain line, and plant the beds with 21 plants the homeowners supplied, shredded fir mulch and a drip zone.

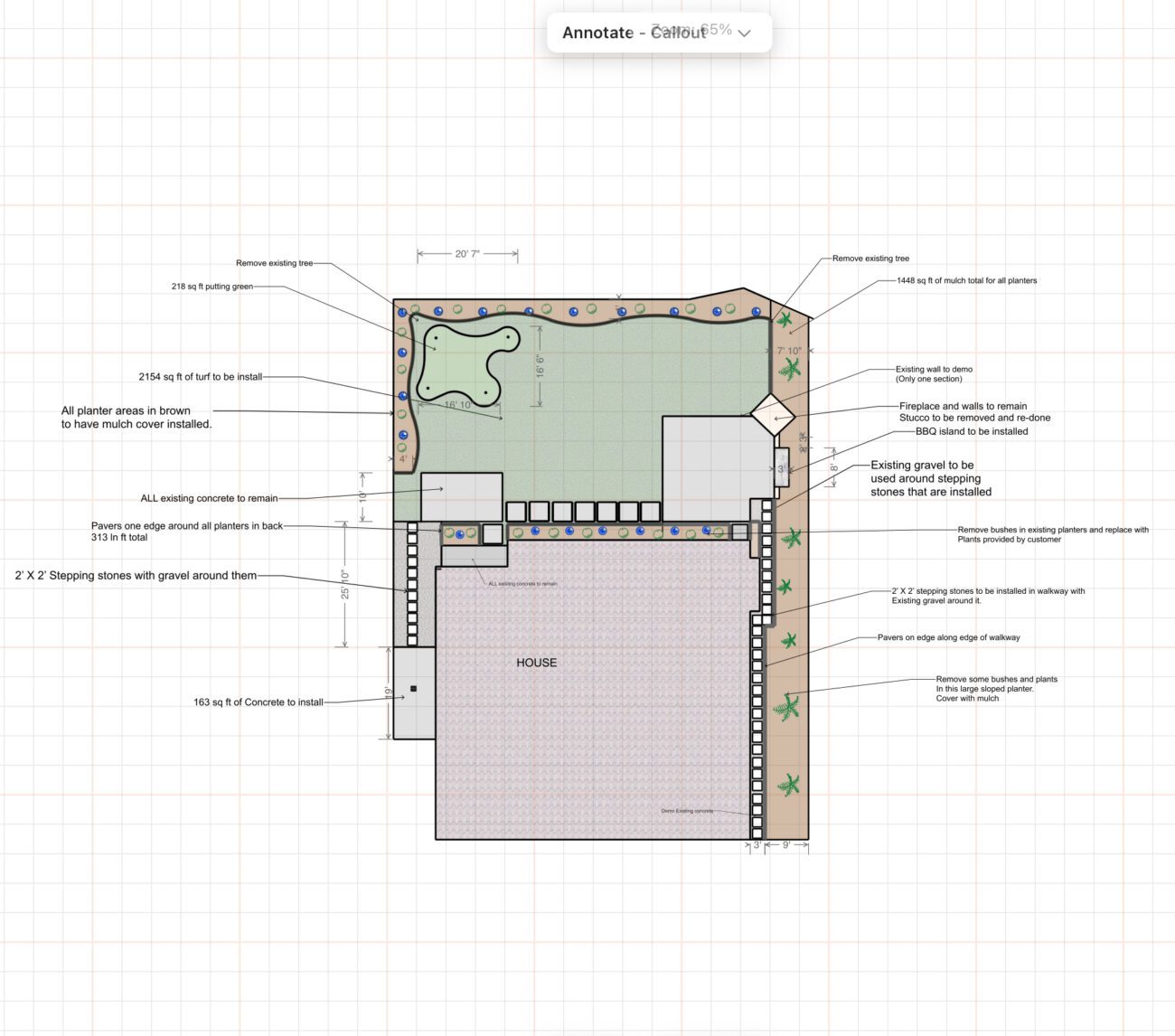

See the 2D plan drawing
Project plan

The Build

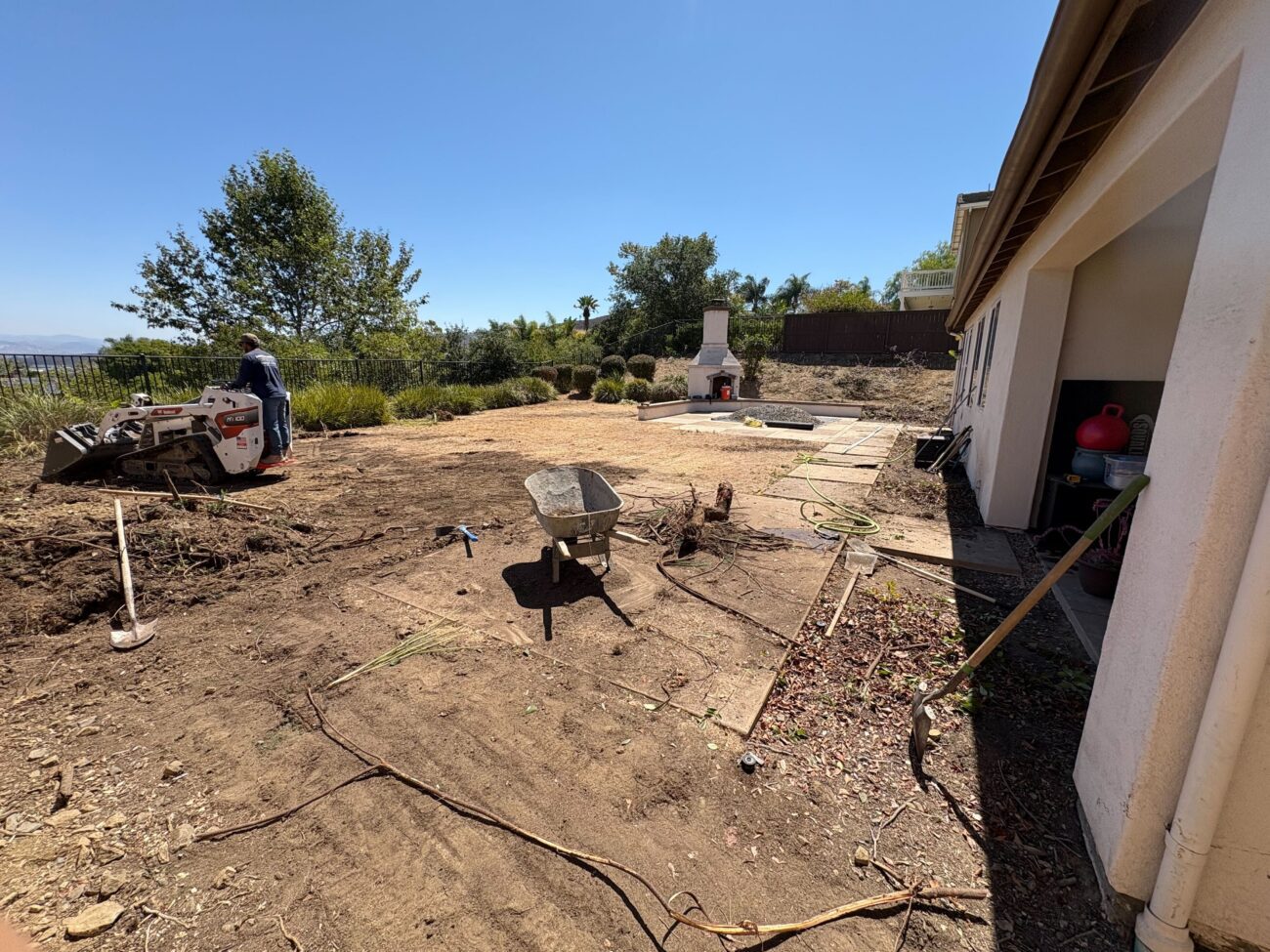

Demo and the gas line search, Aug 18 to 20

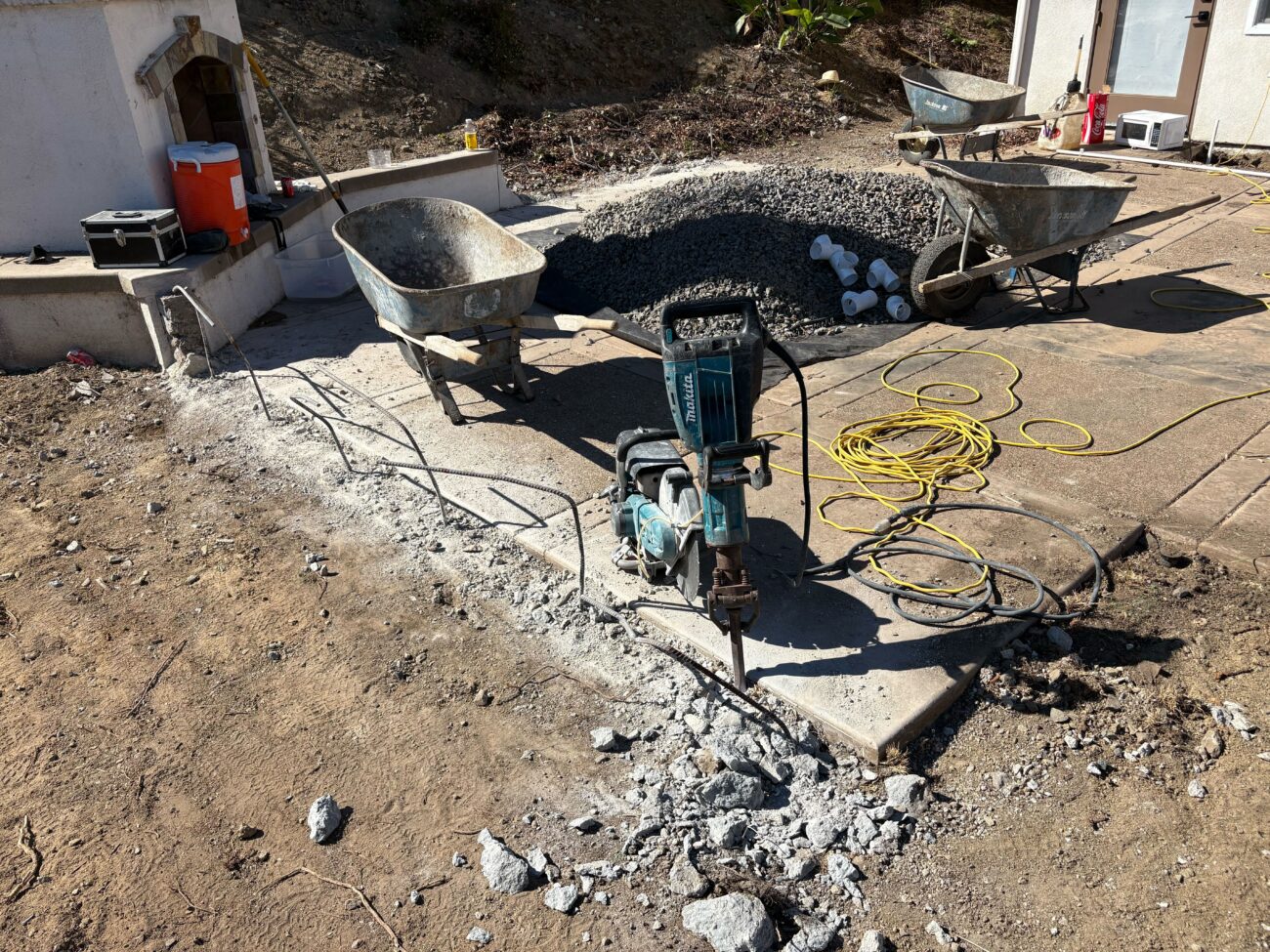

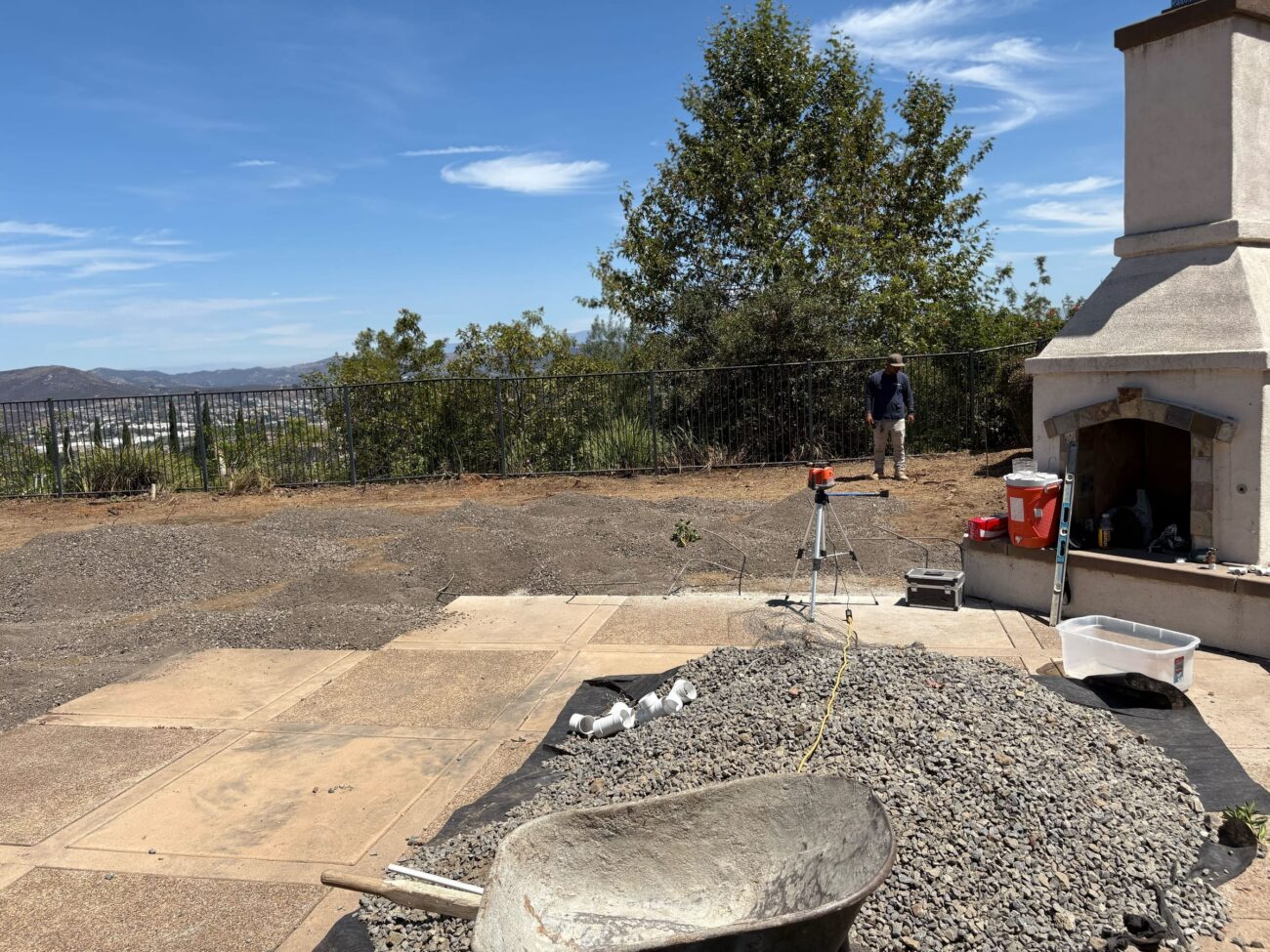

Demo began August 18 with the old bushes and the soil cut for the turf base. The existing gas line tested live, but the fireplace had no visible connection point, so the crew dug to find the buried pipe.

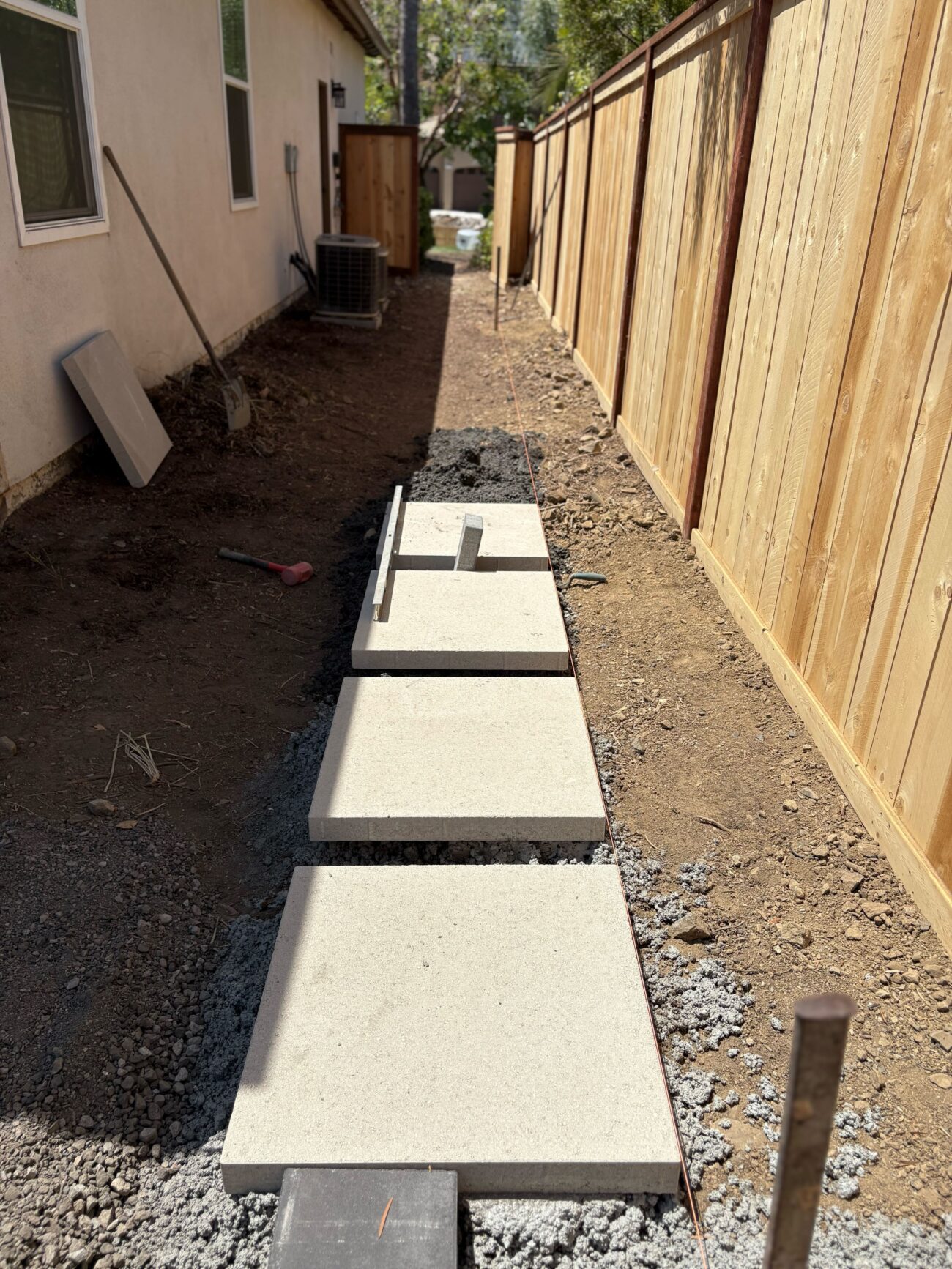

Trench, mow strips and stepping stones, Aug 20 to 22

The 18-inch gas trench hit heavy rock and broke several irrigation lines, including a main; the crew repaired them. Mow strips and stepping stones went in alongside the base work.

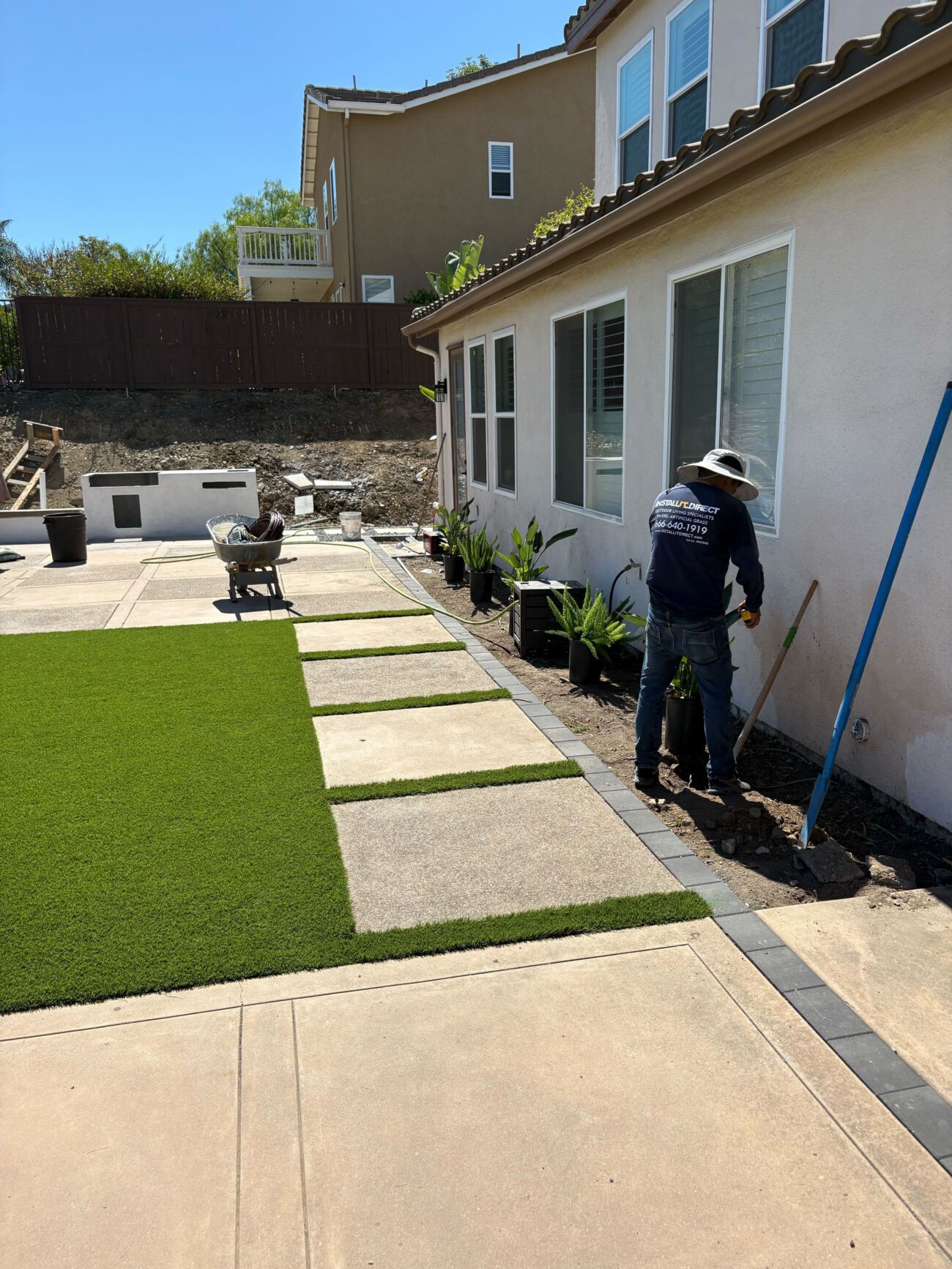

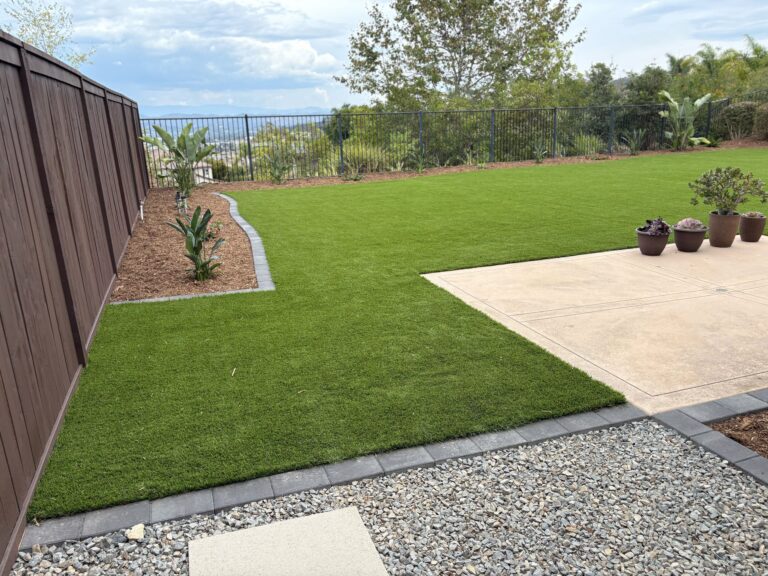

Turf, Aug 22 to 26

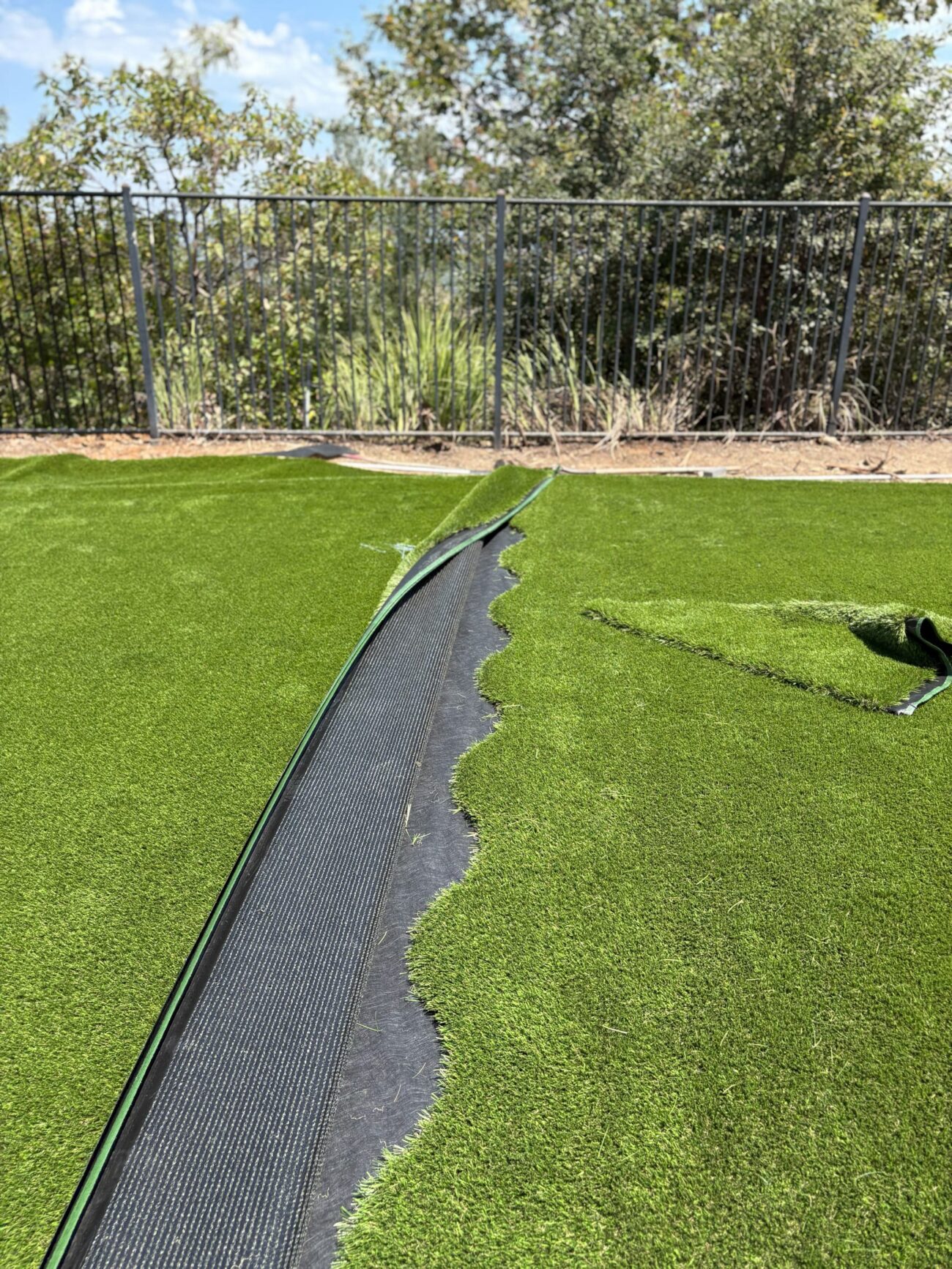

Weed barrier first, then 2,372 sf of Pro-Trade Rye turf, nailed and filled with Envirofill infill.

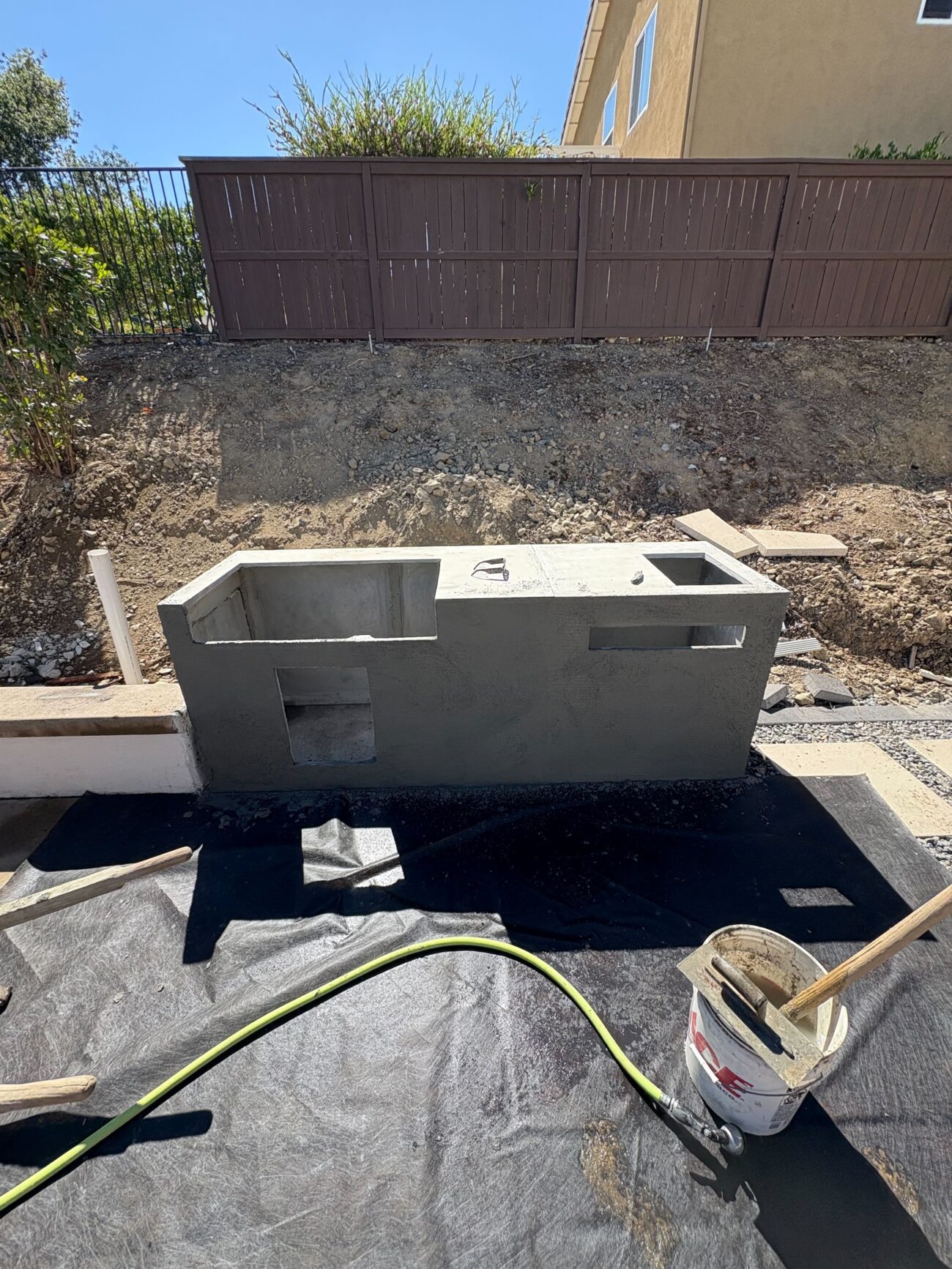

BBQ pad and island, Aug 27 to Sep 5

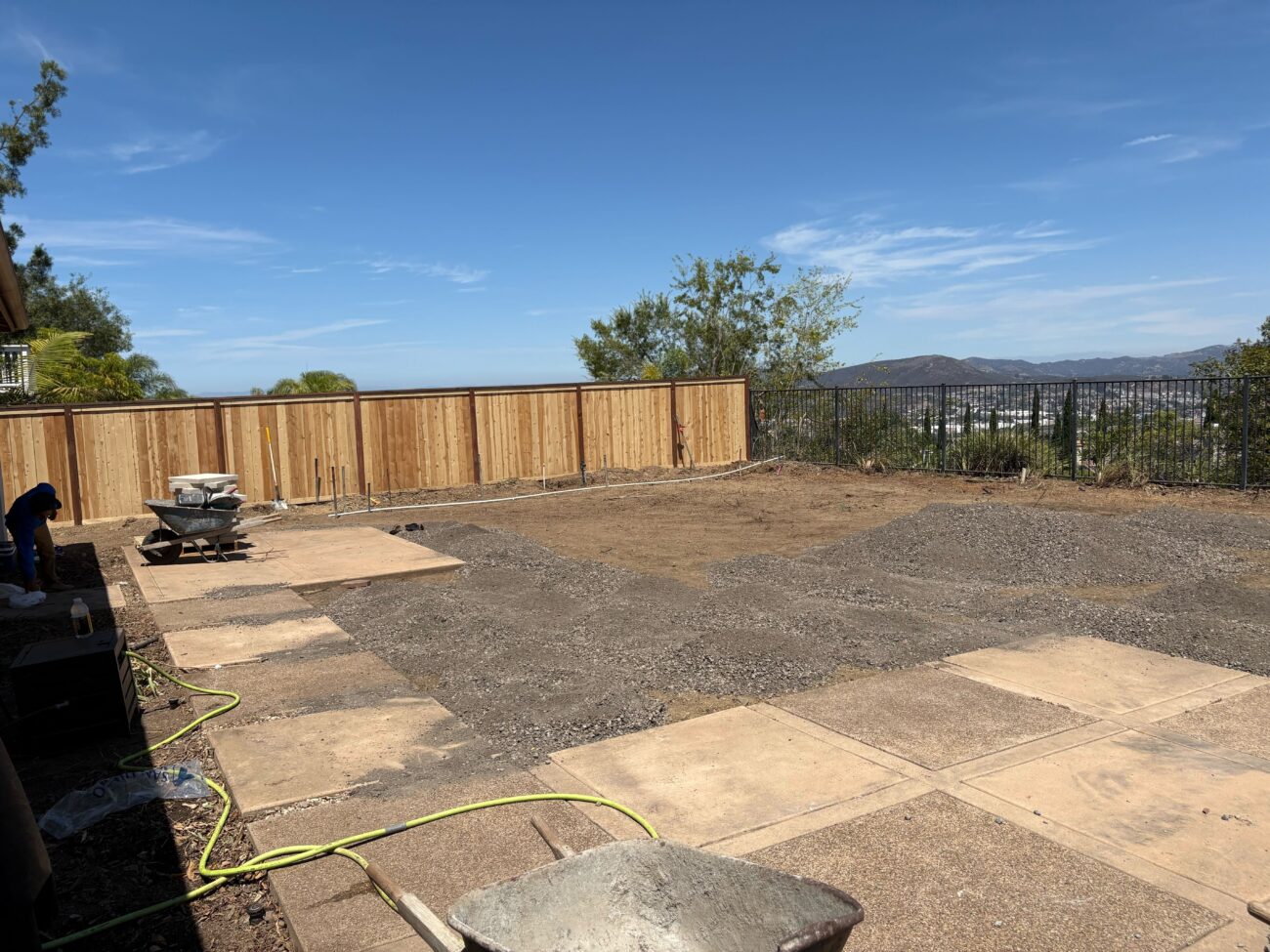

The gas line to the island went in and held its test. The island's concrete pad was poured August 28 and given an extra day to cure after rain; the rest of the concrete was poured September 5.

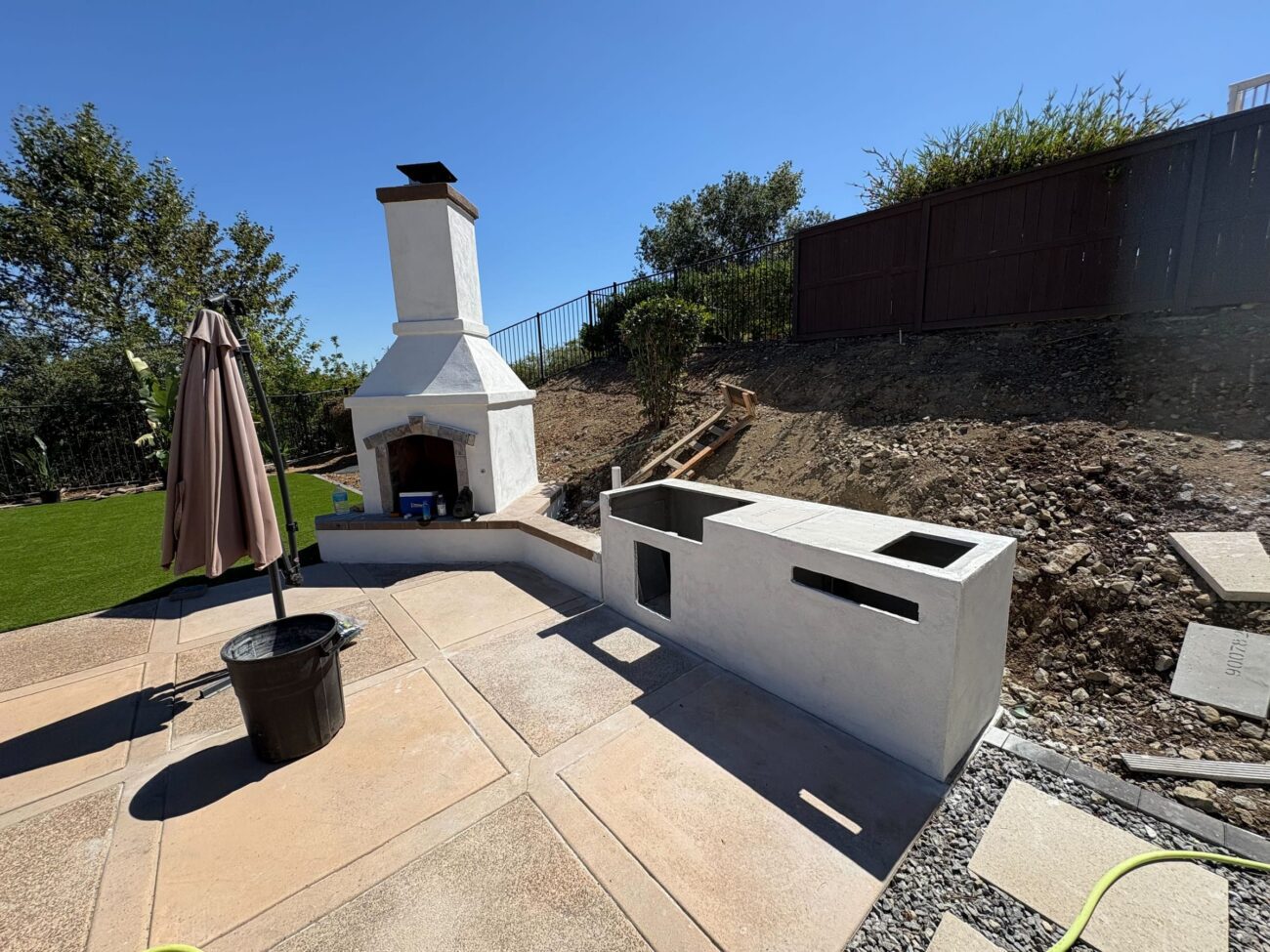

Stucco, planting and close-out, Sep 8 to 19

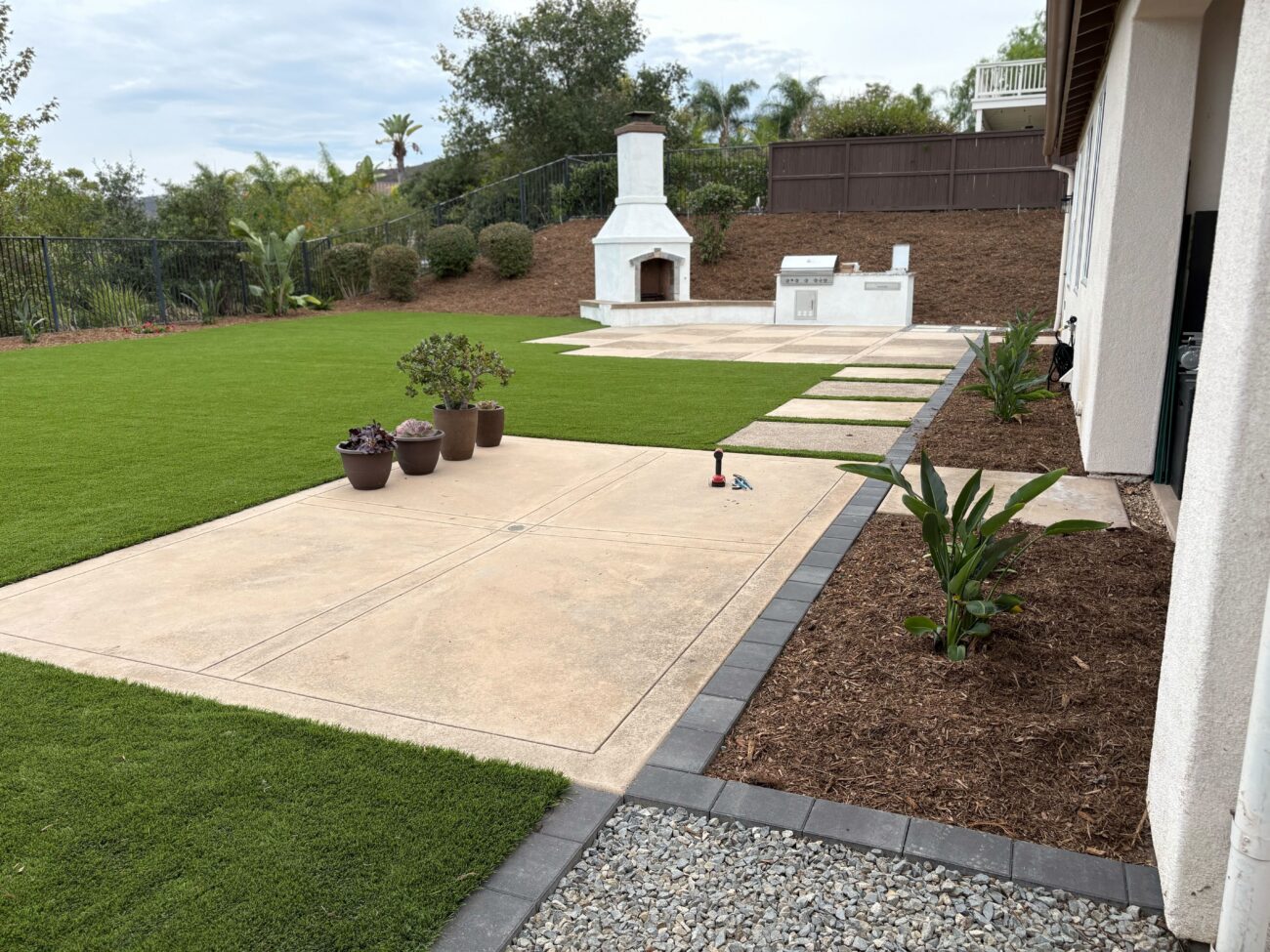

The island and the whole fireplace were stuccoed September 8 and 9, and compost, plants, mulch and drip went in on September 10. The homeowners' fabricator set the granite countertop on September 12; IID installed the grill and side burner and closed out the job on September 19.

Investment

What would a similar project cost in San Marcos?

Toggle components on/off to estimate your project

Artificial Turf (2,372 sf Pro-Trade Rye, infill, barrier, edging) $29,000 – $30,500
Hardscape (41 stepping stones, 122 sf of concrete, paver mow strip) $7,800 – $8,500
BBQ Island (Eldorado cabinets, Sizzler PRO 40-inch grill, side burner, drawer, door) $6,600 – $7,200
Planting (21 plants installed, mulch, topsoil, drip, gravel) $6,000 – $6,600
Stucco (the fireplace and the island) $4,500 – $5,000
Demo and Site Work (bushes, soil, a wall section, hauling) $4,300 – $4,800
Gas Line (38 feet of 1-inch line, 18 inches deep) $1,400 – $1,800
Drainage (20 LF of 3-inch drain line) $400 – $600
Estimated Total

Frequently Asked Questions

What did this Stone Canyon backyard cost?

It was signed at $63.2K and finished at $62.0K after four change orders. The turf was the largest line, close to half the total; the BBQ island, the stucco, the stepping stones and mow strip, the gas line, drainage and planting made up the rest. The cost breakdown on this page shows each part.

Can an HOA in San Marcos stop artificial turf?

California Civil Code Section 4735 voids HOA rules that prohibit artificial turf, but an HOA can still review the design. Here the HOA asked to approve the turf three days before the start, and IID redrew the plan with the drainage and every material called out for the homeowners' submittal.

Can I supply my own plants?

Yes. Here the homeowners bought 21 plants, 19 five-gallon and 2 fifteen-gallon, and IID planted them in new topsoil and compost, mulched the beds and added a drip zone.

How long did it take?

24 working days, August 18 to September 19, 2025. The island's concrete pad got an extra day to cure after rain, and the homeowners' fabricator set the granite countertop before the grill and side burner went in.

What happens when a gas trench hits irrigation lines?

On this job the 18-inch trench ran through heavy rock and broke several irrigation lines, including a main. The crew repaired them, and before closing out the project manager set the controller's seven stations, from the front lawn to the drip along the back fence.
