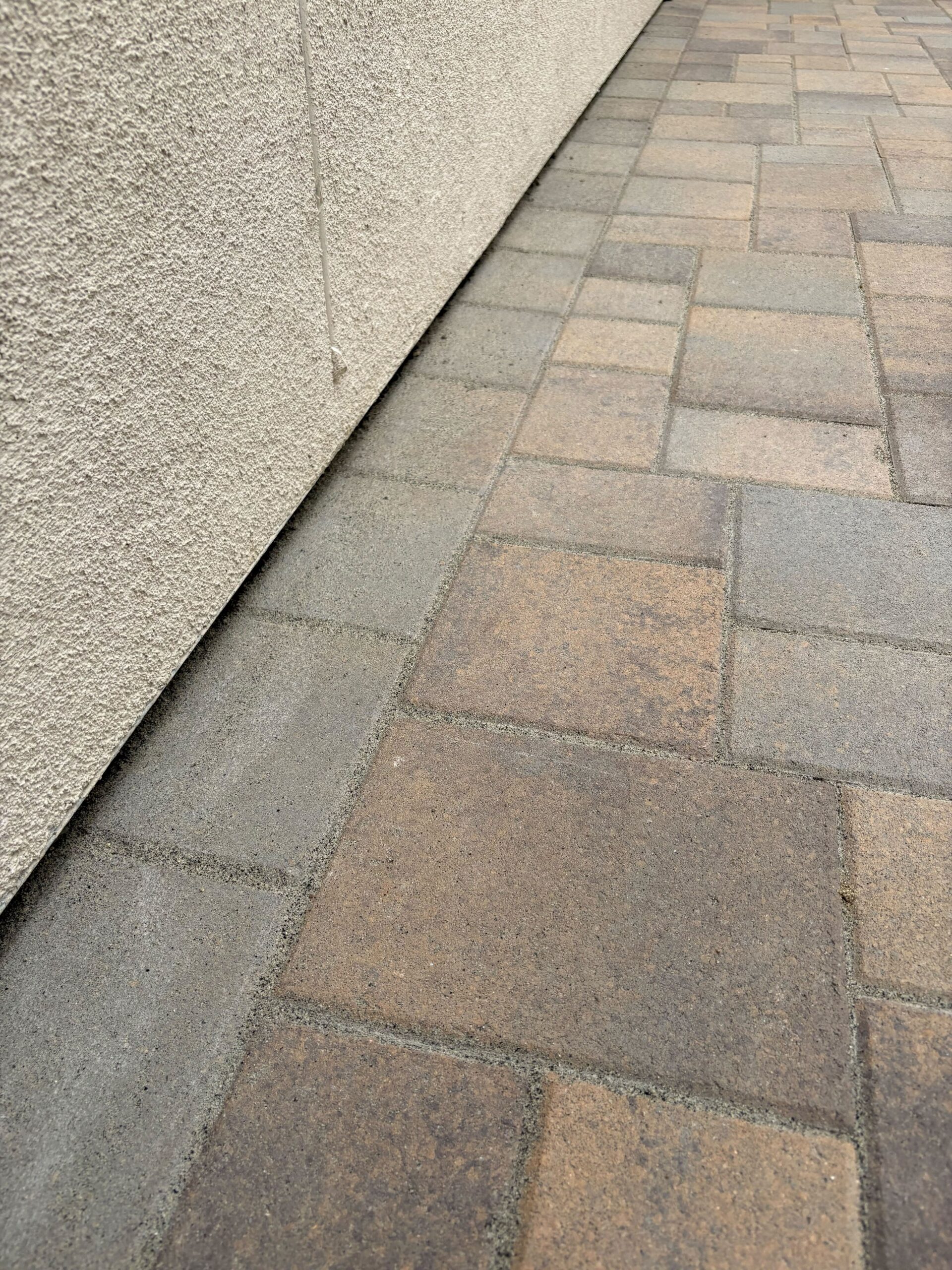

Close-up photo of a newly installed interlocking paver walkway running alongside a stucco exterior wall. Mixed-size...

A Side-Yard Reset in Meriwood, Vista

Project Snapshot

Location Meriwood, Vista (92081)
Style Transitional
Timeline About 6 build days
Price Range $14k–$18k

– Pavers: Angelus Courtyard Combo (Standard) 60MM, 496 sf installed
– Polymeric sand: NextGel 50 lb bags, Tan
– Wall block: Angelus Rustic Wall Stone, 88 sf
– French drain: 3-inch triplewall perforated pipe with filter sleeve, 35 lf
– Drainline: 3-inch SDR35, 25 lf
– Drain caps: plastic square PVC, 4 units
– DG: Desert Gold stabilized, 115 sf
– Base, bedding sand, and dump fees included in scope

Two drainage systems were installed. A 35 lf perforated French drain with triplewall pipe and sleeve runs behind the new retaining wall to intercept groundwater before it reaches the paver base. A separate 25 lf SDR35 solid drainline connects four surface drain caps to carry runoff from the yard and downspouts to an approved outlet. Hardscape was graded to slope away from the foundation.

HOA approval was required and obtained before installation began. The association cited a backlog that delayed the start by several weeks; install commenced only after all pre-install checklist items cleared. The segmental wall on this project was below the height threshold that typically triggers a building permit in California (3 feet from top of footing to top of wall). Local thresholds in the City of Vista should always be confirmed before construction.

Pre-install prep and HOA approval occupied roughly two months before the build started. Active construction ran approximately 6 working days from site setup and demo through final checks and certificate-of-completion sign-off.

Project Story

Overview

Set 496 sf of Angelus Courtyard Combo 60MM pavers across this Vista side yard, built an 88 sf Angelus Rustic Wall Stone segmental retaining wall with a 35-lf French drain behind it, and stabilized 115 sf of Desert Gold DG. Added a 25-lf SDR35 drainline with four drain caps. Six build days to resolve the bare-dirt, no-drainage, crumbling-wall starting state.

The Challenge

  • The side yard was compacted bare dirt, turning muddy and unusable after any rainfall.
  • The existing wall along the fence line had deteriorated to the point that it needed to be demolished before any new construction could begin.
  • Without drainage, water from the yard and downspouts had no clear exit path, pooling against the house foundation.

What Changed

Where the side yard was bare, compacted dirt with a failing wall and standing water, 496 sf of interlocking Angelus Courtyard Combo paver and a new Rustic Wall Stone segmental wall now run the corridor, with a 35 lf French drain keeping the base dry. The 115 sf of stabilized DG fills the planting borders at grade.
How Install It Direct Helped
The job started with demolishing the failing wall, then a 35 lf perforated French drain went in along the fence line before any base material got laid. The crew set 88 sf of Angelus Rustic Wall Stone in lifts with the drain running behind each course, then screeded a compacted base and laid 496 sf of Angelus Courtyard Combo 60MM pavers across the corridor. A 25 lf SDR35 surface drainline with four caps ties the downspouts and yard runoff to an approved discharge point. The 115 sf of stabilized Desert Gold DG border was placed and graded last, flush to the paver field. Six working days from demo to certificate.

Market Context

Side yard paver and wall projects in North County San Diego typically range from $14,000 to $22,000 depending on linear footage, wall height, drainage complexity, and access constraints.

Neighborhood Context

This Meriwood area home in Vista 92081 sits on a lot with a narrow side yard corridor between the house and the property-line fence, a common configuration in attached and semi-attached residential clusters in North County San Diego.

Over 1,000 five-star reviews and 1,500+ San Diego homeowners served.

Design & Build

The Plan

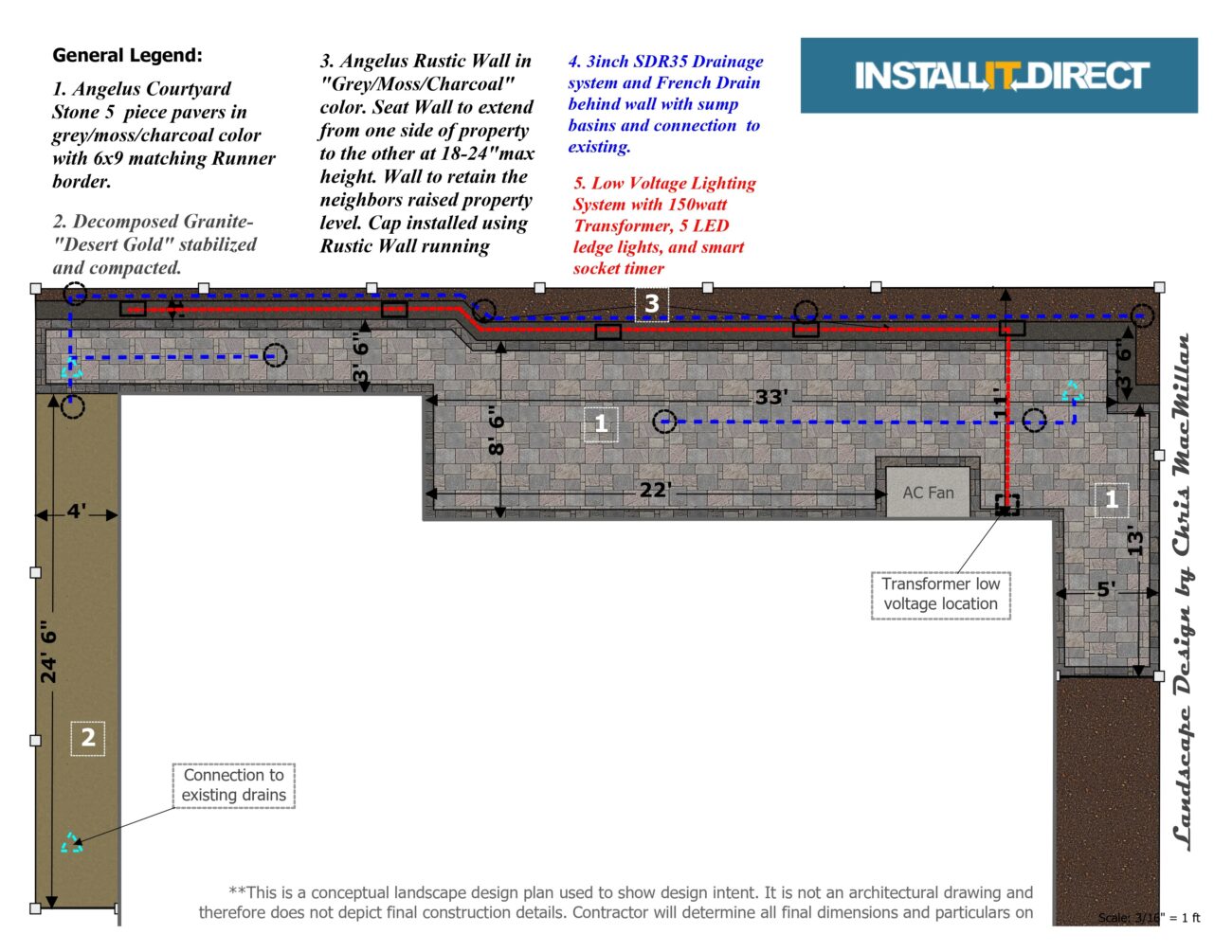

Project plan
  • Angelus Courtyard Combo (Standard) 60MM pavers selected for their classic multi-piece pattern and durability in a high-foot-traffic side yard corridor

  • Angelus Rustic Wall Stone chosen to match the warm tones of the paver palette and provide structural support along the vinyl fence line

  • 35 lf perforated French drain with triplewall pipe and filter sleeve installed directly behind the new retaining wall to intercept hillside groundwater before it can saturate the base

  • 25 lf of 3-inch SDR35 drainline tied to four drain caps routes surface water from the yard and downspouts to an approved discharge point,

  • 115 sf of stabilized Desert Gold decomposed granite fills the planting border areas, graded to the paver height for a level transition

The Build

Build phases

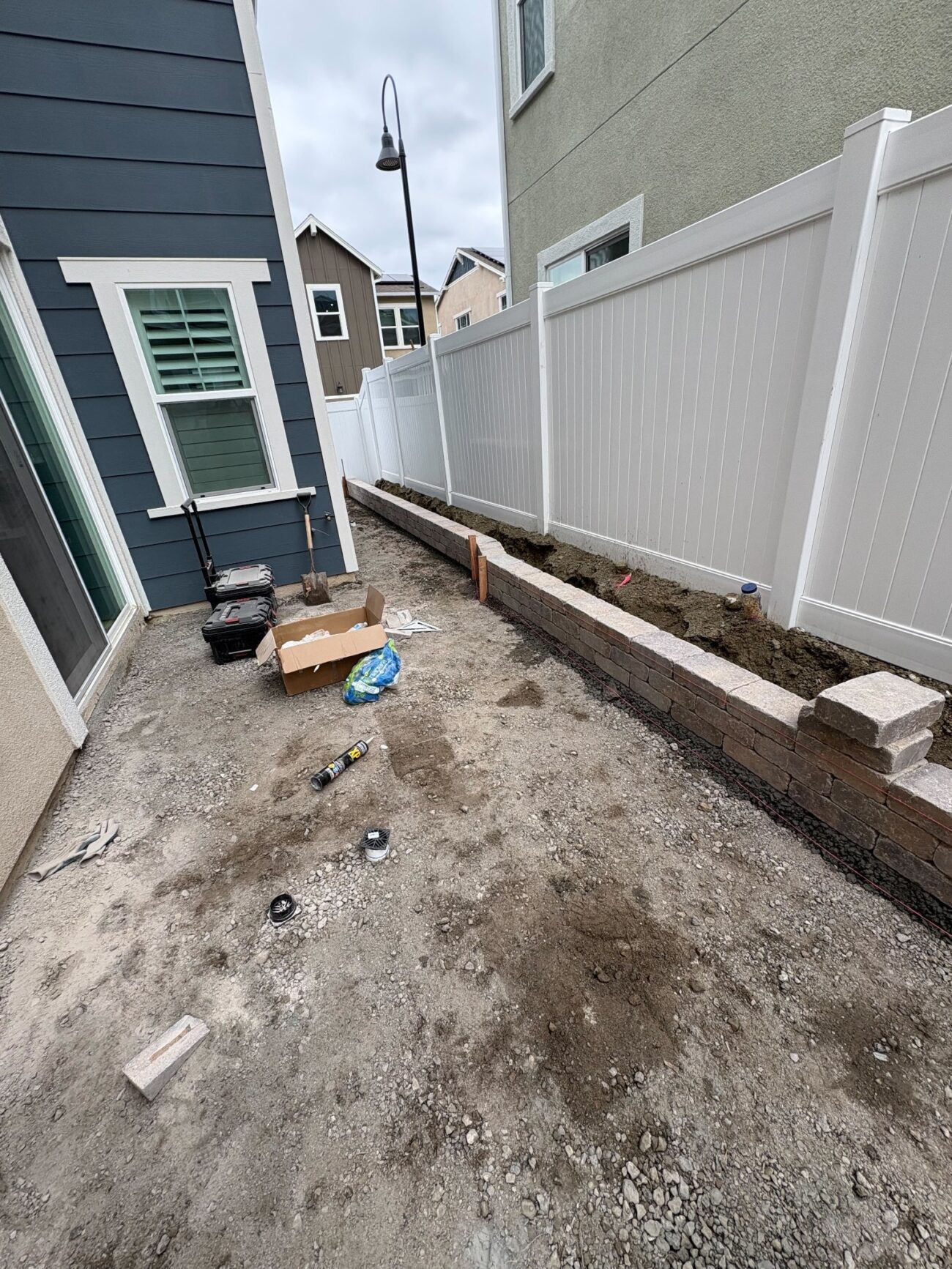

Crew demolished the existing wall and footing (65 sf), cleared 430 sf of the side yard access area, and stripped the compacted subgrade to accept new base material. Dig Alert was confirmed and scope was marked before any digging started.

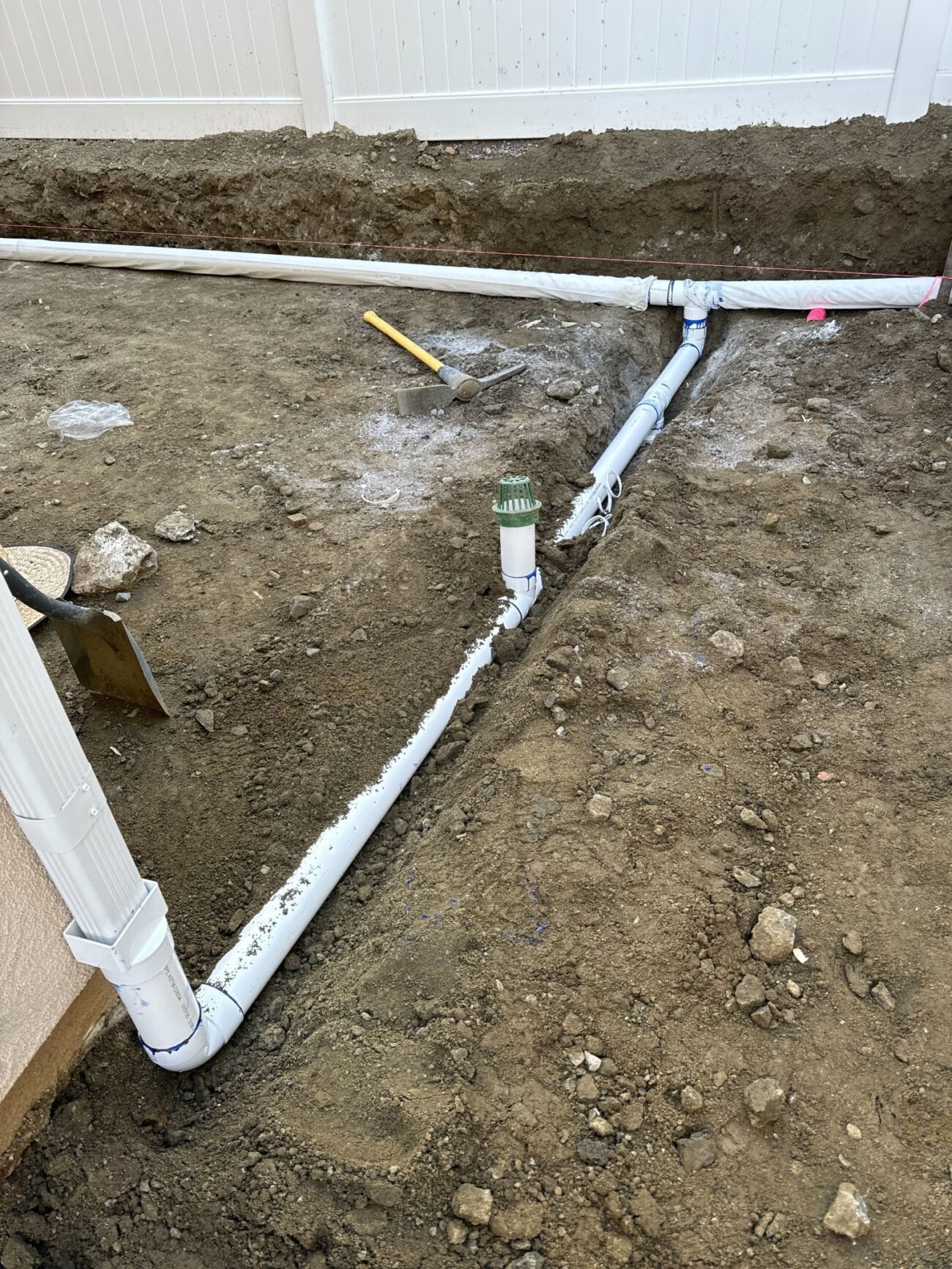

A trench was cut along the fence line for the 35 lf French drain behind the wall footprint, and a separate 25 lf SDR35 drainline trench was run for the four drain cap outlets. Both lines were set before backfilling.

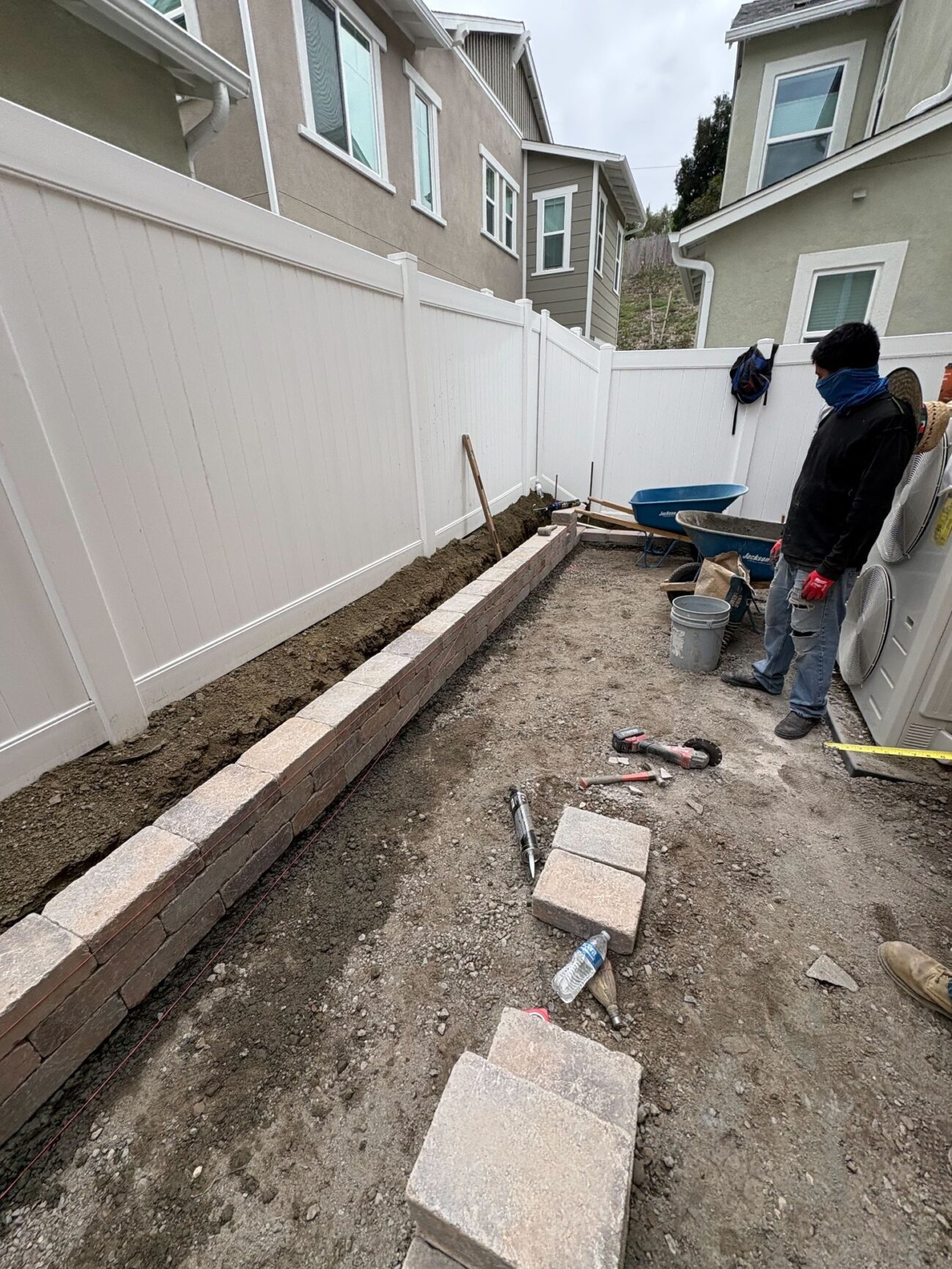

The Angelus Rustic Wall Stone segmental wall was built in lifts along the vinyl fence line, with the French drain running behind each course as the wall rose.

Compacted base was screeded to accept the 60MM Angelus Courtyard Combo pavers across 496 sf. Pavers were set, cut to fit the side yard corridor, and jointed with NextGel polymeric sand.

Stabilized Desert Gold DG was placed and compacted in the 115 sf border zone and graded to match paver height. Drain caps were cut down to finished grade. A final walk confirmed all work before the completion certificate was signed.

Frequently Asked Questions

How much does a paver patio and retaining wall installation cost in Vista, CA?

This Vista project — 496 sf of pavers, an 88 sf segmental retaining wall, a 35 lf French drain, and 115 sf of decomposed granite — came in at roughly $14,000 to $18,000 installed. Cost drivers on projects like this are drainage complexity, wall length, and access width. Tight side yard corridors that limit equipment access increase labor time.

Do I need an HOA or permit to install a paver patio and retaining wall in Vista?

This project needed HOA approval before work could start. On the permit side, retaining walls taller than 3 feet from top of footing to top of wall typically require a California building permit; walls below that threshold built without surcharge loads generally do not. Always confirm with the City of Vista, which sets its own thresholds.

How do you handle drainage behind a segmental retaining wall?

On this project, a 35 lf perforated triplewall French drain with a filter sleeve runs directly behind the wall. That intercepts groundwater before it can build pressure against the wall or saturate the paver base. A separate 25 lf SDR35 drainline handles surface water from the yard and downspouts. Both systems tie to an approved discharge point.

How do I maintain pavers and decomposed granite in a side yard?

Angelus Courtyard Combo pavers jointed with NextGel polymeric sand need minimal upkeep. Rinse debris off periodically and spot-treat any weeds that appear in the joints. Stabilized DG holds its surface well but may need a light top-dressing every few years if foot traffic wears it down. Neither surface requires sealing, though a paver sealer can be applied every 3 to 5 years to enrich the color.

How long does it take to install pavers and a retaining wall in Vista?

Active construction on this project ran approximately 6 working days on site. HOA approval added lead time before work could start. Most North County projects of similar scope run 6 to 12 build days depending on site conditions and drainage work.

Can I install a paver patio in a narrow side yard with limited equipment access?

Yes. This Vista project was built in a narrow corridor between the house and a vinyl fence. Crews used wheelbarrows and hand tools to move base material and pavers into the space. Material staging on the driveway and careful sequencing kept the project on track despite the tight access.
