Completed backyard turf and pool-deck walkthrough
Walkthrough of the finished backyard showing artificial turf, flagstone patio transitions, pool coping, sport court area, and finished landscape edges.
This finished project was a $60k-$70k build.

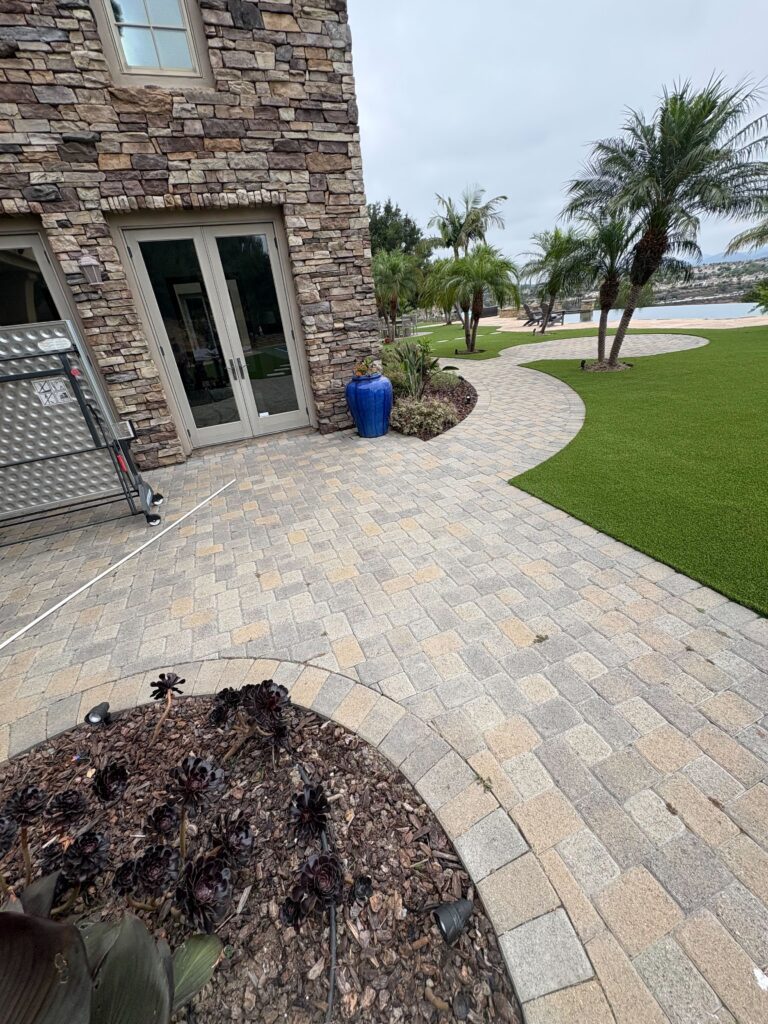

Artificial turf laid to a clean edge at a paver patio, no transition strip.
Belgard Moduline 24×24 stepping stones set in concrete through 5,248 sf of artificial turf.
Chris MacMillan walked the Carmel Valley property and laid out twenty years of lawn as a single 5,248 sf field of Imperial Desert Rye 65 synthetic turf, cut by fifteen 24-inch Belgard Moduline stepping stones. A 318 sf strip of stabilized Desert Gold decomposed granite anchors the perimeter; the field drains to the existing collection points. About four weeks on site.
Twenty years of fighting the lawn and now we just walk across the stepping stones and call it done., Jeff P., San Diego
Over 1,000 five-star reviews and 1,500+ San Diego homeowners served.

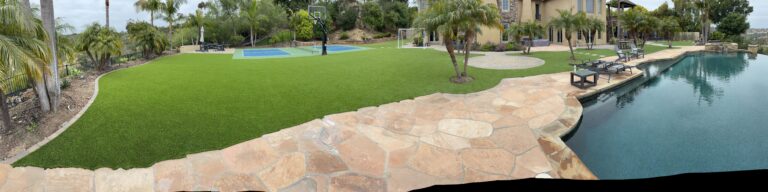

Carmel Valley backyard with 5,248 sf of artificial turf running between pool deck and sport court; 15 stepping stones across the field.
Mid-installation view from the back of the lot, base prep underway, hardscape edges visible.
Belgard Moduline 24×24 stepping stones set in concrete through 5,248 sf of artificial turf.
5,248 sf of Imperial Desert Rye 65 synthetic turf laid across the backyard’s multiple zones, the largest single material on site.
15 Belgard Moduline 24×24 stepping stones set in concrete carry daily foot traffic through the turf without compressing the pile.
318 sf of stabilized Desert Gold decomposed granite in the accent path areas reads as a warm-tone contrast to the green turf field.
Poly-board edging and bender-board at turf perimeters hold the synthetic edge clean against adjacent surfaces.
Demo included 8 hours of demolition labor removing roots, soil, and existing concrete, with debris hauled off site. Base material was then graded and compacted across the turf zones.

Fifteen Belgard Moduline 24x24 stepping stones were set in concrete through planned turf areas, and stabilized Desert Gold DG transitions were compacted and finished.
Imperial Desert Rye 65 turf rolls were cut and laid across 5,248 sf, secured with 5-inch nails, and bordered with documented poly-board edging and bender-board material. Green silica sand infill was spread and worked in to finish the surface.
Walkthrough of the finished backyard showing artificial turf, flagstone patio transitions, pool coping, sport court area, and finished landscape edges.
Toggle components on/off to estimate your project
HOA requirements and appearance standards vary by property. Homeowners should verify community rules before construction.
On-site construction ran about four weeks between March and April 2025, with stepping-stone and DG transitions completed in the third week. A small number of post-completion warranty visits handled DG re-compaction and an irrigation-line repair through the following months.
The documented scope included 5,248 sf of Imperial Desert Rye 65 turf, 15 Belgard stepping stones, stabilized DG transitions, poly-board edging, and bender-board material.
