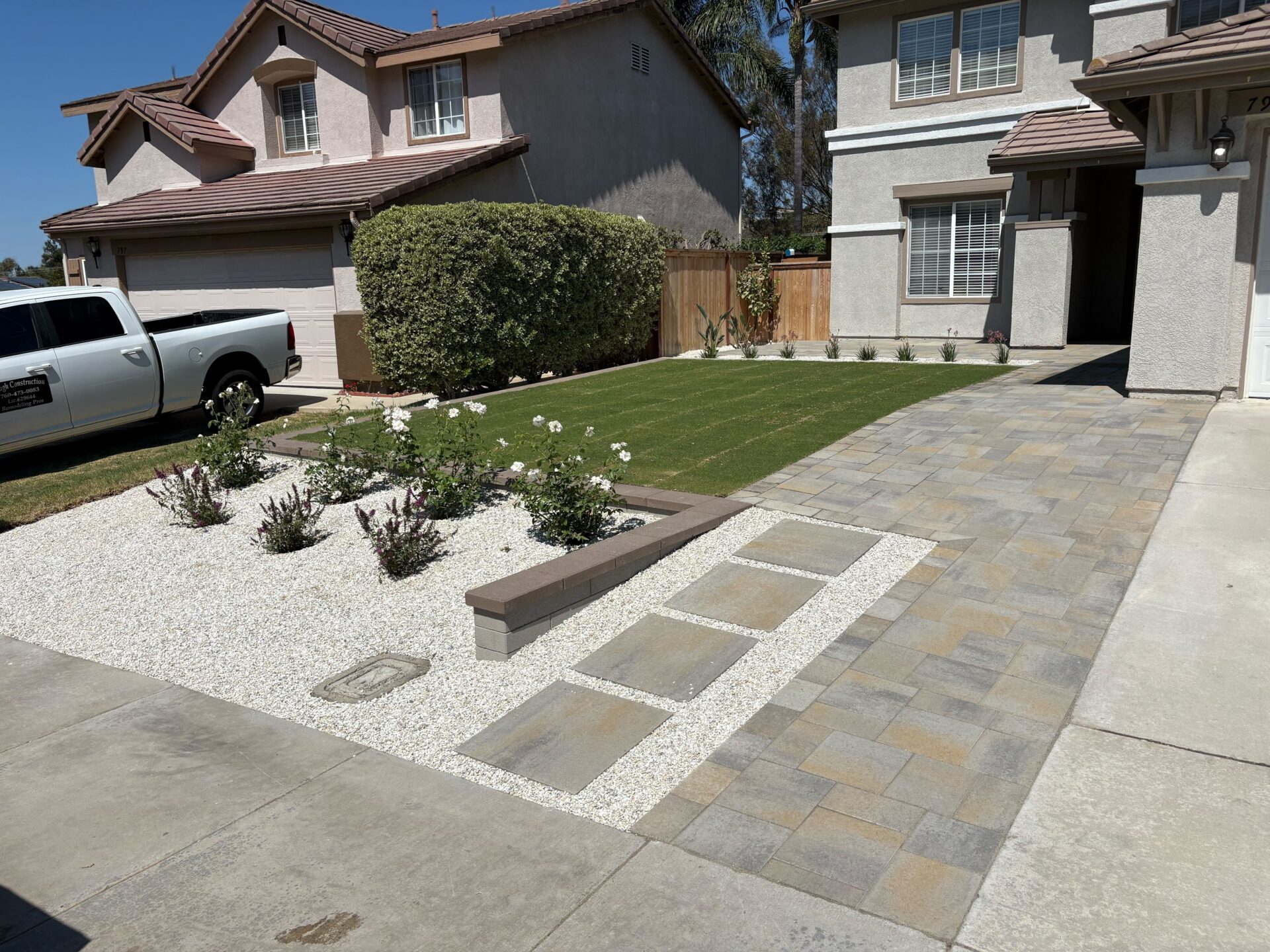

Finished front-yard installation showing interlocking paver driveway and walkway transitioning to a paved entry with adjacent artificial turf lawn. San Marcos project by Install It Direct.

Front Yard Family Transformation in Discovery Hills, San Marcos

This finished project was a $33k–$41k build.

Project Snapshot

Location Discovery Hills, San Marcos (92078)
Style Traditional
Timeline About 2 weeks
Price Range $33k–$41k

• 417 sf Belgard Catalina Grana Large 3PC pavers in Victorian pattern
• 118 sf Belgard Dimensions 6×9 Border pavers
• 20 sf Belgard Moduline 24×24 accent pavers
• 150 sf Bastione 24-inch wall blocks with gray finish
• 50 pieces Bastione caps in mocha color
• NextGel polymeric sand in gray for joint stabilization
• 4 CY White Ice 3/8-inch decorative gravel with weed cloth barrier
• 390 sf Bermuda sod with soil preparation

65 LF of 3-inch triple-wall perforated pipe with sleeve connects to one PVC pop-up drain outlet. System tested during installation to confirm proper connection to existing drainage infrastructure. Surfaces graded to direct water away from structures in compliance with CRC R401.3 requirements.

Approximately 2 weeks of active construction. Demo and drainage work completed first week, followed by wall and paver installation. Landscaping and final details completed in final phase. Material delivery coordination required sequencing between multiple suppliers including Belgard, Modern Pavers, and KRC Rock.

Project Story

Overview

IID replaced concrete walkways and tired landscaping with 555 sf of Victorian-style pavers, low Bastione retaining walls with mocha caps, and artificial turf , creating distinct zones for entertaining and low-maintenance living.

The Challenge

  • The front yard had basic concrete walkways and driveway that provided no visual appeal or defined outdoor living space
  • Both yards lacked proper drainage integration, with no clear water management strategy for the new hardscape
  • Existing landscaping required complete renovation to create a cohesive design that would complement the new paver installation

What Changed

The transformation replaced basic concrete with 555 sf of professionally installed Victorian pavers and added 150 sf of attractive Bastione retaining walls. The integrated drainage system now channels water through 65 LF of perforated pipe to proper outlets, while 390 sf of new Bermuda sod and artificial turf areas eliminated maintenance-heavy landscaping.

How INSTALL-IT-DIRECT Helped

The family needed outdoor spaces that would work for entertaining while requiring minimal upkeep in San Marcos' climate. IID designed a comprehensive solution using Victorian-style Belgard pavers for the main hardscape, complemented by low Bastione retaining walls that create planting zones and seating areas. The approach integrated a complete drainage system with 65 linear feet of perforated pipe connecting to existing outlets, ensuring the new surfaces would perform long-term. Now the front yard flows from the paver driveway extension through defined walkways to the entry, while the backyard patio connects seamlessly to artificial turf and planted borders.

Over 1,000 five-star reviews and 1,500+ San Diego homeowners served.

Before & After

AI-generated before photo for Discovery Hills San Marcos Paver and Wall Project - Victorian pavers, Bastione walls, artificial turf (92078)
BEFORE

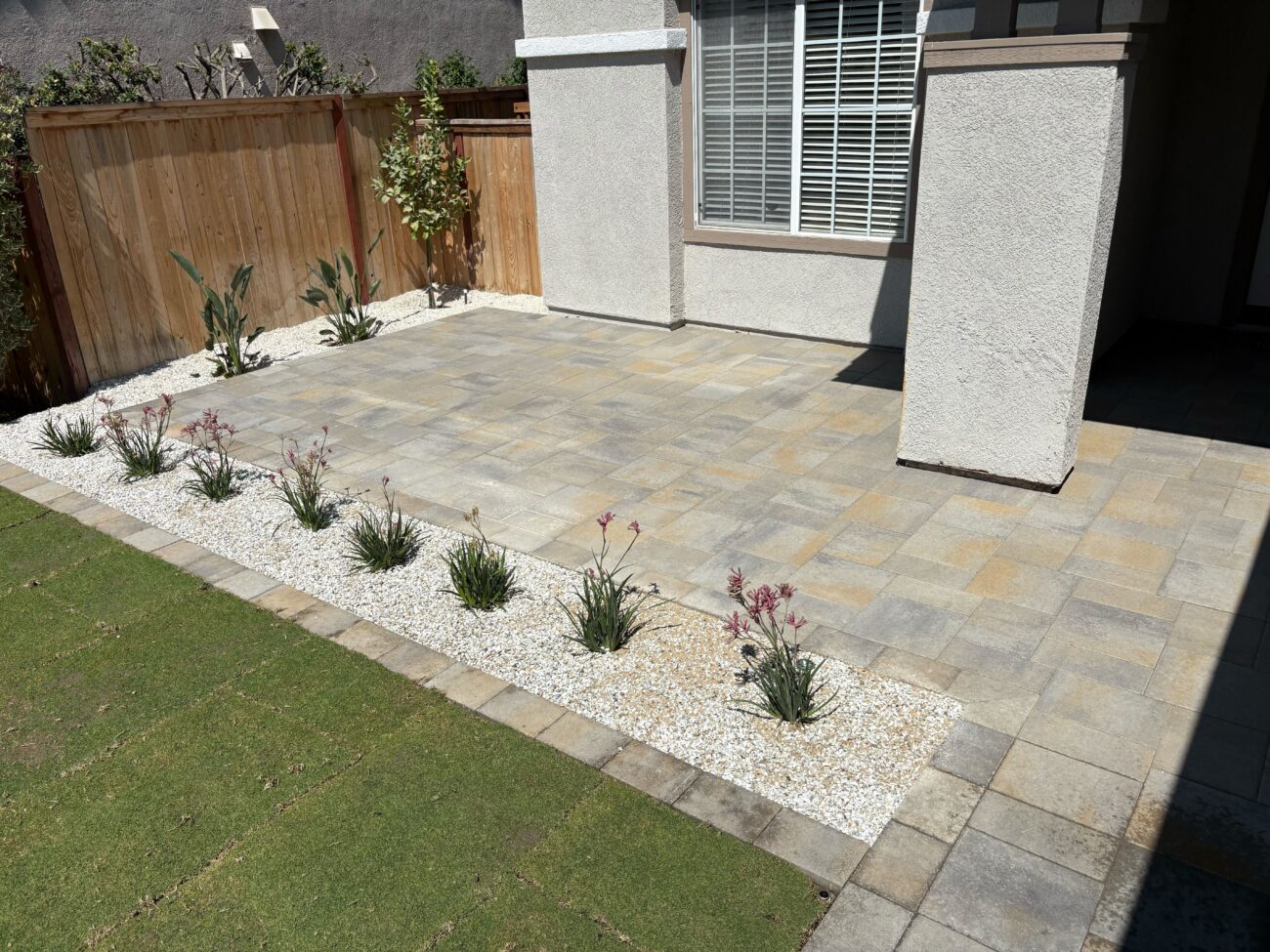

Finished interlocking paver patio adjacent to a stucco house with a paver border and a narrow decorative gravel planting strip containing drought-tolerant plants. San Marcos project by Install It Direct.
AFTER

Design & Build

The Plan

  • Layout strategy centered on connecting the driveway to the home entry with Victorian-pattern pavers, while creating a separate patio zone in the backyard

  • Material selection featured Belgard Catalina Grana Large 3PC and Dimensions 6×9 Border pavers in Victorian style, complemented by gray Bastione walls with mocha-colored caps

  • Drainage design included 65 LF of 3-inch perforated pipe with pop-up drain outlet, testing existing connections before installation to ensure proper function

  • Irrigation plan incorporated new valve installation, relocated existing sprinkler heads, and capped 15 existing lines to accommodate the new hardscape layout

See the 2D plan drawing

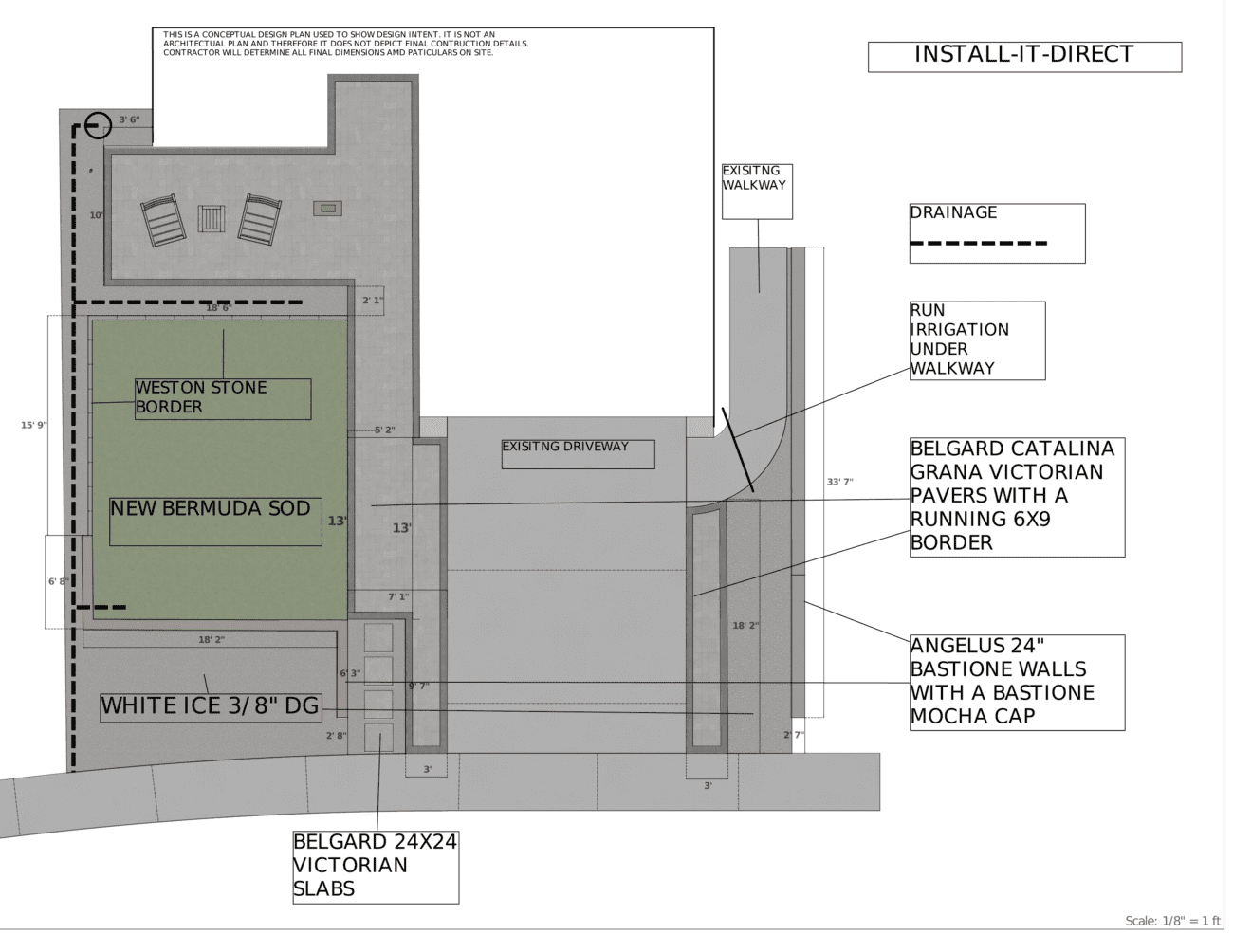

Project plan

The Build

Demo and Site Preparation

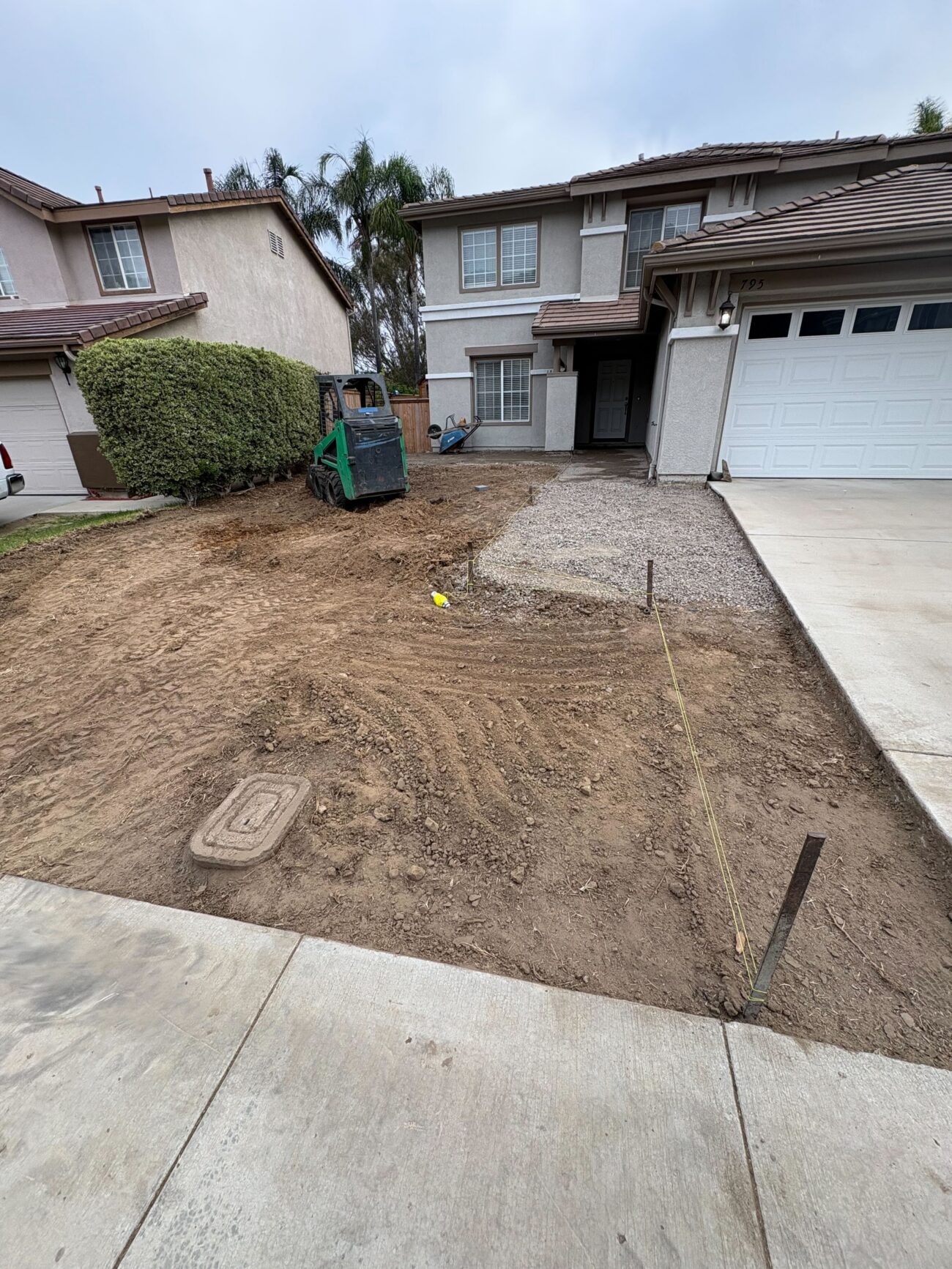

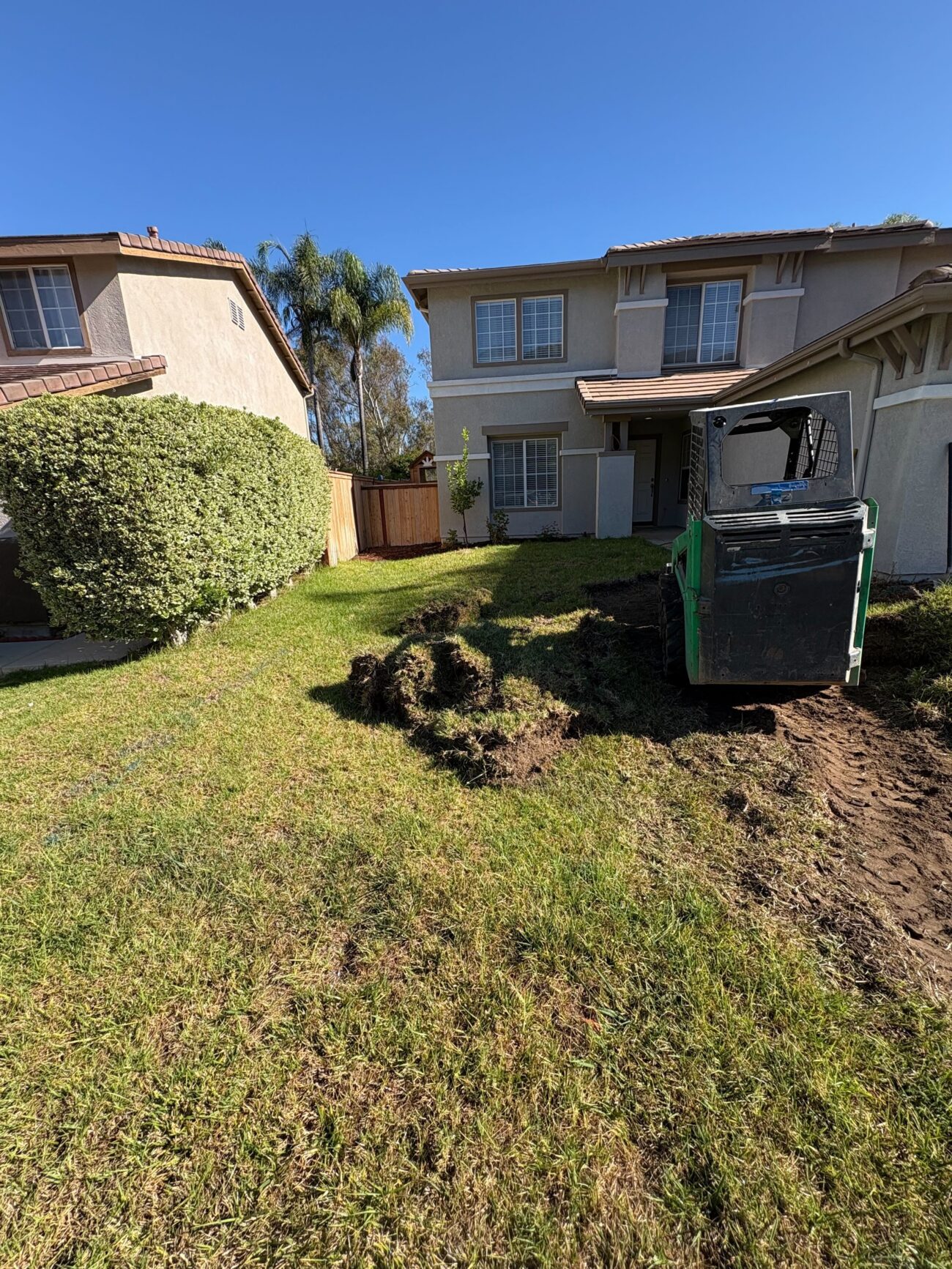

Day 1-2: Demolished existing soil and walkways, excavated for new base preparation. Demo included removal of 2 inches of soil across 955 total square feet of project area.

Drainage and Base Installation

Day 3-4: Installed 65 LF of perforated drainage pipe, tested connections to existing outlets. Prepared base with extra 2-inch depth increment and proper compaction.

Wall and Paver Installation

Day 5-7: Installed 150 sf of Bastione wall blocks with bond beam reinforcement, followed by Victorian-pattern paver installation with NextGel polymeric sand jointing.

Landscaping and Final Details

Day 8-9: Installed 390 sf of Bermuda sod, completed irrigation modifications, and final site cleanup with decorative rock placement.

Investment

What would a similar project cost in San Marcos?

Toggle components on/off to estimate your project

Pavers and Hardscape (555 sf) $18,000 – $22,000
Retaining Walls (150 sf) $4,000 – $4,500
Drainage System (65 LF) $1,000 – $1,500
Landscaping and Sod (390 sf) $2,000 – $2,500
Demo and Site Work $6,500 – $8,000
Estimated Total

Frequently Asked Questions

How much does a paver patio with retaining walls cost in San Marcos?

This 555 sf paver project with 150 sf of Bastione walls and comprehensive drainage invested $33,000-$41,000. Costs depend on paver selection, wall height, drainage requirements, and site access. Victorian-pattern Belgard pavers with engineered wall systems represent the premium end of the market.

Do retaining walls require permits in San Marcos?

Walls exceeding 3 feet in height typically require building permits. This project's Bastione walls were designed within standard height limits. Wall permitting depends on exposed height, surcharge loads, and proximity to property lines.

What maintenance do Victorian pavers require?

This installation used NextGel polymeric sand for joint stabilization, which reduces weed growth and ant intrusion. Annual cleaning and occasional sand touch-ups maintain the Victorian pattern. The Bastione walls require minimal maintenance with proper drainage behind them.

How long does paver and wall installation take?

This Discovery Hills project took approximately 2 weeks from demo to completion. Timeline factors include drainage testing, material delivery coordination from multiple suppliers, and weather. Complex drainage connections and wall installations require additional time for proper execution.

Your Outdoor Project in 3 Simple Steps

1

Design

We listen to your vision, assess your space, and create a custom design that fits your lifestyle and budget.

2

Build

Our experienced crews bring the design to life with premium materials and expert craftsmanship.

3

Enjoy

Step into your transformed outdoor space and start making memories with family and friends.

Your Project Manager

Troy MacMillan

Install It Direct specializes in comprehensive outdoor transformations that integrate hardscape, drainage, and landscaping into cohesive designs. Our San Marcos projects reflect the community's preference for quality materials and thoughtful execution.

Ready to Transform Your Outdoor Space?

Let's discuss your project and bring your vision to life.
