Curved Flagstone Retreat in Bostonia, El Cajon

Curved Flagstone Retreat in Bostonia, El Cajon

This finished project was a $17k–$21k build.

Project Snapshot

Location Bostonia, El Cajon (92021)
Style Traditional
Timeline About 17 build days (2.5 weeks)
Price Range $17k–$21k

• 481 sq ft Belgard 60mm Mega Arbel flagstone-pattern pavers
• 126 sq ft Belgard Dimensions 6×9 border pavers in standard colors
• 607 sq ft total paver installation area
• 52 LF mow strip with standard pavers set in concrete
• NextGel polymeric sand in tan (50lb bags)
• Retaining wall system with landscape boulder accents

10 LF of 3-inch SDR35 perforated drain line with PVC pop-up drain outlet. System includes 45° and 90° PVC elbow fittings for proper water flow direction. Drainage designed to manage surface water and prevent pooling around patio areas.

17 calendar days from install start (Day 1) to final completion. Work progressed through excavation, drainage installation, paver delivery coordination, installation, and final finishing. Perfect site access contributed to efficient material handling and crew productivity.

Project Story

Overview

IID transformed a bare soil backyard into a curved 607 sq ft paver patio with flagstone-pattern Belgard pavers, retaining walls, and integrated drainage - completed in about 2.5 weeks with perfect access and no complications.

The Challenge

  • The backyard was mostly bare soil with no usable hardscape surface for entertaining or outdoor activities
  • The existing yard had drainage concerns that needed to be addressed during the renovation
  • The space lacked defined outdoor living areas and proper transitions between different zones

What Changed

The transformation created 607 sq ft of functional outdoor living space with curved flagstone-pattern pavers and defined borders. The integrated drainage system with 10 LF of pipe and pop-up drain eliminates water management issues, while the new retaining walls create attractive terraced levels throughout the space.

How INSTALL-IT-DIRECT Helped

The homeowner was dealing with an unusable backyard that was mostly bare soil, making it impossible to enjoy outdoor activities or entertain guests. IID designed a curved paver patio using Belgard Mega Arbel flagstone pavers with contrasting Dimensions 6x9 borders to create visual interest and define the space. The team added proper drainage infrastructure and retaining walls to manage water flow and create functional terraced areas. Perfect site access allowed for efficient material delivery and installation, resulting in a smooth project completion with no delays or complications.

Over 1,000 five-star reviews and 1,500+ San Diego homeowners served.

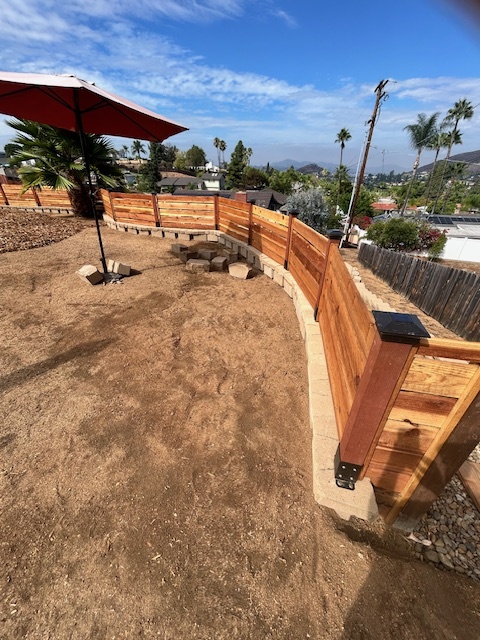

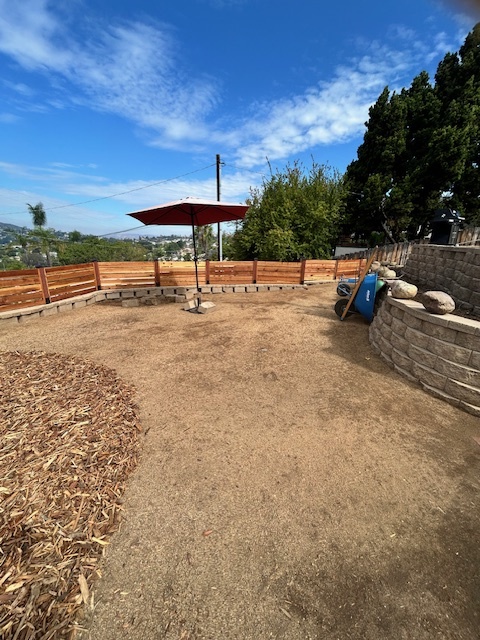

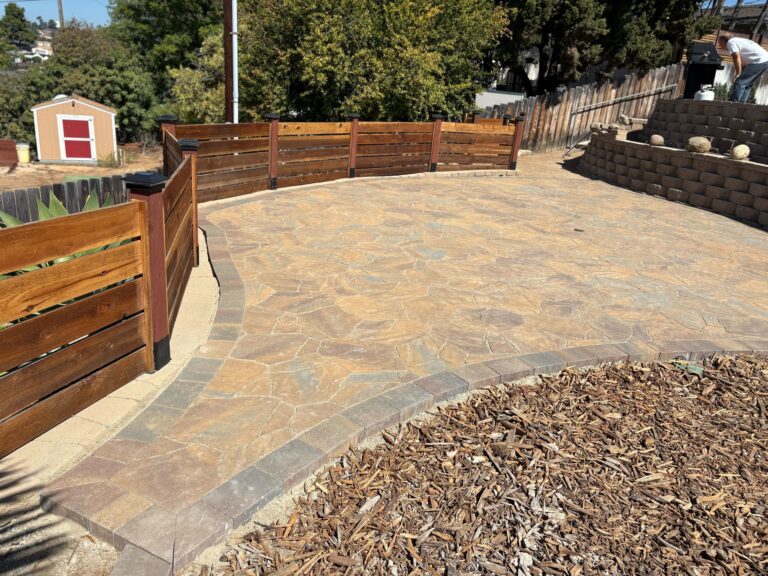

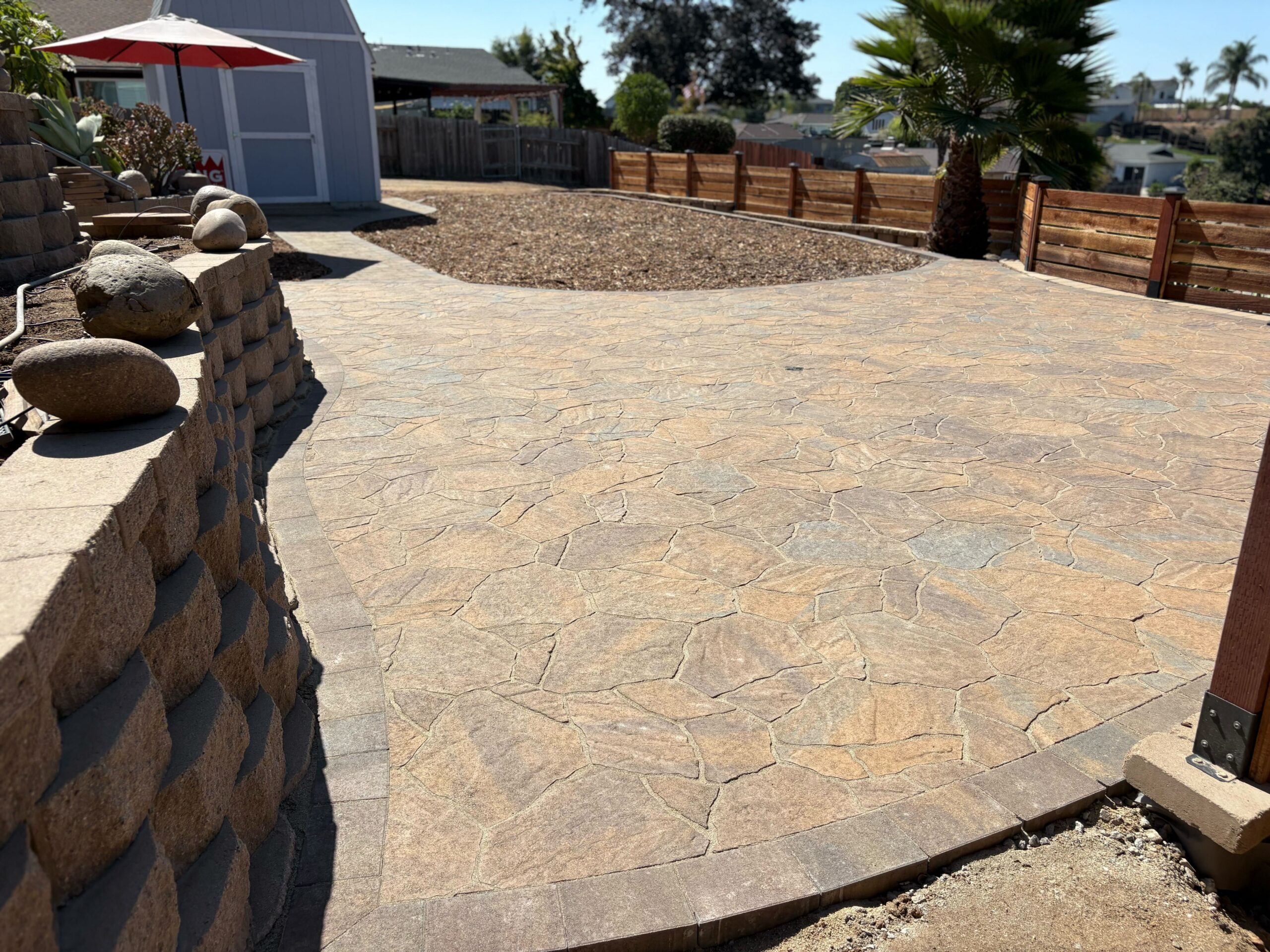

after photo showing pavers, retaining wall, wall in El Cajon. Install It Direct project.

Design & Build

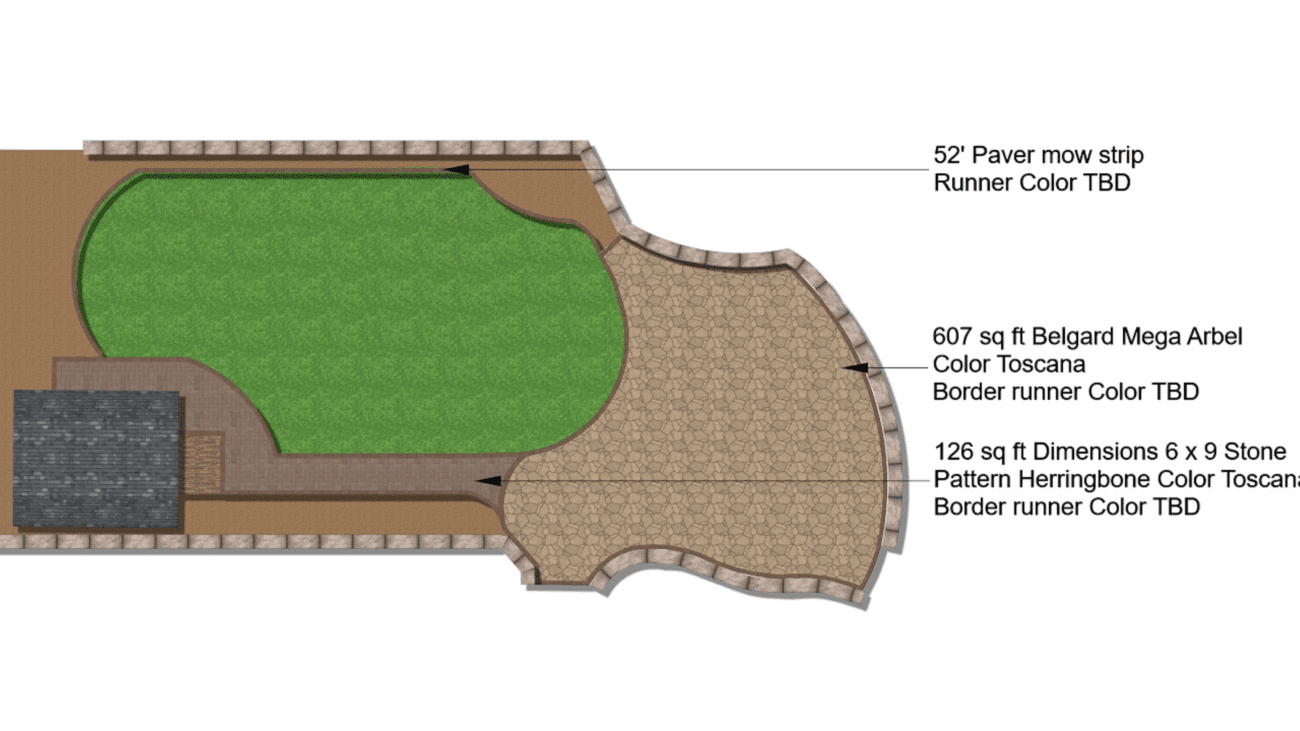

The Plan

  • Curved patio layout using Belgard 60mm Mega Arbel flagstone pattern pavers in earth tone blend for traditional aesthetic

  • Contrasting Belgard Dimensions 6×9 border pavers in standard colors to define patio edges and create visual definition

  • Drainage system with 10 LF of 3-inch SDR35 drain line and PVC pop-up drain with 45° and 90° fittings for proper water management

  • Retaining wall system to create terraced levels and manage grade changes throughout the space

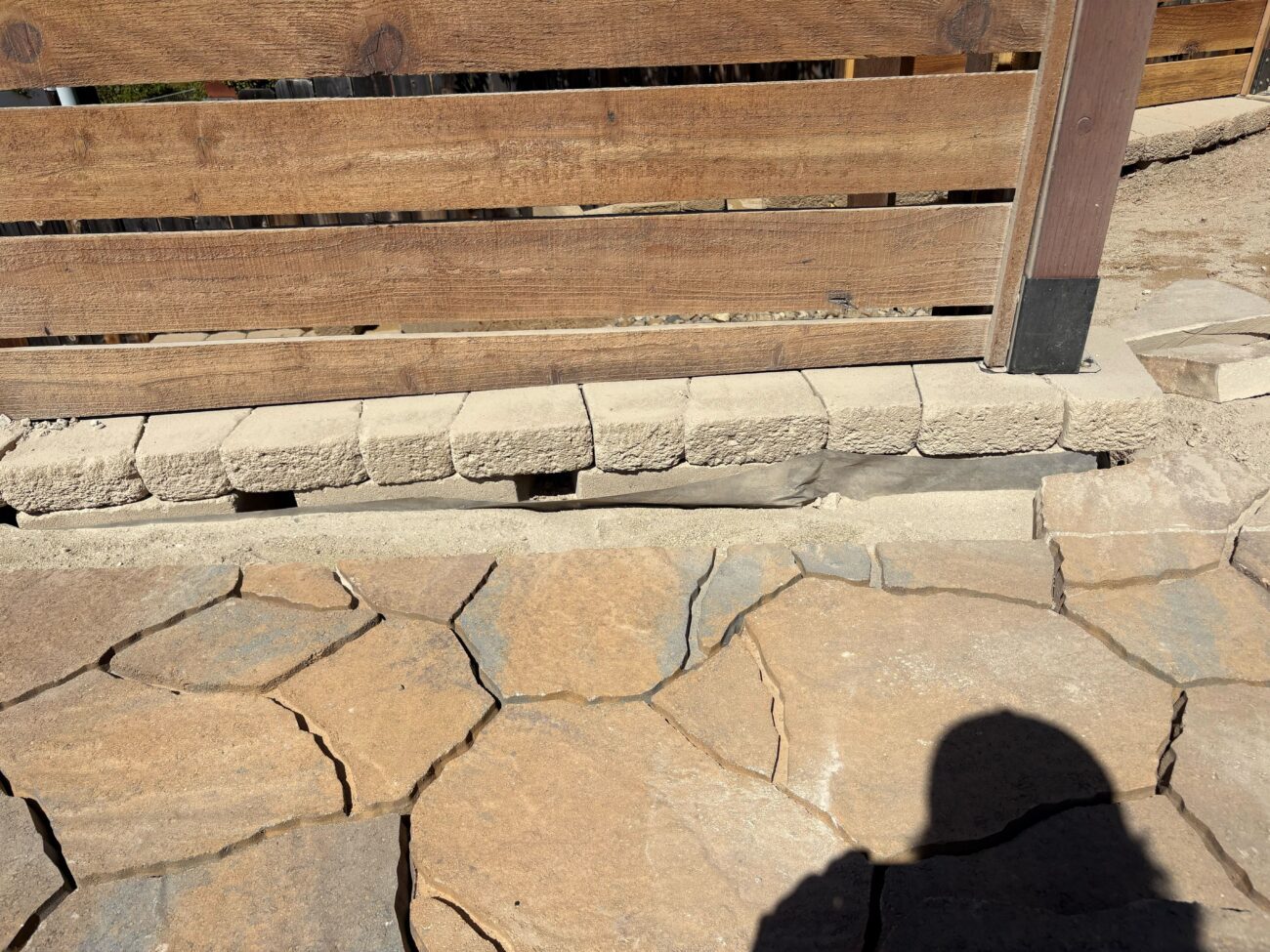

  • 52 LF concrete-set mow strip using standard pavers on edge for clean landscape transitions

  • NextGel polymeric sand in tan color for joint stabilization and weed prevention

The Build

Excavation and Base Preparation

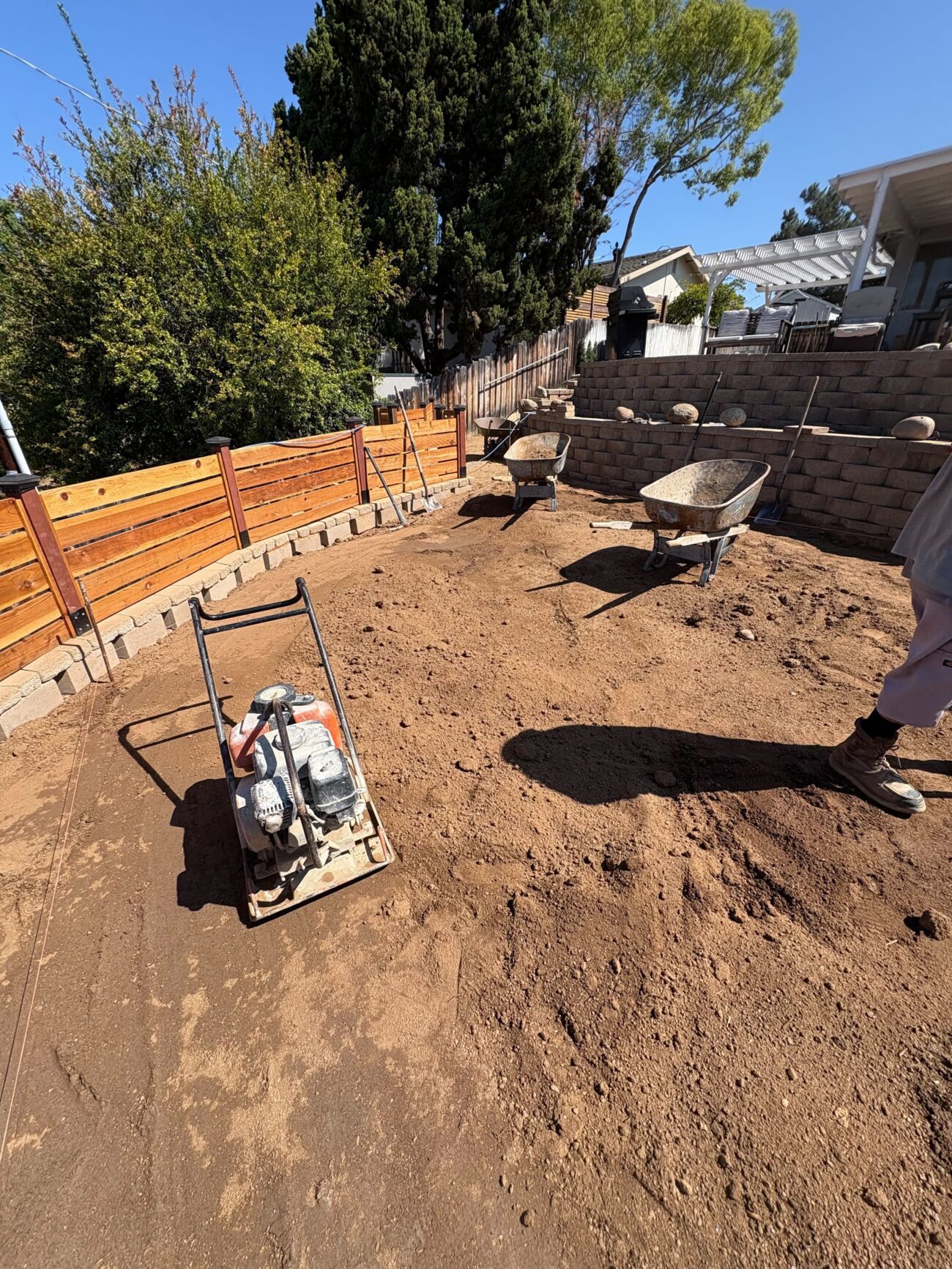

Demo of existing conditions followed by 7.5-inch excavation depth for paver installation. Native soils compacted to proper density with fabric installed against walls to prevent sub base material from slipping into wall cracks.

Drainage and Infrastructure

Installation of 3-inch SDR35 drain line with PVC pop-up drain and elbow fittings. Drainage system coordinated with paver excavation and base preparation phases.

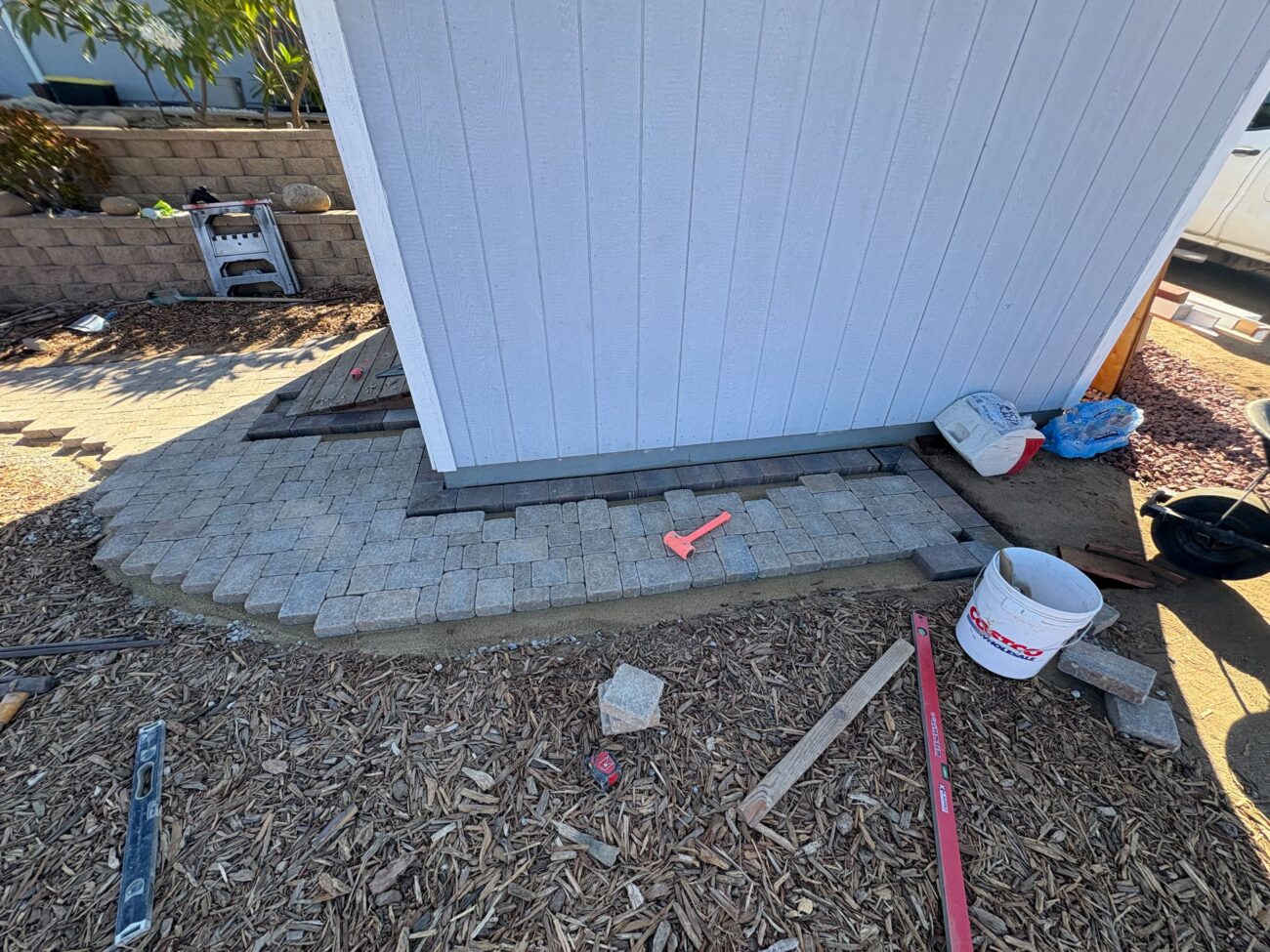

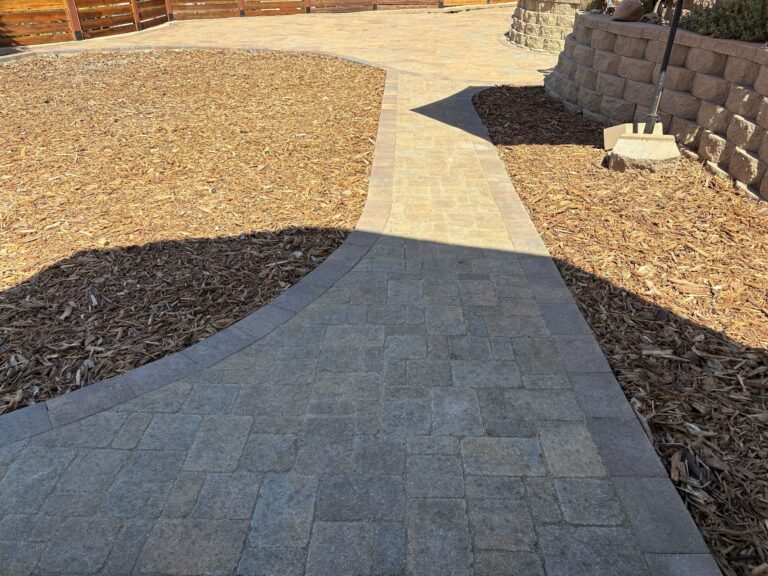

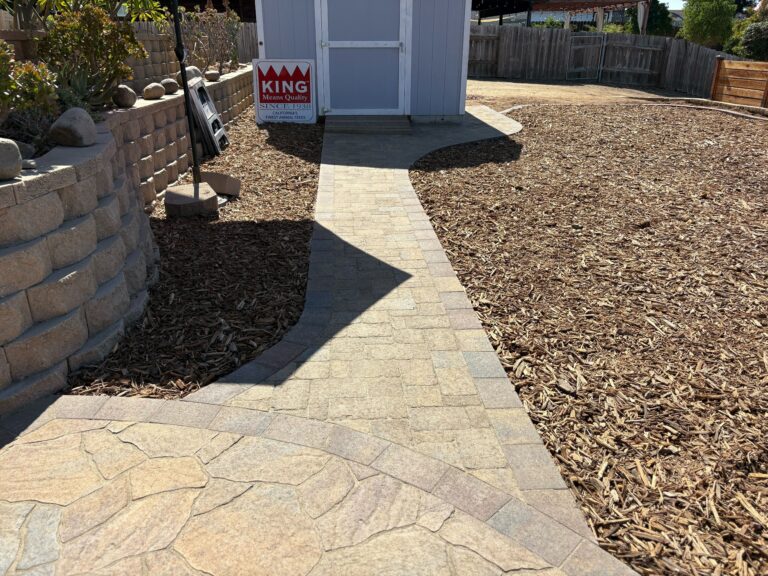

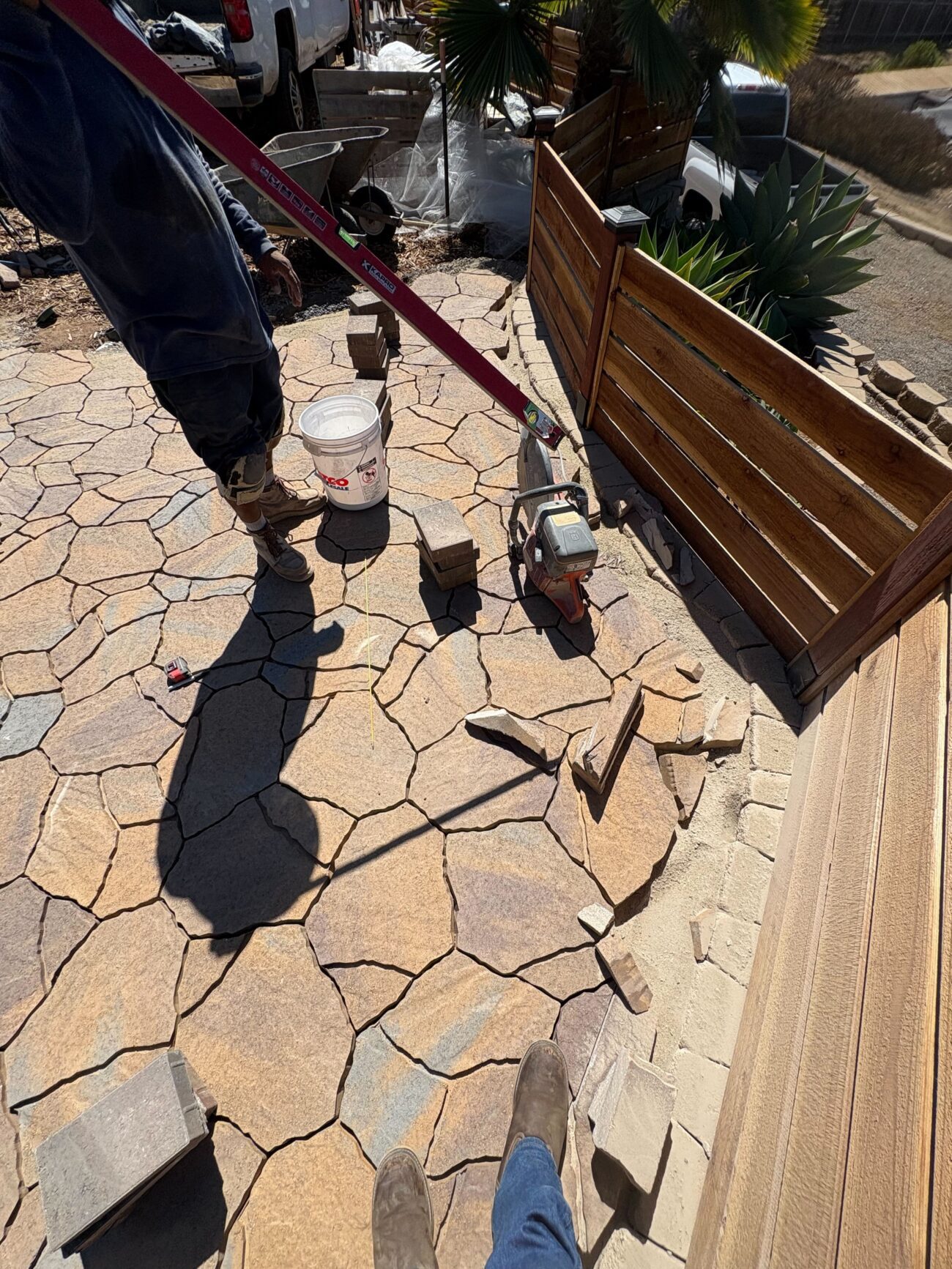

Paver Installation and Finishing

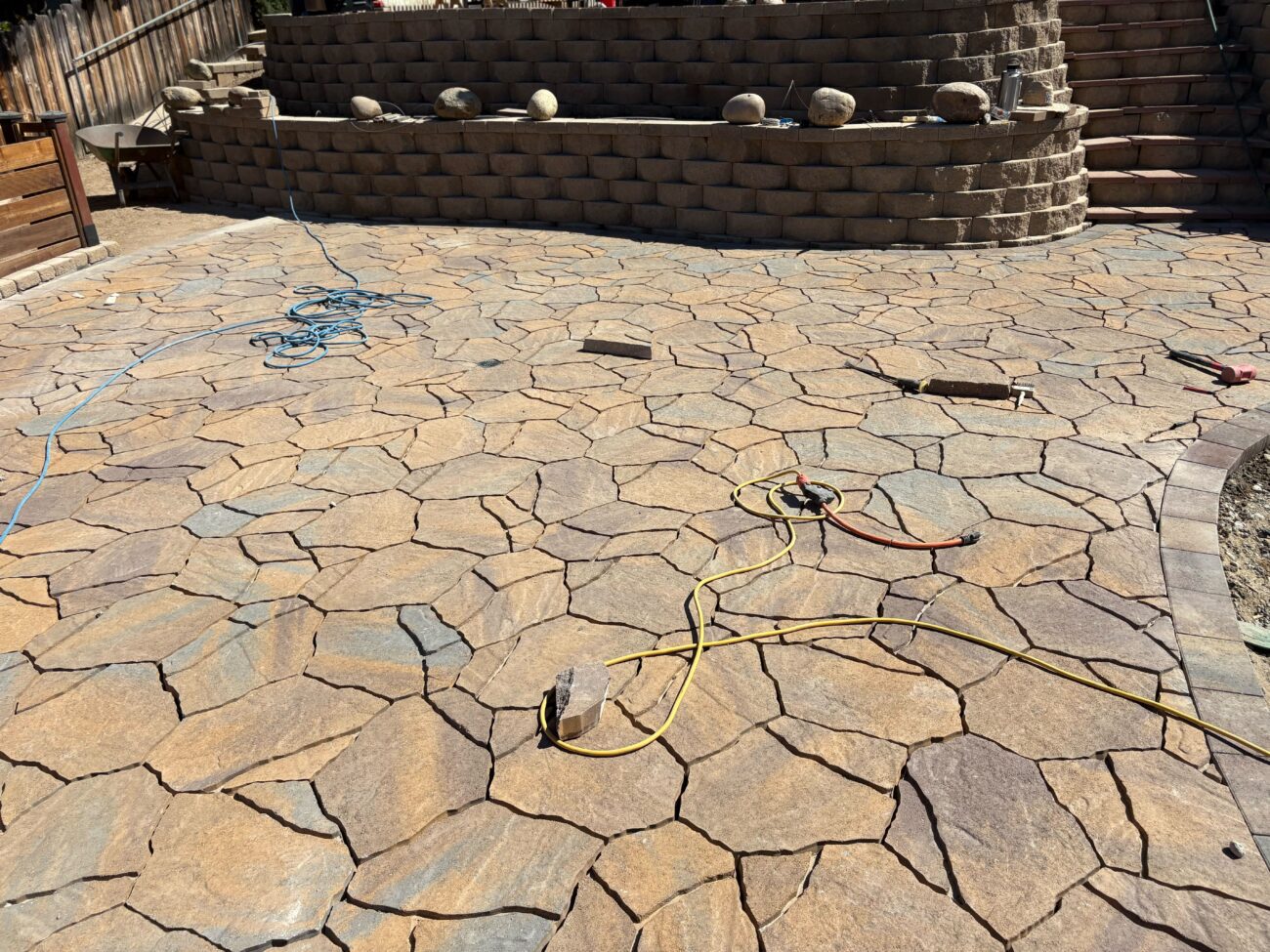

Delivery and installation of Belgard Mega Arbel and Dimensions border pavers. Mow strip installation with concrete setting. NextGel polymeric sand application and final surface preparation.

Investment

What would a similar project cost in El Cajon?

Toggle components on/off to estimate your project

Pavers & Hardscape (607 sq ft) $11,500 – $14,000
Drainage System $1,000 – $1,500
Demo & Site Work $3,000 – $3,500
Delivery & Materials $2,000 – $2,500
Estimated Total

Frequently Asked Questions

How much does a 607 sq ft paver patio cost in El Cajon?

Based on this Bostonia project, a curved flagstone paver patio of this size with drainage and retaining walls invested approximately $17,000-$21,000. The final cost depends on paver selection, drainage requirements, site access, and additional features like mow strips or walls.

Do I need permits for a paver patio in El Cajon?

Paver patios at grade typically don't require building permits. However, this project included retaining walls which may require permits if over 3 feet in height. Drainage connections and grading over 200 cubic yards may also trigger permit requirements.

How does polymeric sand help with paver maintenance?

NextGel polymeric sand used in this project hardens when activated with water, creating stable joints that resist weed growth and ant infiltration. It provides better long-term performance than regular masonry sand while maintaining flexibility for thermal movement.

What's the advantage of Belgard Mega Arbel pavers over other options?

Mega Arbel pavers provide a natural flagstone appearance with the durability and consistency of manufactured concrete pavers. The 60mm thickness provides excellent strength, while the random flagstone pattern creates visual interest without the maintenance issues of natural stone.

How long does paver patio installation take in El Cajon?

This 607 sq ft curved patio with drainage took 17 build days to complete. Timeline depends on total square footage, excavation depth, drainage complexity, and site conditions. Perfect access contributed to faster completion on this project.
