Pavers Around the House with Drainage and Lighting in Aviara, Carlsbad
This finished project was a $37.5k-$42.5k build.
Project Gallery

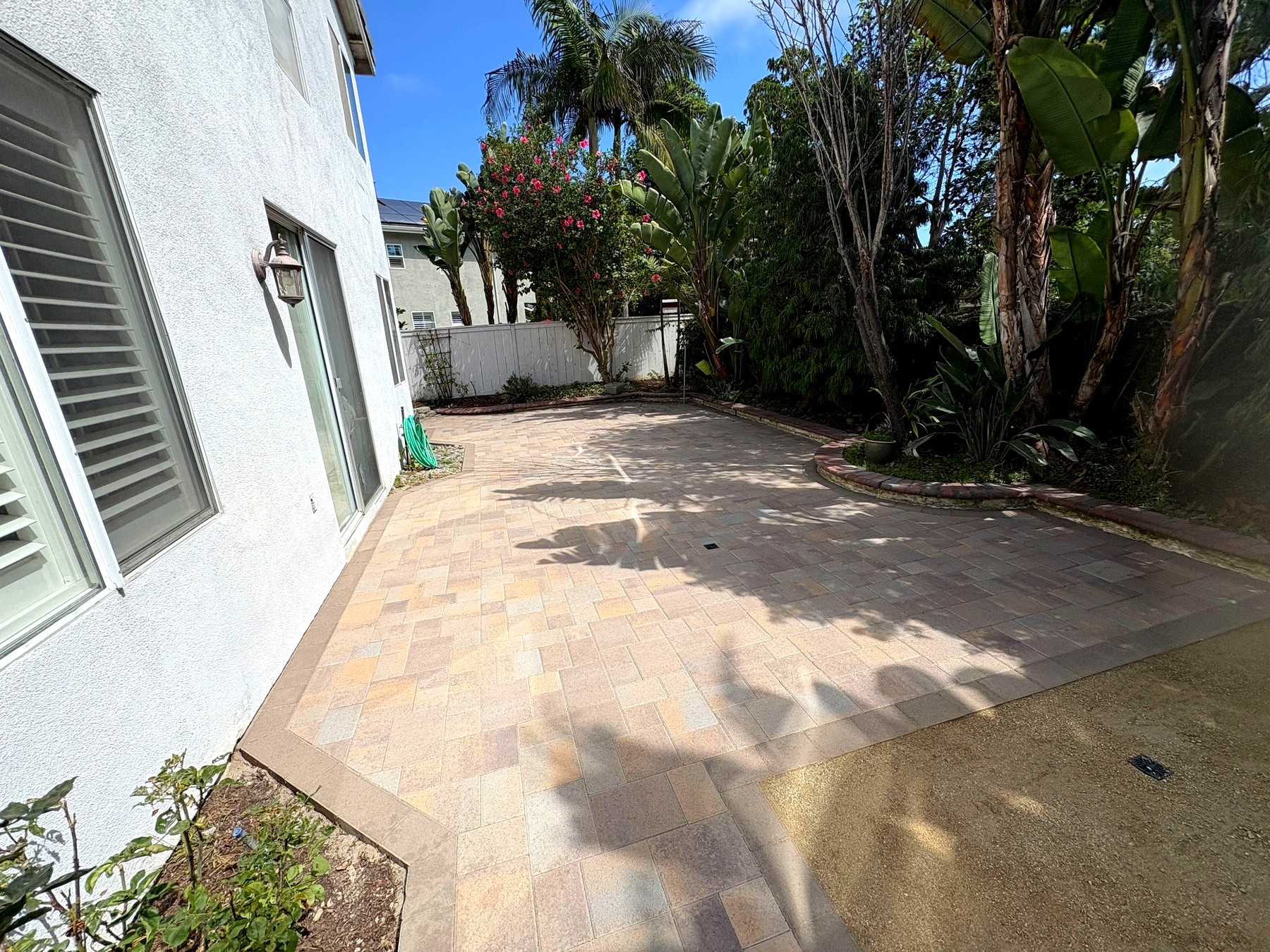

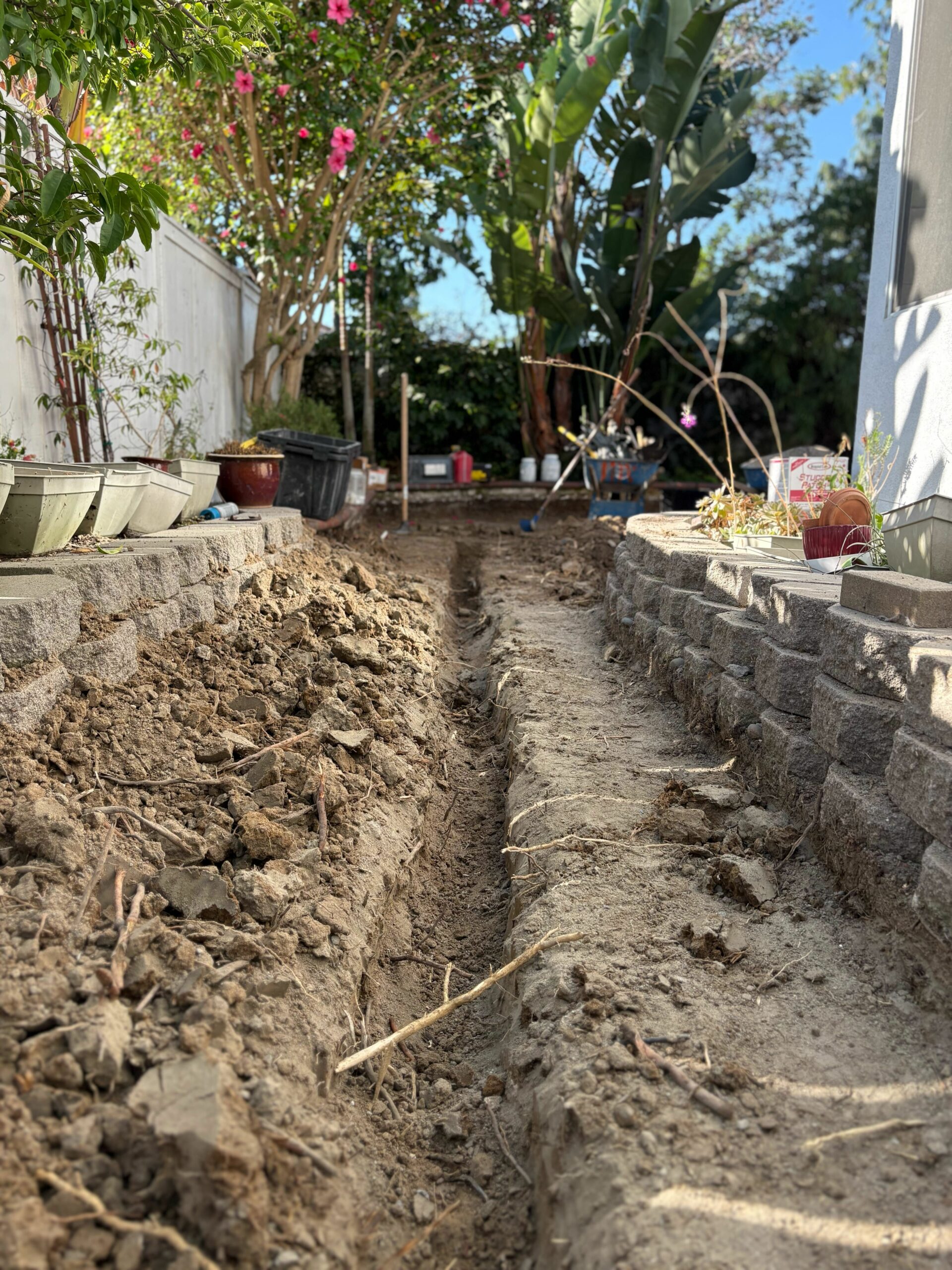

The paver field runs to the decomposed granite corner inside the border; a drain inlet sits in the DG and another in the pavers.

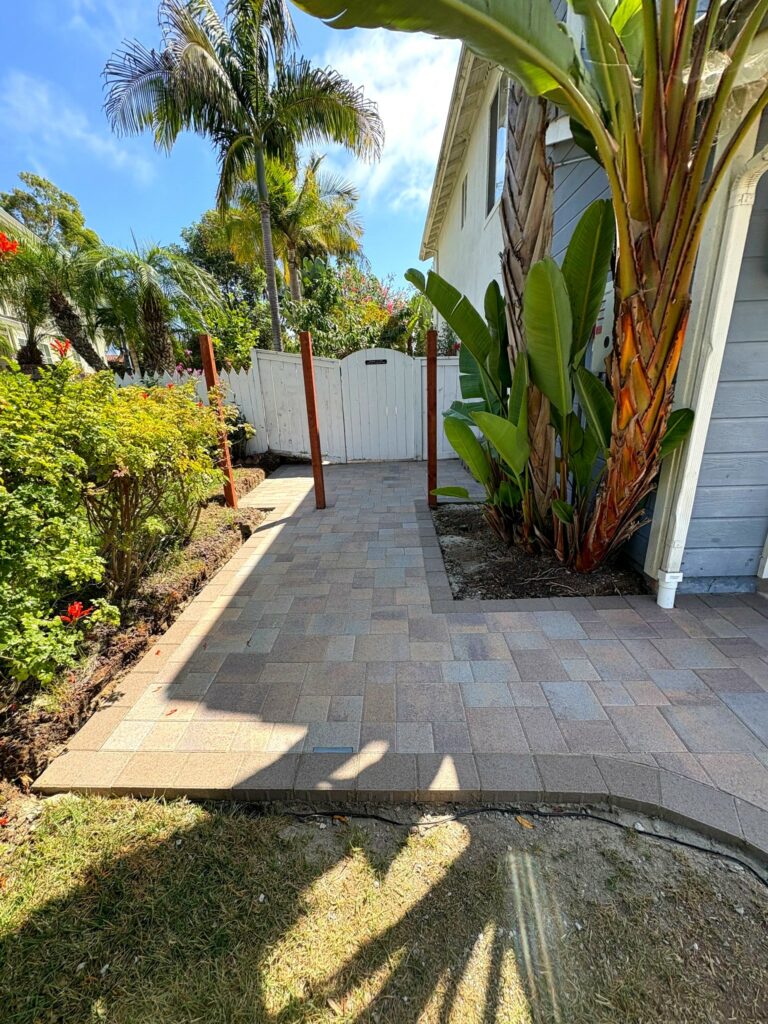

The paving narrows into the walkway along the house; the rose beds were kept and their irrigation reset.

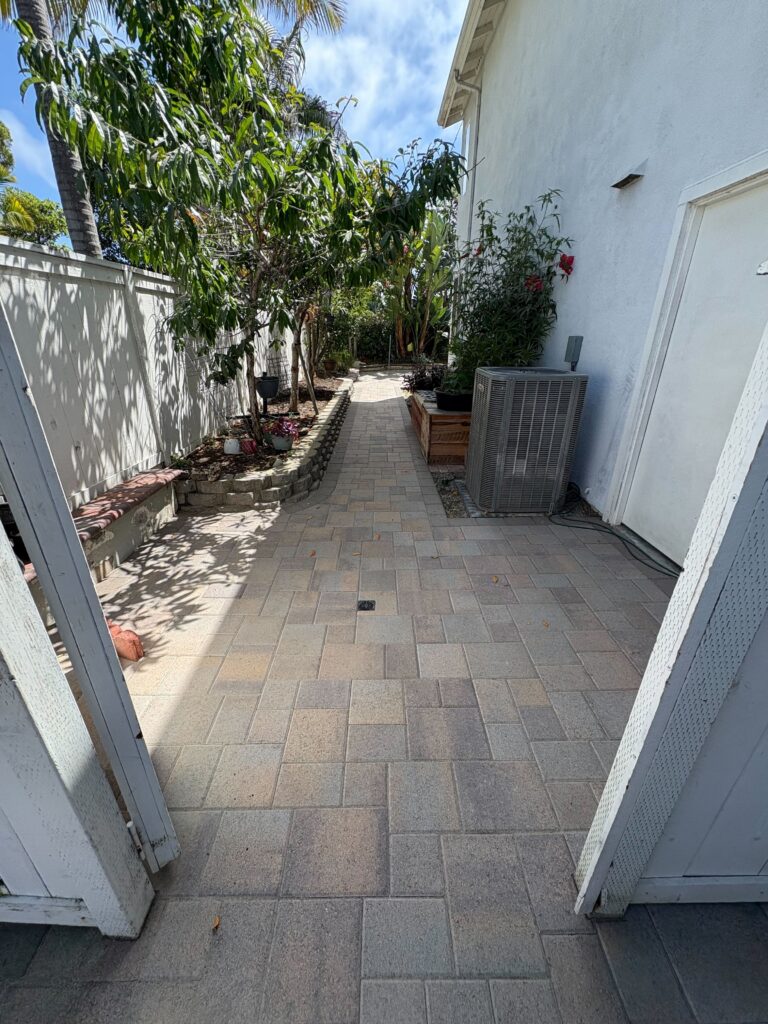

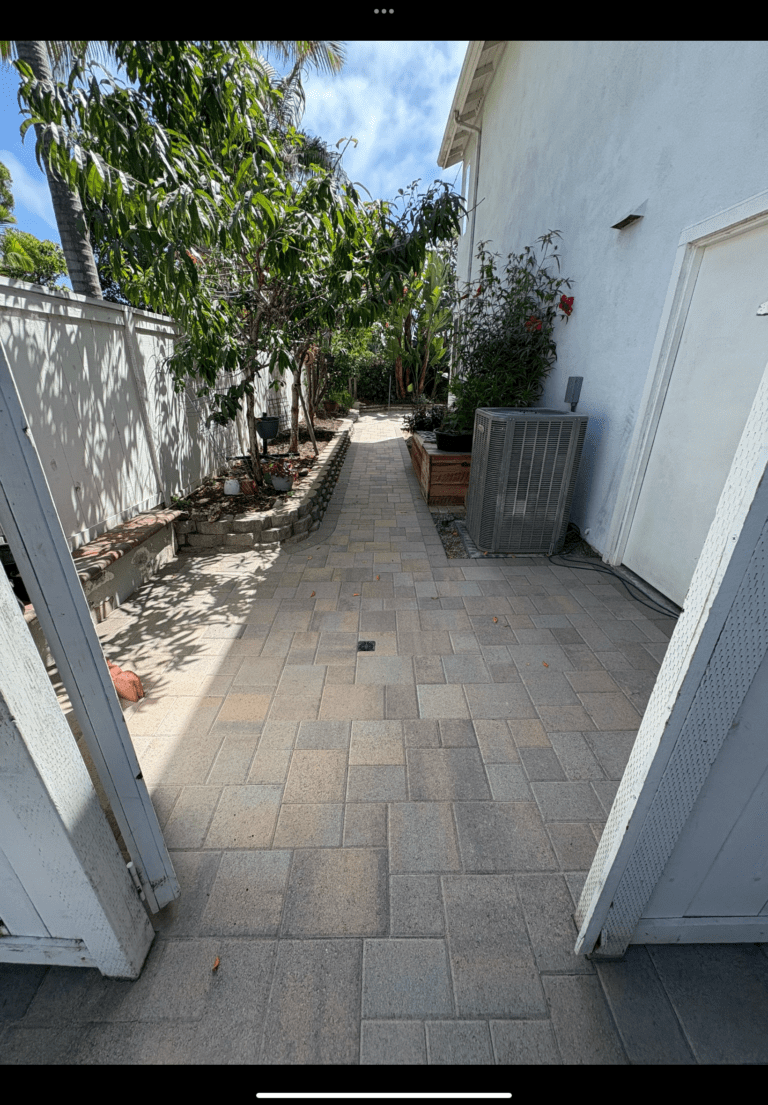

The other side yard, paved from gate to gate and fitted around the condenser, with a drain inlet in the field.
Project Snapshot
Project Story
Overview
In the Aviara neighborhood of Carlsbad, 92011, the crew took out 282 square feet of old brick, clay and tile paving set in concrete, cut back the existing concrete where it stayed, and laid 1,176 square feet of Angelus Courtyard Combo pavers: a back patio against the house, both side yards from gate to gate, and a walkway strip beside the driveway to the front. Under and beside it went 125 feet of 3-inch drain line with 12 inlets and downspout connections, one branch extended so the spa can drain into it, 72 feet of conduit, and 13 paver lights on a 150-watt transformer and a timer. 188 square feet of decomposed granite finishes the back corner, eight sprinkler heads were capped and five moved, and new posts were set for the side gate. Nine working days, August 25 to September 5, 2025. $37.5K to $42.5K.
The Challenge
- The ground around the house was a patchwork of brick, clay and tile set in concrete, a concrete patio, lawn and shrubs, with no one surface from the front to the back.
- The downspouts and the paving had no piped route for water away from the house, and the spa had nothing to drain into.
- A goldfish pond in the side yard sat in the middle of the demolition and the paver cutting.
What Changed
How INSTALL-IT-DIRECT Helped
Over 1,000 five-star reviews and 1,500+ San Diego homeowners served.
Design & Build

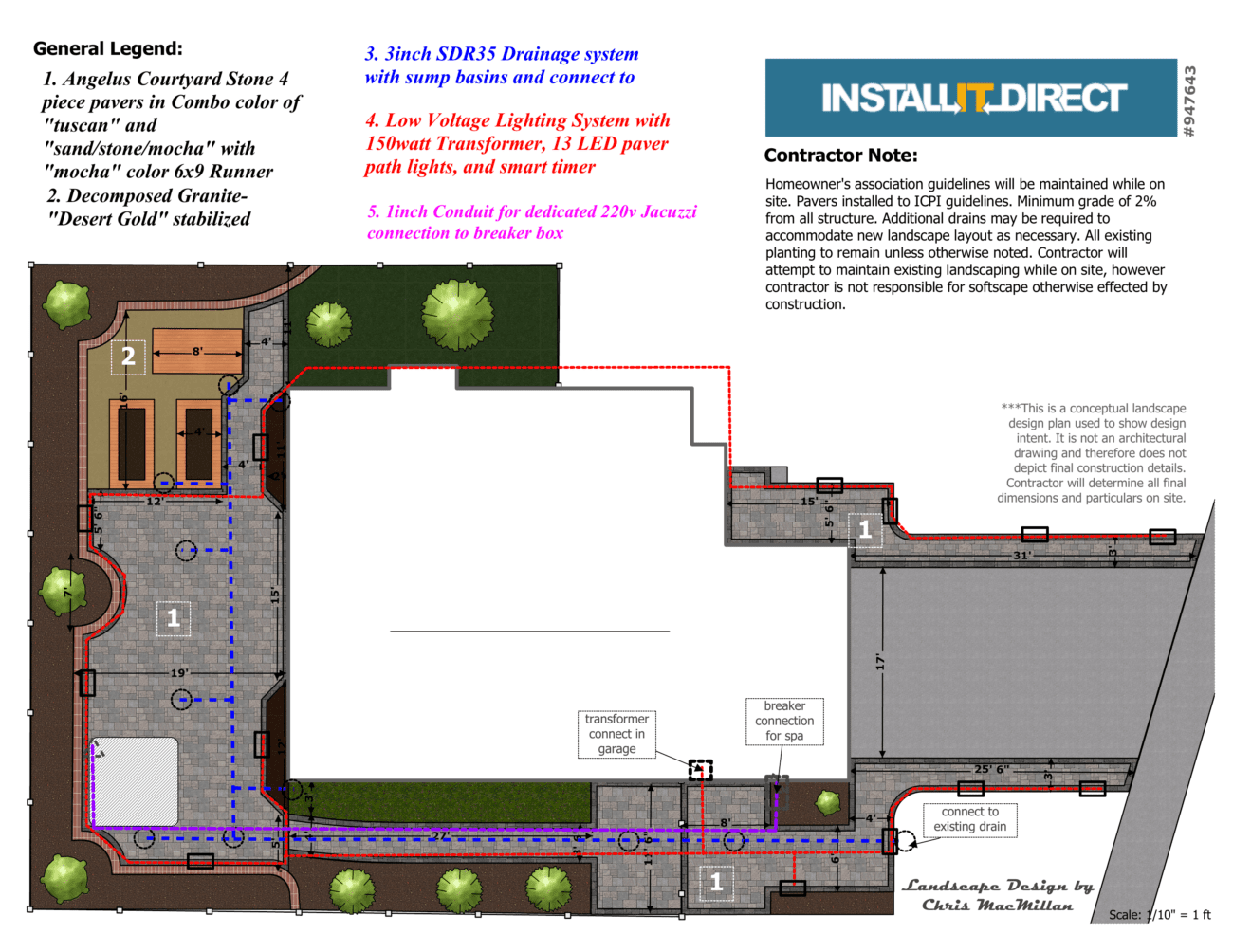

The Plan
Pavers: Angelus Courtyard Combo 60 mm in one field from the walkway strip beside the driveway, through both side yards, to the back patio, with a soldier border and gray polymeric sand in the joints.
Drainage: a 3-inch SDR35 line along the house with 12 inlets and downspout connections and 15 wyes and tees, and one branch run to the spa so it empties into the same system.
Lighting: 13 paver lights set in the field, their spots flagged and confirmed with the homeowners on site before the last rows went down, on a 150-watt transformer and a smart timer fed through 72 feet of conduit.
Ground plane: 188 square feet of Desert Gold decomposed granite in the back corner inside the paver border, with a drain inlet set in it.
Irrigation: eight heads capped where the paving took the lawn, five moved and one valve relocated so the beds that stayed still run.
Fence: new posts set for the side gate; the fence panels were not part of this contract.
The Build
Demolition

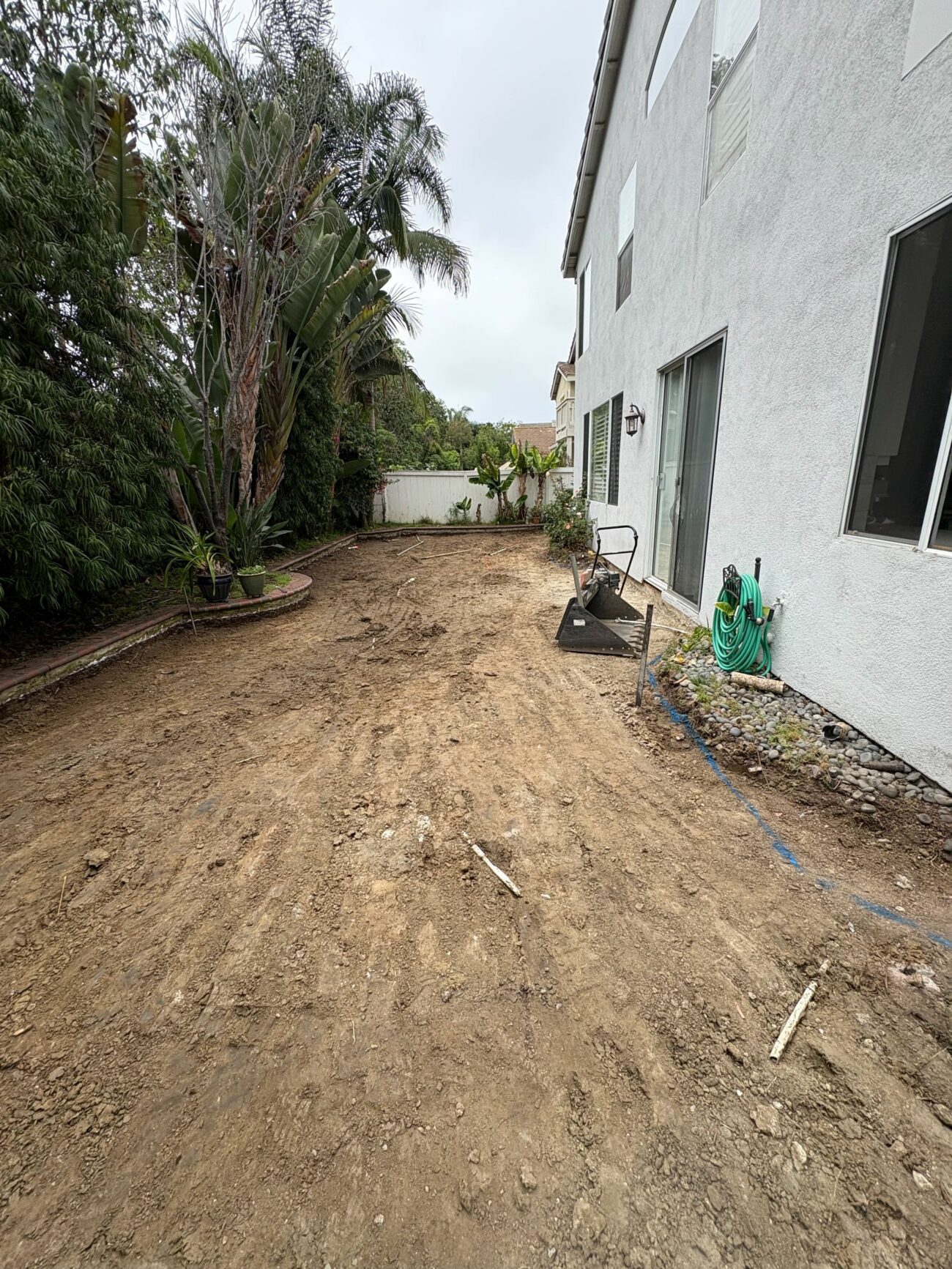

Work started Monday, August 25, 2025. The old brick, clay and tile paving came out of its concrete bed, the shrubs and lawn in the way were hauled off with two yards of soil, and the areas were excavated 7.5 inches and more for base. The goldfish pond stayed covered through the demolition.
Drainage, conduit and irrigation
On August 27 the 3-inch drain line went in along the house with its inlets and downspout connections, one branch extended to take the spa drain, and 72 feet of conduit was laid for the lighting. The irrigation was capped where the lawn had been, moved where the paving needed it, and tested again before any base went down.
Base and pavers

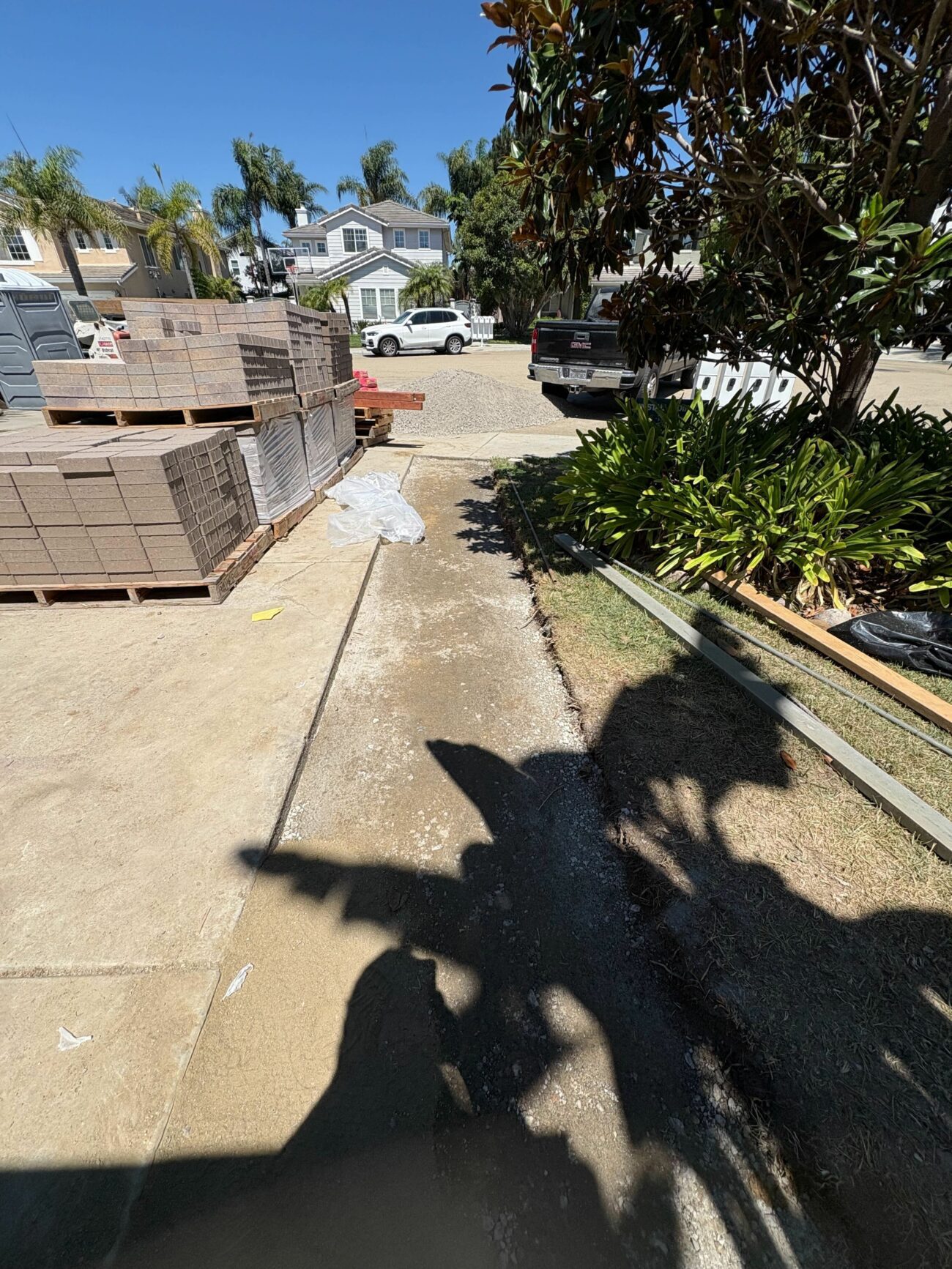

The base was placed and compacted on August 28; light rain held the first pavers to the next morning. The Angelus Courtyard Combo field was laid from August 29 to September 4, the light locations were flagged and confirmed with the homeowners on September 2, 22 feet of existing concrete was sawcut for a clean edge, and gray polymeric sand was swept in and compacted.

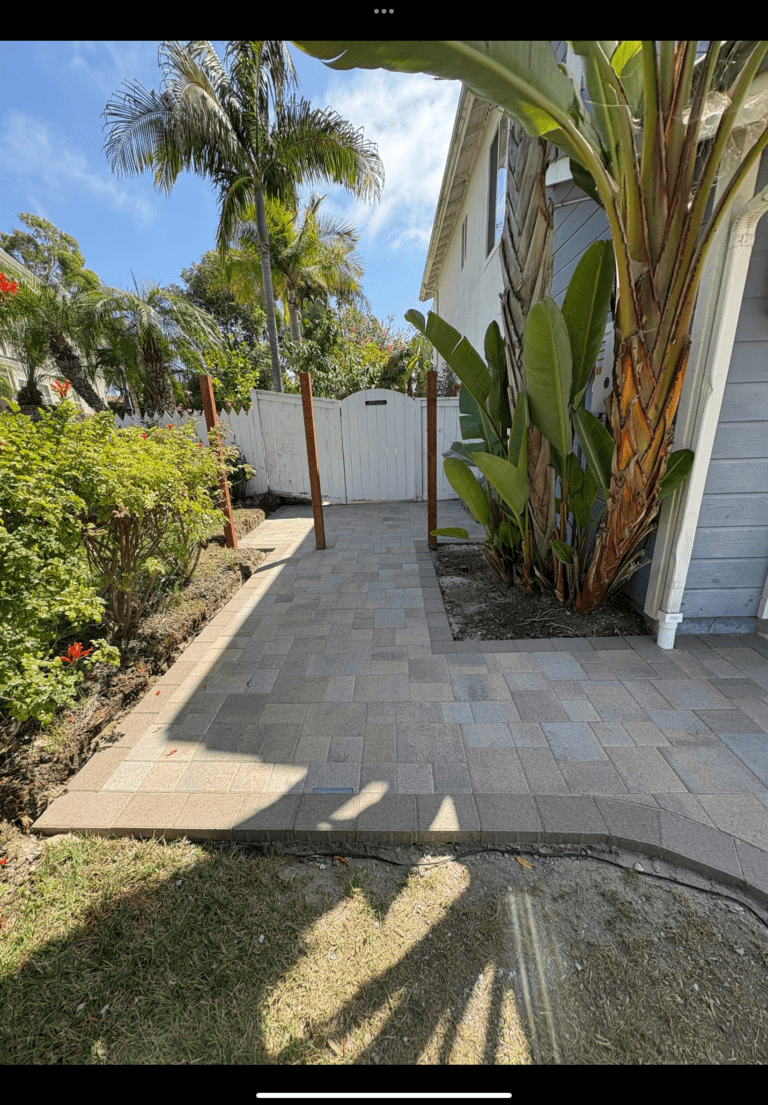

Decomposed granite, posts and close-out
The decomposed granite went down on September 3 and 4, the gate posts were set, and the punch list was walked on September 4. The final walk, the completion certificate and the final payment were Friday, September 5; the crew took its final photos on September 8.
Investment
What would a similar project cost in Carlsbad?
Toggle components on/off to estimate your project
Frequently Asked Questions
What did this project cost?
$37.5K to $42.5K. The contract was signed at $37.5K and one change order on August 29, 2025 for added drains and the fence posts brought it to $39.2K. That covers the demolition, 1,176 square feet of pavers, the drainage, the lighting, the decomposed granite, the irrigation work and the posts.
Where does the water go?
Into 125 feet of 3-inch SDR35 drain line with 12 inlets and downspout connections along the house. One branch was extended so the spa drains into the same line.
What pavers were used?
Angelus Courtyard Combo 60 mm pavers with a soldier border, set on a compacted base with gray polymeric sand in the joints.
Can pavers go around a pond or an air conditioner?
Yes. Here the side-yard paving runs past a goldfish pond and the condenser; the pond was covered during the demolition and the cutting, and the pavers were fitted around the condenser.
How long did it take?
Nine working days. Demolition started Monday, August 25, 2025 and the final walk was Friday, September 5, with Labor Day off.
